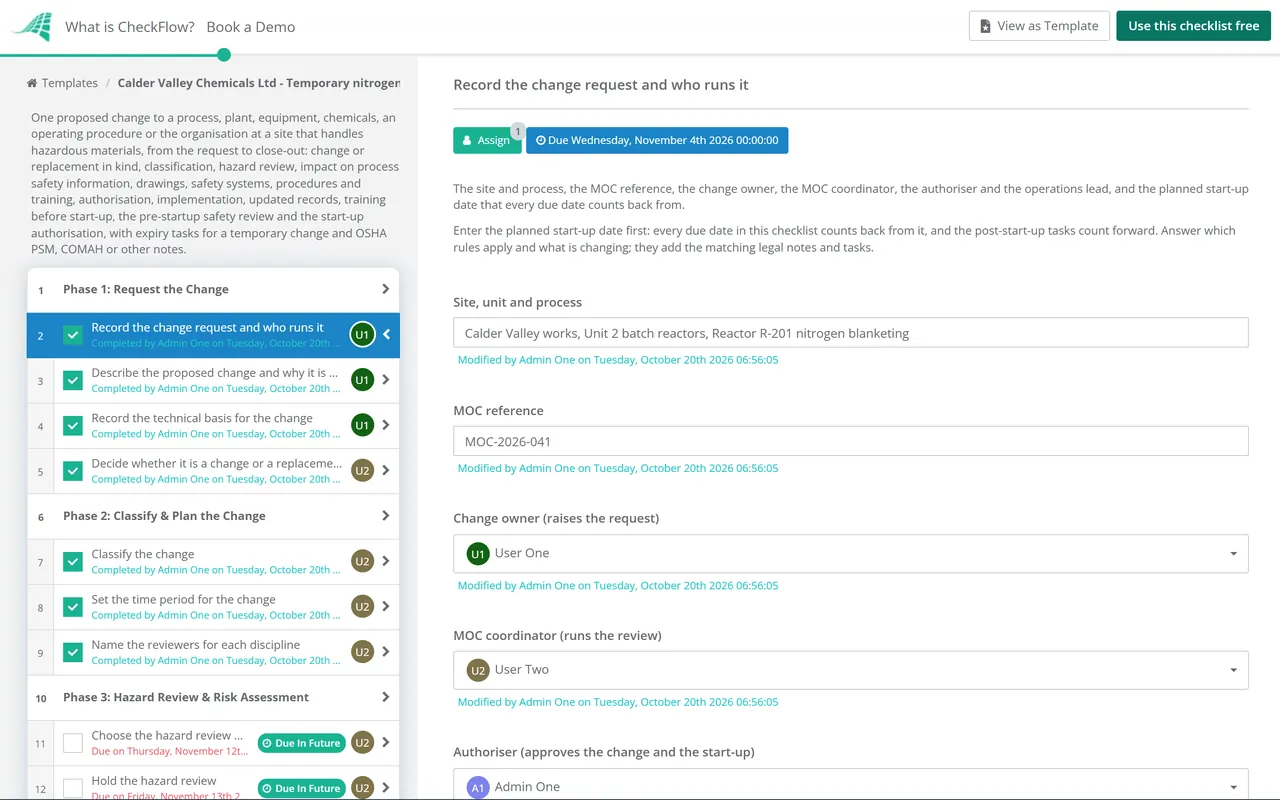

Management of Change (MOC) Checklist Template

A change to a hazardous process can look small and still remove a safeguard: a temporary hose still in place a year later, a relief valve sized for the old duty, or operators who first hear about the change at start-up.

Last reviewed: October 2026

This free management of change (MOC) checklist is for process safety leads, plant and process engineers, operations managers and EHS teams at sites that handle hazardous chemicals. One run is one proposed change to a process, plant, equipment, chemicals, an operating procedure or the organisation, from the request to close-out. It first decides whether the proposal is a change at all or a replacement in kind, then classifies it as permanent or temporary and normal or emergency, runs a hazard review and checks the impact on process safety information, P&IDs, relief and safety systems, procedures and training. The authoriser approves the change before work starts, the records are updated and affected employees and contractors are trained before start-up, and a pre-startup safety review comes before the authorisation to start up. A US, UK or other answer adds the matching OSHA or COMAH notes, and a temporary change adds the tasks that track it to its expiry.

A Process Change Is Not a Product Change or a Work Permit

Management of change asks one question before anything is altered on a hazardous process: what could this change do to the safeguards we rely on? In the US, OSHA’s Process Safety Management standard requires written procedures to manage changes to process chemicals, technology, equipment and procedures, and changes to facilities that affect a covered process, other than replacements in kind. In Great Britain, COMAH requires the safety management system of a major hazard site to address the management of change.

This checklist runs one such change from the request to close-out. It sits beside other kinds of change control, and each answers a different question. Changes to IT systems go through the IT Change Management Process Checklist.

This checklist

A change to the process

Asks: what does this change to chemicals, plant, equipment, procedures or the organisation do to process safety, and is everyone ready before start-up?

When: before any change other than a replacement in kind at a site that handles hazardous materials.

Output: an authorised change, updated process safety information and procedures, trained people and a pre-startup safety review.

Product changes

A change to what you make

Asks: how does a change to a product’s design, bill of materials or routing affect quality, cost and stock?

When: for engineering changes, in the Manufacturing Change Order Process Checklist.

Output: an approved change order, updated documents and dispositioned inventory.

What the Management of Change Checklist Covers

Eight phases follow one change from the request to close-out. A replacement in kind is recorded and closed in Phase 1, and the remaining tasks are marked not applicable. A temporary change adds the expiry tasks in Phase 8, an emergency or organisational change adds its own task in Phase 2, open recommendations add a task to resolve them, a UK answer adds the COMAH task in Phase 5, and the authoriser approves the start-up after the pre-startup safety review.

  1. Phase 1

    Phase 1: Request the Change

    5 tasks

    The change owner raises the request and the MOC coordinator decides whether it is a change at all. A replacement in kind closes here; anything else runs the full procedure. Every due date counts back from the planned start-up date.

    • Record the change request and who runs it — the site and process, the MOC reference, the change owner, the MOC coordinator, the authoriser and the operations lead, and the planned start-up date that every due date counts back from
    • Describe the proposed change and why it is needed — what will be different afterwards, the reason for it, and the equipment, lines, instruments, chemicals or procedures it touches
    • Record the technical basis for the change — the calculations, design codes, manufacturer’s data, test results or engineering reasoning that show the change will work safely
    • Decide whether it is a change or a replacement in kind — compare the proposal with the design specification: a replacement that meets it is a replacement in kind and leaves this procedure, and anything else is a change; the answer decides whether the rest of the checklist applies
    • Record the replacement in kind and close the request — the specification it was checked against, who checked it and the work order it returns to; nothing else in this checklist applies, so mark every remaining task not applicable
  2. Phase 2

    Phase 2: Classify & Plan the Change

    5 tasks

    Classification sets the time period, the depth of the review and who authorises the change. A temporary change adds an expiry date and the tasks that track it; an emergency change adds a record of who authorised it and what was reviewed first.

    • Classify the change — permanent or temporary, normal or emergency, and minor or major under your own procedure, which sets the depth of the hazard review and who must authorise it
    • Set the time period for the change — when the work starts and, for a temporary change, the date it must be removed or made permanent, which the expiry tasks count from
    • Record the emergency authorisation — who authorised the urgent change, what was reviewed before it was made, and when the rest of this review will be finished
    • Assess the organisational change and the transition — the end state and the change-over period, the key tasks and responsibilities to transfer, staffing levels, and training and supervision for people in new roles
    • Name the reviewers for each discipline — operations, process engineering, maintenance, safety and environment, plus instrument, electrical, quality or others the change touches
  3. Phase 3

    Phase 3: Hazard Review & Risk Assessment

    6 tasks

    Match the method to the size and hazard of the change. Look beyond the item being changed: effects can appear in parts of the plant far from it.

    • Choose the hazard review method — a checklist review by an authorised person for a minor, well-understood change, or a what-if, HAZOP or other structured study for a complex one, chosen by a competent person
    • Hold the hazard review — with people who know the process and the method, working through deviations in flow, pressure, temperature, level, composition and procedure, with each cause, consequence and safeguard recorded
    • Check for fire, explosion and loss of containment — hazards the change creates or makes worse, including effects on plant remote from the change, such as shared relief, drains, flare, vent or utility systems
    • Review past incidents and earlier studies for this equipment — incidents, near misses, earlier hazard studies and audit findings on the item being changed, and whether their actions still hold
    • Record the impact on safety and health — on employees, contractors, neighbours and the environment, with the controls that keep the risk acceptable
    • Record the recommendations from the review — each recommendation with an owner and a due date; open recommendations add a task to resolve them before start-up
  4. Phase 4

    Phase 4: Impact on Records, Systems & People

    6 tasks

    Check every record, system and group of people the change touches before it is authorised, so nothing is found for the first time at start-up.

    • Check the impact on process safety information — chemical hazard data, process chemistry, maximum intended inventory, safe upper and lower limits and the consequences of deviation; a change here adds the update task in Phase 6
    • Check the impact on P&IDs and drawings — piping and instrument diagrams, electrical classification, layouts and line lists, so the drawings match what will be built
    • Check the impact on relief, vent and safety systems — relief system design and its design basis, ventilation, interlocks, alarms, trips and detection, including systems shared with other units
    • Check the impact on operating and maintenance procedures — start-up, normal, temporary and emergency operation, emergency and normal shutdown, and the maintenance, inspection and testing routines for the changed equipment
    • Check who must be informed and trained — operators, maintenance staff and contractors’ employees whose tasks the change affects, and what each group needs to know before start-up
    • Check the impact on emergency arrangements and safe work practices — the emergency plan, fire protection, permits to work, isolation and lockout procedures and any other site rules the change touches
  5. Phase 5

    Phase 5: Authorisation to Implement

    4 tasks

    The change is authorised by the people your procedure names before any work starts. On a UK COMAH site the notification and safety report task appears here, because both come before the modification is made.

    • Confirm every reviewer has signed off — each discipline named in Phase 2 has reviewed the change, the hazard review and the impact checks, with their comments resolved
    • UK: check whether COMAH needs a notification or a safety report review — tell the competent authority in advance of a modification that could have significant consequences for major accident hazards; an upper tier establishment also reviews its safety report and sends the revised parts before the modification is made
    • Authorise the change — the authoriser approves, approves with conditions or rejects the change after the technical review, and the conditions are written down
    • Plan the implementation work — work orders, permits to work, isolations, materials checked against the specification, contractors and the order of work
  6. Phase 6

    Phase 6: Implement & Update Records

    7 tasks

    Do the work under your permit-to-work and lockout procedures. The process safety information, procedures and training are brought up to date before start-up, not after.

    • Carry out the change as authorised — built, installed or changed as designed, under the site’s permit-to-work and lockout procedures; any departure from the authorised design goes back through review
    • Inspect and test the change — inspected, tested and proved to meet the design intent, such as pressure tests, instrument loop checks and interlock and alarm tests
    • Update the process safety information — the chemical, technology and equipment information the change affects, including P&IDs, the relief design basis and safety systems
    • Update the operating and maintenance procedures — every procedure the change affects, amended only by authorised people, with any temporary operating instructions controlled the same way
    • Update drawings, registers and maintenance plans — P&IDs marked up as built, equipment and instrument registers, inspection and test plans, and spare parts
    • Resolve every hazard review recommendation — each one implemented, or a documented decision on why not, before start-up
    • Inform and train affected employees and contractors — operators, maintenance staff and contractors’ employees whose tasks change, informed and trained before start-up, with a record of how their understanding was checked
  7. Phase 7

    Phase 7: Pre-Startup Safety Review & Start-Up

    6 tasks

    The pre-startup safety review confirms the plant and the people are ready before hazardous chemicals are introduced. Nothing after the start-up authorisation can be completed until the authoriser records a decision.

    • Walk down the change against the design — construction and equipment in accordance with the design specification, with temporary materials, blanks and scaffolding removed
    • Confirm procedures are in place and adequate — safety, operating, maintenance and emergency procedures updated, issued and available where the work is done
    • Confirm the hazard review actions are closed — the hazard review done, its recommendations resolved, and the MOC steps before start-up complete
    • Confirm training is complete — every employee involved in operating the process trained, and contractors’ employees informed, before start-up
    • Authorise start-up — the authoriser reviews the pre-startup safety review and authorises the introduction of hazardous chemicals or the return to service
    • Start up and monitor the change — start up under the updated procedures, watch the operating limits closely and record any problems found
  8. Phase 8

    Phase 8: Temporary Changes & Close-Out

    5 tasks

    A temporary change is tracked to its expiry so it never becomes permanent by default. The MOC closes only when the final records are issued and every action is complete.

    • Track the temporary change to its expiry — the expiry date watched, and any extension taken through a new review rather than left to run
    • Restore the original design or make the change permanent — equipment and procedures returned to their original or designed condition at the expiry date, or the change taken through a new MOC as a permanent change
    • Issue the final drawings and procedures — marked-up drawings, procedures and process safety information made permanent and filed where operators and future hazard review teams can find them
    • Review the change after a period of operation — check it works as intended, no new hazards have appeared and operators are using the updated procedures
    • Close out the MOC — every task complete or marked not applicable with a reason, every action closed and the record filed

What OSHA PSM and COMAH Say About Managing Change

The US writes the steps of management of change into the PSM standard. In Great Britain, COMAH requires a management of change procedure and says when the competent authority must be told, and HSE’s technical guidance describes good practice. Use the table to check your own procedure; it is not legal advice.

Topic US: OSHA 29 CFR 1910.119 Great Britain: COMAH 2015 and HSE guidance
Who it applies toA process with a listed highly hazardous chemical at or above its Appendix A threshold quantity, or 10,000 lb or more of a Category 1 flammable gas or a flammable liquid with a flashpoint below 100 °F, with exceptions. Not retail facilities, oil or gas well drilling or servicing, or normally unoccupied remote facilities ((a))Lower tier and upper tier establishments, where a dangerous substance is present at or above the quantities in Schedule 1 (regulations 2 and 3)
What must be managedChanges to process chemicals, technology, equipment and procedures, and changes to facilities that affect a covered process, under written procedures ((l)(1))The safety management system must address the management of change: procedures for planning modifications to, or the design of, new installations, processes or storage facilities (Schedule 2, paragraph 2(d)). HSE’s guidance: all modifications, whether to procedures, plant and equipment, people or substances, under formal management procedures
Replacement in kindA replacement which satisfies the design specification ((b)); outside the MOC procedures ((l)(1))Not defined in the Regulations; set the rule in your own procedure
Before the changeThe technical basis, the impact on safety and health, modifications to operating procedures, the necessary time period and the authorisation requirements ((l)(2))HSE’s guidance: no modification without a traceable safety, engineering and technical review of process conditions, operating and engineering methods, safety, environmental conditions and hardware and design, then a risk assessment that includes fire, explosion and loss of containment
Hazard review methodNot set for changes. The non-mandatory Appendix C suggests a checklist reviewed by an authorised person for a minor, well-understood change, and a hazard evaluation with operations, maintenance and safety approvals for a complex oneHSE’s guidance: written procedures decide what level of HAZOP, if any, applies, based on the degree of hazard, the extent of the change, the worst case accident and previous HAZOPs
AuthorisationAuthorisation requirements addressed before the change ((l)(2)(v))HSE’s guidance: formally authorised, after technical investigation, by competent personnel of senior status
PeopleEmployees operating the process, and maintenance and contract employees whose tasks are affected, informed of and trained in the change before start-up ((l)(3))The safety management system identifies training needs and provides the training (Schedule 2, paragraph 2(a)(ii)). HSE’s organisational change guidance: training and supervision for people in new or changed roles
RecordsProcess safety information and operating procedures updated when the change affects them ((l)(4), (l)(5))HSE’s guidance: accurate recording and monitoring of changes to plant and process, and only authorised personnel amend operating procedures or issue temporary operating instructions
Before start-upA pre-startup safety review for a modified facility when the change needs a change in the process safety information, before highly hazardous chemicals are introduced ((i))HSE’s guidance: a pre-commissioning check, including statutory requirements, is a HAZOP study stage for plant modifications too; modifications are proved to have achieved the design intent
Temporary changesNot in the standard’s text. Appendix C: subject to MOC, with a time limit set and monitored, and a return to the original or designed condition at the endHSE’s guidance: only authorised personnel issue temporary operating instructions during a change
Telling the regulatorNo notification to OSHA in paragraph (l)Notify the competent authority in advance of any modification that could have significant consequences for major accident hazards (regulation 6(6)(c)). Upper tier: review the safety report before such a modification and send the revised parts in advance (regulation 10(2)(d) and (5))

Organisational change. HSE says changes such as reduced staffing, outsourcing, merged departments or new roles are usually not analysed and controlled as thoroughly as plant or process changes. Plan them in the same systematic way, and assess both the end state and the transition. OSHA’s list in paragraph (l)(1) does not name organisational changes.

Inventory and tier. A modification that changes the inventory of dangerous substances can move a COMAH establishment into a different tier, and the major accident prevention policy must be reviewed after a significant change in the processes that could have significant consequences (regulation 7(6)).

Why Run Management of Change in CheckFlow?

1

No start-up before the review is signed

The change owner, MOC coordinator, authoriser and operations lead are chosen on the first task, and each step is assigned to the person who owns it. The start-up authorisation is assigned to the authoriser alone, and nothing after that approval step can be completed until a decision is recorded.

2

Only the steps this change needs

A replacement in kind adds one task to record it and close the request, with the remaining tasks marked not applicable. A temporary change adds an expiry date and the tasks that track it, open recommendations add a task to resolve them, and a UK answer adds the COMAH task. Rules show and hide each one from the answers given.

3

Every open change on one screen

Due dates count back from the planned start-up date, and overdue alerts go to the task’s assignees. The Reports Grid lists every change in progress and the task each one has reached, with the hazard review, drawings, test records and training record on the tasks that produced them.

CheckFlow does not run hazard studies or size relief valves. That stays with your engineers, your hazard review team and your design codes. It makes sure every change is reviewed, authorised, recorded and closed in order, by the right people, with the evidence attached. CheckFlow’s manufacturing checklist software shows how the same approach runs other plant routines.

Install the change under the Permit to Work Checklist and the Lockout/Tagout (LOTO) Procedure Checklist. A change to what the plant makes goes through the Manufacturing Change Order Process Checklist, and a change to IT systems through the IT Change Management Process Checklist. For a structured failure analysis use the FMEA Checklist, and for the hazards of a single job the Job Hazard Analysis (JHA) Checklist.

AI generator

Didn’t find what you need? Describe it.

Describe the process in a sentence and the AI checklist generator drafts the phases and tasks for you.

Frequently Asked Questions

What is management of change (MOC)?

A written procedure for reviewing and authorising a change to a process that handles hazardous materials before it is made. In the US, OSHA’s Process Safety Management standard, 29 CFR 1910.119(l), requires one for changes to process chemicals, technology, equipment and procedures, and changes to facilities that affect a covered process, other than replacements in kind. In Great Britain, COMAH 2015 requires a major hazard site’s safety management system to address the management of change. A typical MOC records the technical basis, reviews the hazards, updates the records and trains the people affected before start-up.

What is a replacement in kind?

OSHA defines it as a replacement which satisfies the design specification, and replacements in kind are outside the management of change procedures in 1910.119(l). A part that meets the same specification as the one it replaces is a replacement in kind; a different material of construction, size, rating or chemical is a change. OSHA’s non-mandatory Appendix C lists changes in materials of construction, equipment specifications, alarms and interlocks and computer program revisions among the equipment changes MOC covers. When in doubt, treat it as a change.

What must be addressed before a change under OSHA PSM?

Paragraph (l)(2) lists five considerations: the technical basis for the change, its impact on safety and health, modifications to operating procedures, the necessary time period for the change, and the authorisation requirements. Paragraph (l)(3) requires employees operating the process, and maintenance and contract employees whose tasks are affected, to be informed of and trained in the change before start-up. Paragraphs (l)(4) and (l)(5) require the process safety information and the operating procedures to be updated when the change affects them.

When is a pre-startup safety review required?

Under 1910.119(i), for new facilities, and for modified facilities when the modification is significant enough to require a change in the process safety information. Before highly hazardous chemicals are introduced, the review confirms that construction and equipment match the design specifications, that safety, operating, maintenance and emergency procedures are in place and adequate, that the modified facility meets the management of change requirements, and that training of each employee involved in operating the process is complete. This checklist runs the review before every start-up after a change.

Does COMAH require management of change?

Yes. Schedule 2 of the COMAH Regulations 2015 says the safety management system must address the management of change: procedures for planning modifications to, or the design of, new installations, processes or storage facilities. The operator must notify the competent authority in advance of any modification that could have significant consequences for major accident hazards, and an upper tier establishment must review its safety report before such a modification and send the revised parts in advance. HSE’s technical guidance on plant modification describes good practice for the review.

How should temporary changes be managed?

As changes, with an end date. OSHA’s non-mandatory Appendix C to 1910.119 says temporary changes are subject to management of change, that a time limit should be set and monitored because uncontrolled temporary changes may tend to become permanent, and that equipment and procedures should go back to their original or designed condition at the end. This checklist records the expiry date, reviews the change two weeks before it, and restores the design or takes the change through a new MOC as a permanent one.

Do organisational changes need management of change?

HSE’s guidance says they should be planned in a thorough, systematic way, similar to plant changes. It notes that reduced staffing, outsourcing, merged departments and new roles are usually not analysed as thoroughly as plant or process changes, and recommends assessing both the end state and the transition, consulting staff and contractors, transferring key tasks and training people in new roles. OSHA’s list in 1910.119(l)(1) does not name organisational changes. Tick Organisation, staffing or roles on the first task to add the transition assessment.

Is CheckFlow free for this template?

14-day free trial, no card required. The Business plan is $10 per user per month after the trial. Full details at checkflow.io/pricing.

Review Every Change Before It Starts Up

Free trial — no credit card required.

14-day free trial, no credit cardFull refund in your first 30 daysUS hosting, EU on request
