Change Management Checklist Software
Most outages trace back to a process that wasn’t followed. Run every change from a checklist.
Uptime Institute’s 2022 outage analysis found that 85% of outages caused by human error stem from staff failing to follow procedures, or from flaws in the procedures themselves. A missed rollback plan, a change applied without CAB approval, a post-implementation review that never happened. The change was known. The process just wasn’t followed.
CheckFlow gives every IT change a structured, pre-built checklist: RFC documentation before it starts, risk assessment and rollback plan required before approval, step-by-step implementation checklist during execution, and a mandatory post-implementation review when it’s done. Every step timestamped, every approver named, every change documented, for SOX audit trails, ISO 27001 Annex A controls, and DORA requirements.
14-day free trialNo credit cardUnlimited free guests

Last updated
Change management checklist software runs every IT change through the same steps. In CheckFlow each change type (standard, normal, emergency) is a template: RFC, risk assessment and rollback plan first, a CAB or approver sign-off that halts implementation until it is given, a sequenced implementation with go/no-go points, then a post-implementation review. Every step is recorded with who did it and when, for SOX, ISO 27001 and DORA.
Sound Familiar?
Most change-related outages don’t happen because the engineer didn’t know how to make the change. They happen because one step was skipped, one assumption wasn’t verified, one approval was bypassed “just this once.” The rollback plan wasn’t written down. The testing environment wasn’t equivalent to production. The post-implementation review got skipped because the change “went fine.” The record says it was approved. It doesn’t say when, or by whom. These aren’t competence failures. They’re process failures, and they’re preventable.
No rollback plan at 2am
The change started at midnight. An hour in, something isn’t right. The engineer starts improvising a rollback. The plan existed in someone’s head, or didn’t exist at all. Requiring a documented rollback plan before a change is approved, not during the incident, is one of the single highest-value steps in any change management process.
CAB approval bypassed “just this once”
The change looked low-risk. The CAB wasn’t meeting until next week. The business needed it done today. So it happened without approval. The change went fine, this time. The problem is that “it looks low-risk” is exactly what engineers say about the changes that cause outages. Enforcement requires a system, not trust.
Post-implementation reviews don’t happen
The change went live. It worked. The ticket was closed. Nobody reviewed whether the documentation needed updating, whether monitoring was correct, whether the CMDB reflected the new state. Six months later the same change is applied in a different context and fails, because the lessons from the first time were never captured.
Different engineers follow different procedures
Senior engineers do thorough pre-implementation reviews. Junior engineers follow whatever they saw someone else do. Emergency changes skip all documentation. The process exists in a wiki page nobody reads. Consistent execution requires a checklist that runs for every change, regardless of who’s doing it.
Half the organisation isn’t ready for the organisational change
The system goes live on Monday. Half the managers weren’t briefed. Training wasn’t confirmed completed before go-live. Adoption support wasn’t in place. The technology worked. The change management failed. Sustainable adoption requires the same structured process discipline on the people side as on the technical side.
No audit trail for SOX, ISO 27001, or DORA
SOX auditors test change management as an IT general control over financial systems, and expect approval evidence for every change in the audit period. ISO 27001 Annex A 8.32 requires changes to be subject to change management procedures, with records to show it. DORA requires evidence of change risk assessment and approval for ICT systems. “We have a change management process” isn’t evidence. Timestamped, named records are.
How CheckFlow Works for Change Management

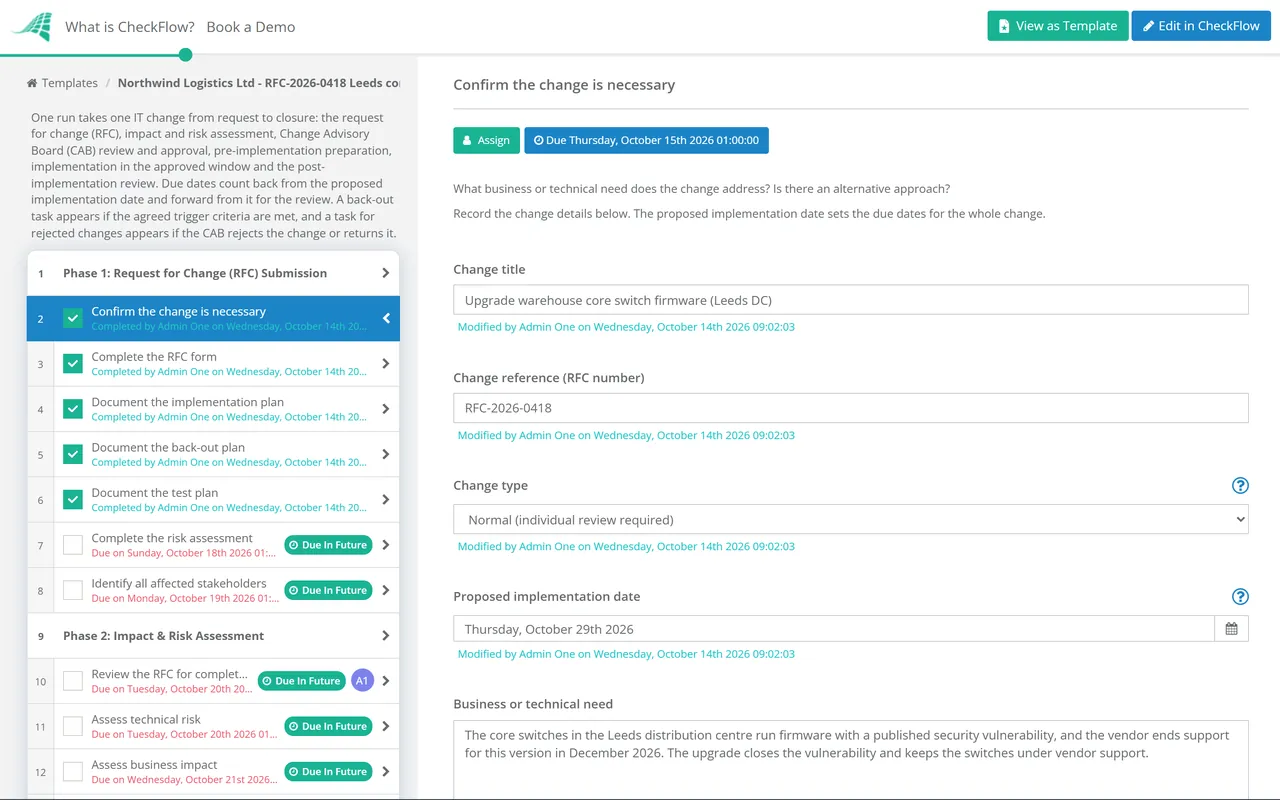

One checklist per change type. Pre-implementation, implementation, and post-implementation, all documented automatically.
Build your change management checklist template
Define the steps for each change type: standard, major, emergency. Pre-implementation: RFC documentation, risk assessment, rollback plan, CAB review, notifications. Implementation: step-by-step execution with go/no-go checkpoints. Post-implementation: service verification, incident monitoring, CMDB update, PIR. Build once; run for every change.
Run the checklist for each change
When a change is proposed, start the checklist. Halt tasks make sure each pre-implementation step is completed before implementation can begin, including the rollback plan and approvals. During implementation, the engineer works through the sequenced steps. Every completed step is timestamped. Custom notifications escalate a step that runs overdue. The change proceeds by procedure, not by memory.
Get the audit trail and the PIR automatically
When the change is complete, the record is already there: who proposed it, who approved it, when each step was completed, and the post-implementation review. SOX, ISO 27001, and DORA audit evidence is generated as a natural output of running the process correctly. No retrospective documentation. No scrambling before the audit.
Built for IT Change Management That Needs to Be Auditable
CheckFlow isn’t an ITSM platform. It doesn’t replace ServiceNow or Jira Service Management. It’s the structured checklist execution layer for teams that need disciplined, documented change management without the complexity and cost of enterprise ITSM. Build your change checklists in CheckFlow, run them alongside your existing incident and ticketing tools, and keep a timestamped record for every change that touches your infrastructure.
Before the change
Pre-implementation change checklist
Before any change touches production: RFC documented (change description, scope, affected systems, business justification), risk assessment completed (probability, impact, blast radius), rollback plan written and reviewed, implementation steps documented in full, CAB or approver sign-off obtained, change window confirmed with operations, pre-implementation checks completed. Every step required. Every step timestamped.
- The approval step can be completed only by its assignees, with a required Approved / Not approved answer
- A halt keeps implementation locked until approval is given
Evidence
Audit trail for SOX, ISO 27001, and DORA
Every change run in CheckFlow produces a timestamped record: who proposed the change, who approved it, when each implementation step was completed, and the post-implementation review outcome. SOX auditors expect approval evidence for every change to financial systems in the audit period. ISO 27001 Annex A 8.32 requires change management procedures and records. DORA requires evidence of ICT change risk assessment and approval. CheckFlow generates this evidence as the natural output of following the process.
- Print any change record, or save it as a PDF
- Export the Reports Grid to CSV, Excel or PDF
Step-by-step implementation checklist
The implementation checklist is the engineer’s guide during the change window: each step in sequence, communication checkpoints built in, go/no-go decision points before proceeding, rollback trigger condition defined. Engineers don’t work from memory: they work through the checklist. Steps are completed in order. Deviations are documented in real time, not reconstructed afterward.
Learn morePost-implementation review (PIR)
The PIR doesn’t get skipped because CheckFlow requires it as the final step: service verification completed, monitoring confirmed normal, CMDB updated to reflect the change, any incidents or anomalies during the window documented, lessons learned captured, record archived. Every change has an end state, not just a start state. The PIR is the documentation your SOX auditor, your ISO 27001 auditor, and your DORA supervisor will ask for.
Learn moreEmergency change procedure
Emergencies require faster execution, but faster doesn’t mean undocumented. CheckFlow’s emergency change checklist captures the minimal but essential steps: the problem justifying emergency action, verbal approval obtained from the CAB chair or on-call manager, the change made, the service confirmed restored, and a retrospective review scheduled within 24 hours. Faster than the standard process, still documented, still auditable.
Learn moreOrganisational change readiness checklist
For software deployments, process changes, and business transformation programmes: stakeholder mapping completed, executive sponsor confirmed, manager briefing delivered, training completed for all affected staff, helpdesk briefed and ready, go-live readiness confirmed by each team lead, post-go-live hypercare schedule in place, 30-day adoption check scheduled. The technical change is only half the work. The people side needs the same structured discipline.
Learn more
Ready-to-Use IT Change Templates
Don’t start from a blank page. Pick a proven IT change management template, customise it to your environment, change types, and approval process, and run it for your next change in minutes. Each one is fully editable in the CheckFlow template designer.

IT Change Management Process Checklist

IT Incident Management Process Checklist

Disaster Recovery Audit Checklist

Problem Management Checklist

Incident Postmortem Template: Blameless Post-Incident Review

Server Decommissioning Checklist

New Software Implementation Checklist

Operating System Upgrade Rollout Checklist

Patch Management Checklist

Network Upgrade & Cutover Checklist

DNS Change & Domain Renewal Checklist

Production Deployment & Rollback Checklist
Replacing a finance system? The ERP & accounting software implementation checklist runs the data migration, the go/no-go and the first close as one controlled change.
Moving workloads, networks or code? The cloud migration, network upgrade and cutover and production deployment and rollback checklists put a go/no-go approval and a time-boxed rollback in front of every cutover.
Moving a single database? The database migration checklist adds a timed rehearsal, row-count and checksum validation and a rollback trigger to the same change.
What Your Change Management Checklists Should Cover
The four phases of a complete IT change management process, and the steps that get skipped when speed beats process.
01Pre-Implementation
- RFC (Request for Change) documented: change description, scope, affected systems and services, business justification, proposed change window
- Risk assessment completed: probability of failure, impact if it fails, blast radius, dependency map
- Rollback plan written and reviewed: specific steps to undo the change, rollback trigger conditions defined, rollback time estimated
- Implementation steps documented: step-by-step, in sequence, with expected outcomes at each step
- Testing completed: change tested in non-production environment equivalent to production
- CAB review completed (for major and significant standard changes): change presented, questions addressed, approval obtained
- Stakeholder notifications sent: operations team, helpdesk, business stakeholders affected by any service window
- Pre-implementation checks completed: backups verified current, monitoring baselines captured, on-call resource confirmed available during change window
02Implementation
- Change window start confirmed and logged
- Pre-implementation checklist confirmed complete before first implementation step begins
- Step 1 of implementation plan executed: outcome confirmed before proceeding to Step 2
- Each step executed in sequence: deviations from plan documented in real time if they occur
- Go/no-go checkpoint reached: continue if service health checks pass; initiate rollback if trigger condition is met
- Rollback executed if triggered: documented in real time, rollback completion confirmed
- Change window end logged
- Immediate post-change health check: critical services confirmed operational, no alerts firing
- Stakeholders notified of completion or rollback outcome
03Post-Implementation
- 1-hour service health verification: all affected services confirmed stable
- 24-hour monitoring review: no anomalous incidents or alerts in the period following the change
- CMDB (Configuration Management Database) updated to reflect the new state
- Documentation updated: runbooks, architecture diagrams, operational procedures updated if changed
- Any incidents or anomalies during or after the change window documented and linked to the change record
- Post-Implementation Review (PIR) completed: what worked, what didn’t, what to do differently next time
- Lessons learned captured and shared with the team
- Change record archived with all steps completed and all attachments filed
- SOX, ISO 27001, or DORA audit trail confirmed complete and stored
04Org Change
- Stakeholder analysis completed: roles affected, resistance anticipated, champions identified
- Executive sponsor confirmed and briefed: business case understood, communication plan approved
- Manager briefing completed: all people managers briefed before their teams are informed
- Training completed for all affected staff: completion tracked per person before go-live gate
- Helpdesk briefed and equipped: scripts updated, FAQ prepared, escalation path defined
- Go-live readiness confirmed: each team lead signs off that their team is ready
- Day-one hypercare in place: support resource available, escalation path shortened, check-in calls scheduled
- 30-day adoption check: usage metrics reviewed, adoption barriers identified, additional support deployed if needed
CheckFlow’s free change management templates cover IT pre-implementation, implementation, post-implementation, and organisational change, ready to run for your next deployment in minutes.
