A lock on the main disconnect does not stop a hydraulic ram still under pressure. Lockout works only when every energy source is isolated, released and proved dead.
This free lockout/tagout checklist takes one machine or job through its energy control procedure in the order set by OSHA’s hazardous energy standard, 29 CFR 1910.147: prepare and notify, shut down, isolate, lock and tag, release stored energy, verify, work, then release and restore. Group lockouts, contractors and the annual periodic inspection appear only when the job needs them. It is written for maintenance technicians, supervisors and EHS leads in US and UK plants.
Under 1910.147(c)(1), an energy control programme has three parts: written procedures, training and periodic inspections. Paragraph (c)(4)(ii) says each procedure must state its intended use, the steps for shutting down, isolating and securing the equipment, the steps for placing, removing and transferring locks and tags, and how to test that the controls work. This checklist applies that procedure on the day and records that it was followed.
The standard sorts people into three groups, each trained differently under (c)(7)(i). Under (c)(8), only the authorised employees doing the servicing apply locks.
Authorised
Locks out and does the work
Who: the technician or fitter who services the machine and applies their own lock.
Trained in: recognising the energy sources, their type and magnitude, and how to isolate and control them.
Owns: the isolation, the try-out and removing their own lock.
Affected
Runs or works near the machine
Who: the operator, and anyone whose job puts them in the area while servicing happens.
Trained in: the purpose and use of the energy control procedure.
Must be told: before locks go on and after they come off, under (c)(9).
Other employees
Passes through the area
Who: forklift drivers, cleaners and quality staff working nearby.
Trained in: what the procedure is, and that they must never try to restart locked-out equipment.
Sees: locks and tags that name the person who applied them.
The standard covers servicing and maintenance, including clearing jams and cleaning, but not minor tool changes that are routine, repetitive and integral to production and done with other effective protection. It excludes cord-and-plug equipment that is unplugged with the plug under the exclusive control of the person working on it. Exposure to electrical hazards from work on conductors and equipment in electric-utilization installations falls under Subpart S, where 1910.333(b)(2) sets its own lockout and tagging rules. Lockout/tagout is third on OSHA’s preliminary list of most cited standards for fiscal year 2026 (1 October 2025 to 31 August 2026).
What the Lockout/Tagout Checklist Covers
Seven phases follow the application sequence in 1910.147(d), the release steps in (e) and the extra requirements in (f). Group lockout, contractor and periodic inspection tasks appear only when they apply. Work cannot start until the area supervisor approves the verified isolation.
Prepare

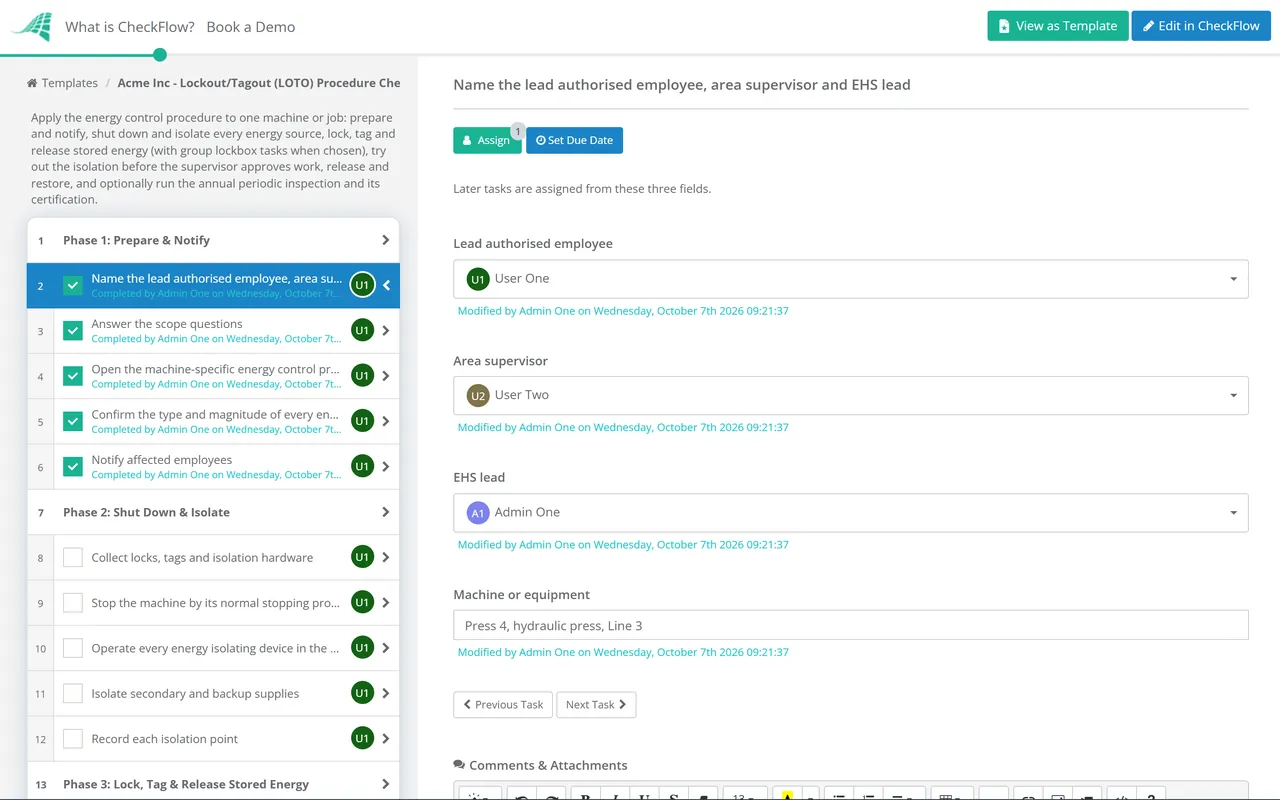

Phase 1: Prepare & Notify
Owned by the lead authorised employee. Scope questions: lockout type (Individual / Group), are outside contractors working on the equipment (Yes/No), is this run also the annual periodic inspection (Yes/No). The contractor task is shown only when contractors is Yes.
Name the lead authorised employee, area supervisor and EHS lead — later tasks are assigned from these three fields
Answer the scope questions — individual or group lockout, contractors on the job, and whether this run is also the annual inspection
Open the machine-specific energy control procedure — the current approved version; escalate if it is missing or does not match the machine
Confirm the type and magnitude of every energy source — electrical, hydraulic, pneumatic, mechanical, thermal, chemical and gravity, before anything is switched off
Exchange lockout procedures with the contractor — each employer tells the other how it locks out, and your own staff follow the contractor’s restrictions
Notify affected employees — what is being locked out, why and for how long, before any control is applied
Isolate
Phase 2: Shut Down & Isolate
Assigned to the lead authorised employee. The isolation table in the last task is what Phase 4 checks against.
Collect locks, tags and isolation hardware — personal locks, tags, hasps, valve covers, plug locks and blocks from the lockout station
Stop the machine by its normal stopping procedure — an orderly shutdown, so the stop itself does not create a new hazard
Operate every energy isolating device in the procedure — breakers, disconnect switches, line valves and blocks; push buttons, selector switches and interlocks are not isolating devices
Isolate secondary and backup supplies — second feeds, air receivers, accumulators and connections from other machines
Record each isolation point — device, location, position and lock number, matched line by line to the written procedure
Lock
Phase 3: Lock, Tag & Release Stored Energy
The last two tasks are shown only when lockout type is Group. The primary authorised employee for a group lockout is the lead authorised employee named in Phase 1.
Lock each isolating device in the safe or off position — personal locks for an individual lockout, group locks for a group lockout; every lock and tag identifies who applied it
Tag any device that cannot take a lock — at the point the lock would go, or as close as safely possible, with an extra measure such as removing a fuse or valve handle
Release or restrain stored energy — bleed hydraulic and air pressure, discharge capacitors, block raised parts, let flywheels stop and hot parts cool
Set continued checks where energy can build up again — for example a capacitor bank or a line that can refill, checked until the work is finished
Put the group lock keys in the lockbox — the primary authorised employee accounts for every key before the box is closed
Each crew member adds a personal lock to the lockbox — on starting work, removed only when they stop; record each name and lock number in the table
Verify
Phase 4: Verify Isolation
The try-out is done by the authorised employee. The start-work approval is assigned from the area supervisor field, and the checklist halts until it is Approved.
Clear everyone from the danger zone — check nobody is exposed before anything is tried
Try to start the machine from its normal controls — press start and jog; nothing should move, sound or light
Test for absence of voltage — a qualified person with a tester proved on a known live source before and after the test
Check pressure gauges and blocked parts — gauges at zero, vents open, raised parts resting on their blocks
Return every control to off or neutral — so nothing starts by surprise when energy is restored
Area supervisor approval to start work — confirms every isolation point in the table is locked, released and proved dead
Work
Phase 5: Do the Work
Assigned to the lead authorised employee. Mark the test-or-position and shift-change tasks not applicable if they do not happen.
Carry out the servicing or maintenance — only the work the isolation covers; re-plan if the scope grows
Follow the test-or-position sequence if the machine must run — clear tools, remove people, remove locks, energise and test, then shut down and lock out again before continuing
Transfer lock protection at a shift change — the oncoming worker applies their lock before the off-going worker removes theirs
Keep the area controlled — barriers and signs stay up until the job is closed
Log any gap in the written procedure — an energy source it missed or a step that did not match the machine, for the procedure owner
Restore
Phase 6: Release & Restore
Assigned to the lead authorised employee. Locks come off only after the machine and the area have been checked.
Remove tools and refit guards — nonessential items cleared, guards and safety devices back on, components operationally intact
Check every person is clear — all employees safely positioned or out of the area, counted against the crew list
Each person removes their own lock — a lock left by someone absent comes off only under your documented removal procedure, after confirming they have left site and trying to reach them
Notify affected employees that locks are off — after removal and before the machine is started
Restart and prove normal operation — run the machine, check guards, interlocks and emergency stops work
Close the job record — lock-off and restore times, the work done and any issues
Inspect
Phase 7: Annual Periodic Inspection
Shown only when “Is this run also the annual periodic inspection?” is Yes. Owned by the periodic inspector named in the first task. The EHS lead approves the certification, and the checklist halts until it is Approved.
Name the periodic inspector — an authorised employee who is not one of the people using this procedure
Observe the procedure being applied — compare each step in Phases 2 to 6 with the written procedure for this machine
Review responsibilities with each authorised employee — and with affected employees too wherever tagout is used
Record and correct deviations or inadequacies — fix the procedure or the practice, and retrain anyone whose knowledge fell short
Complete the inspection certification — the machine, the date, the employees included and the person who did the inspection
EHS lead approval of the certification and corrections — confirms the record is complete and each correction has an owner
Energy Sources, Isolation Points and How to Prove Them Dead
The dangerous source is usually the one nobody listed: the second feed, the accumulator or the part that drops when a cylinder bleeds down. Use the table to check each written procedure names every source. Your procedure decides the actual points and methods.
Energy
Typical isolation point
Stored energy to release
How to verify
Electrical
Lockable disconnect or circuit breaker; plug under the worker’s control
Capacitors, batteries, UPS units and backfeed from other circuits
Try the start controls, then test for absence of voltage with a proved tester
Hydraulic
Pump motor isolator and lockable line valves
Accumulators and trapped pressure in cylinders and hoses
Gauges at zero after bleeding; actuator does not move when the valve is operated
Pneumatic
Lockable dump valve or quarter-turn ball valve on the supply
Air receivers and trapped air in cylinders and lines
Exhaust open and gauges at zero; cylinders do not move
Mechanical
Drive isolation plus blocks or pins on moving parts
Springs under tension, flywheels and parts still coasting
Wait for rundown, check springs are relaxed and parts are blocked
Gravity
Mechanical blocks, safety props or pins
Raised rams, platens, forks and loads
The part is resting on the block, not held by a cylinder or brake
Thermal
Heater and steam supply isolation
Hot surfaces, steam, hot fluids
Measured surface or fluid temperature is safe to touch or open
Chemical and process fluids
Blanks, spades or double block and bleed on the lines
Line contents and pressure behind valves
Drained and vented; bleed point shows no flow
In the UK, regulation 19 of the Provision and Use of Work Equipment Regulations 1998 requires suitable means, where appropriate, to isolate work equipment from all its energy sources, clearly identifiable and readily accessible, and measures so that reconnecting a source puts nobody at risk. The Electricity at Work Regulations 1989 require means of cutting off and isolating the supply (regulation 12) and precautions so that equipment made dead cannot become charged during the work (regulation 13). For process plant, HSE’s HSG253, The safe isolation of plant and equipment, sets baseline standards for isolating lines that carry hazardous substances. Check the current text of each.
Why Run Lockout/Tagout in CheckFlow?
1
Only the steps this job needs
A one-person lockout on a conveyor shows the core sequence. Choose Group and the lockbox tasks appear; add a contractor and the procedure exchange appears. The inspection phase appears once a year, on the run you choose.
2
No work before the try-out is signed
The start-work approval halts the checklist until the area supervisor has checked that every isolation point in the table was locked, released and proved dead.
3
A record of each lockout
The audit trail shows who did each step and when, and photos of locks or gauge readings can be uploaded on the task. A recurring schedule starts each machine’s annual inspection before the twelve months run out.
CheckFlow is not a CMMS or an electronic permit-to-work system, and it does not hold your locks or keys. It runs the human steps around them, so every lockout follows the written procedure in the same order. See how CheckFlow’s manufacturing checklist software handles maintenance routines, quality checks and safety work on the shop floor.
OSHA’s 1910.147(d) sets the order: know the type and magnitude of the energy, shut the machine down, isolate every energy source, apply locks or tags, release or restrain stored energy, and verify isolation before work starts. Release under (e) checks the machine and the area, confirms everyone is clear, has each person remove their own lock and tells affected employees.
How often must energy control procedures be inspected?
+
At least annually, under 1910.147(c)(6). The inspector must be an authorised employee other than the ones using the procedure being inspected, must correct any deviations found, and must review each authorised employee’s responsibilities with them, and affected employees’ too where tagout is used. The employer certifies the inspection, naming the machine, the date, the employees included and the inspector.
When is tagout allowed instead of lockout?
+
When the isolating device cannot take a lock. If it can, 1910.147(c)(2) requires lockout unless the employer can show tagout gives full employee protection, which means attaching the tag where the lock would go and adding measures such as removing a circuit element or a valve handle. Since 2 January 1990, new machines, and machines that are replaced or undergo a major repair, renovation or modification, must have isolating devices designed to accept a lock.
Who can remove another person’s lock?
+
Normally nobody: each device is removed by the employee who applied it. The exception in 1910.147(e)(3) allows removal under the employer’s direction only through a documented procedure, with training, that verifies the person is not at the facility, makes all reasonable efforts to contact them, and ensures they know before they resume work.
Does the UK have a lockout/tagout regulation?
+
Not under that name. PUWER 1998 regulation 19 requires means of isolating work equipment from its energy sources, and regulations 12 and 13 of the Electricity at Work Regulations 1989 cover electrical isolation and work on equipment made dead. They set duties rather than a fixed sequence, so UK procedures often follow much the same steps as the OSHA sequence.
Is CheckFlow free for this template?
+
14-day free trial, no card required. The Business plan is $10 per user per month after the trial. Full details at checkflow.io/pricing.
Prove It Dead Before Anyone Reaches In
Free trial — no credit card required.
Do you like cookies? 🍪 We use cookies to ensure you get the best experience on our website. Learn more
