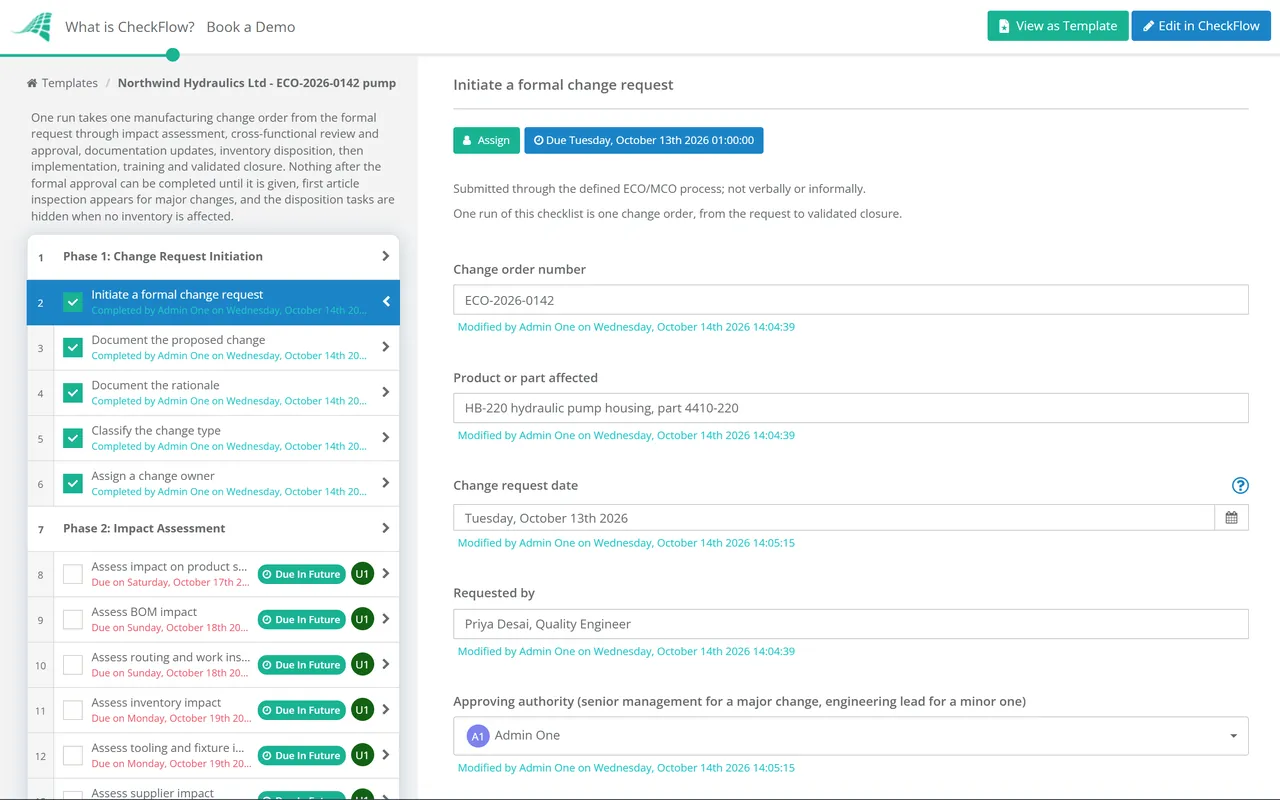

Manufacturing Change Order Process Checklist Template
The product change that skips the formal change order ends up in one of three places: a quality escape, an inventory write-off, or a regulatory non-conformance. A structured change order process prevents all three.
Every manufacturing environment faces constant pressure to change things — a supplier substitutes a component, an engineer improves a design, a customer requests a specification update, or a regulatory requirement mandates a process modification. When those changes are managed through a structured change order process, their impact on quality, cost, delivery, and compliance is assessed before implementation, the relevant stakeholders review and approve, documentation is updated, existing inventory is dispositioned, and the change is validated before full production resumes. When they are not — when an engineer modifies a production process informally, or when a supplier delivers a substitute component that was verbally approved — the consequences appear downstream: a quality escape that reaches the customer, an inventory write-off when existing stock becomes non-conforming, or a regulatory finding when the record does not match what was made. Engineering change orders have been estimated to represent 70–80% of total manufacturing cost — because manufacturing costs are primarily driven by process decisions made during the product lifecycle that are documented and controlled through the ECO process. This free checklist gives manufacturing engineers, quality managers, and operations teams a structured framework for the full manufacturing change order lifecycle.
Major, Minor, and Emergency Changes — How the Change Type Determines the Process
Major Change
Major Change
Definition: A change with significant impact on product function, safety, reliability, or regulatory compliance; changes to critical design parameters; changes requiring customer notification or regulatory submission.
Examples: Material substitution for a structural component, manufacturing process change that affects a critical characteristic, specification change requiring design validation.
Process: Full impact assessment, cross-functional review, senior approval, design validation or testing, regulatory notification where required.
Minor Change
Minor Change
Definition: A change with limited impact — within approved tolerances or parameters; cosmetic changes; administrative corrections to documentation.
Examples: Updated supplier details on a drawing, minor tolerance adjustment within an already-validated range, typo correction in a work instruction.
Process: Simplified review, engineering approval, documentation update — no testing or regulatory notification required.
Emergency Change
Emergency Change
Definition: An urgent change required immediately to address a safety issue, critical quality failure, or regulatory mandate — where implementing through the normal process timeline is not acceptable.
Examples: Safety-related design defect in production units, critical supplier quality escape requiring immediate containment, urgent regulatory recall or remediation action.
Process: Expedited approval from senior management, immediate implementation, full retrospective documentation completed within a defined timeframe. The emergency process is not a bypass — documentation still required, completed after rather than before.
The Manufacturing Change Order Process Checklist
Six phases covering the full change order lifecycle — from formal change request initiation through impact assessment, cross-functional review, documentation updates, inventory disposition, and validated closure.
Phase 1
Change Request Initiation
Every change begins with a formal change request — not a verbal instruction, an email, or a redlined drawing. The change request documents what is being changed, why, and who is requesting it. This is the starting point for all downstream impact assessment.
Initiate a formal change request — submitted through the defined ECO/MCO process; not verbally or informally
Document the proposed change — precise description of what is being changed (part number, drawing number, process step, document reference); current state vs proposed state
Document the rationale — why is this change needed? Cost reduction, quality improvement, regulatory requirement, customer request, supplier change, safety issue?
Classify the change type — major, minor, or emergency; determines the review level required
Assign a change owner — the person responsible for driving the change through the process from initiation to validated closure
Phase 2
Impact Assessment
The impact assessment is where most change failures are prevented. A change that looks simple at the design level may have complex cascading effects on manufacturing processes, material inventory, supplier qualification, and regulatory status.
Assess impact on product specifications and drawings — which drawings, specifications, or standards documents must be updated?
Assess BOM impact — does the change add, remove, or substitute any BOM items? New part numbers required?
Assess routing and work instruction impact — do production routings or work instructions need to be updated?
Assess inventory impact — does the change make existing RM, WIP, or FG inventory non-conforming or obsolete? Disposition plan required
Assess tooling and fixture impact — does the change require new or modified tooling, jigs, or fixtures?
Assess supplier impact — does the change affect any qualified supplier? Does the supplier need to re-qualify?
Assess quality control impact — do inspection criteria, sampling plans, or test methods need to be updated?
Assess regulatory impact — is this product in a regulated sector (medical, food, pharma, aerospace)? Does the change require regulatory notification, submission, or pre-approval?
Estimate implementation cost — tooling, materials, documentation, testing, inventory disposition; business case confirmed
Phase 3
Cross-Functional Review & Change Approval
Present the change request and impact assessment to the change review board — engineering, quality, production, supply chain, and regulatory (where applicable) represented
Engineering review — technical merit of the proposed change; design intent maintained; no unintended consequences on related design elements
Quality review — quality implications; inspection and test method changes required; qualification or validation testing needed?
Production review — manufacturing feasibility; production capacity impact; tooling lead time; training required?
Supply chain review — supplier implications; lead time impact; inventory disposition plan; new supplier qualification required?
Obtain formal approval — at the authority level appropriate for the change type (major: senior management; minor: engineering lead)
Assign implementation tasks — each action item from the impact assessment assigned to a named owner with a target completion date
Phase 4
Documentation Updates
Update drawings and specifications — all affected documents revised to the new revision level; obsolete revisions controlled (archived, not deleted)
Update the BOM — new components added, obsolete components removed; effective date confirmed
Update production routings and work instructions — all affected process steps updated to reflect the new process
Update quality control plans — inspection criteria, acceptance criteria, and test methods updated as required
Confirm document control compliance — all updates completed through the document control system; correct version accessible on the production floor
Phase 5
Inventory Disposition
Identify all affected inventory — RM, WIP, and FG inventory impacted by the change; confirmed with inventory management
Determine the disposition — use as-is (if allowed under the change), rework to new specification, scrap, or return to supplier
Segregate affected inventory — clearly tagged and separated from conforming stock; do not allow non-conforming inventory to enter production
Execute the disposition — per the approved plan; document quantities and costs
Establish the effective date — the production order date from which the new specification applies; confirmed in the system
Phase 6
Implementation, Training & Validation
Communicate the change to all affected teams — before the effective date; production, quality, receiving, and any other affected function
Train affected operators and technicians — on the new process or specification; training records documented
Implement the change — on the first production run after the effective date; confirmed with the production supervisor
Conduct first article inspection — for major changes; verify the first production run under the new specification meets all requirements before full production continues
Validate the change — confirm the intended outcome (cost reduction, quality improvement, regulatory compliance) has been achieved
Close the change order — with all implementation tasks confirmed complete; validation results documented; all documentation updated
When a Change is Not a Change Order, These Are the Likely Consequences
Quality escape
An undocumented component substitution reaches the customer because the quality plan still specifies the original component — and inspection passed the new one without validating it against the correct criteria. The recall is more expensive than the change order would have been.
Inventory write-off
A process change makes existing WIP and FG inventory non-conforming. Because the change was not formally assessed, no disposition plan existed, and the non-conforming product was shipped before the issue was identified.
Regulatory non-conformance
For regulated products, the device or product history record does not match what was made because the change was not documented. FDA audit, ISO audit, or notified body review produces a major finding.
Repeat problem
Without a formal change record, the change cannot be traced. When the same issue appears six months later, no one knows whether a change was made or what it was. The investigation starts from scratch.
