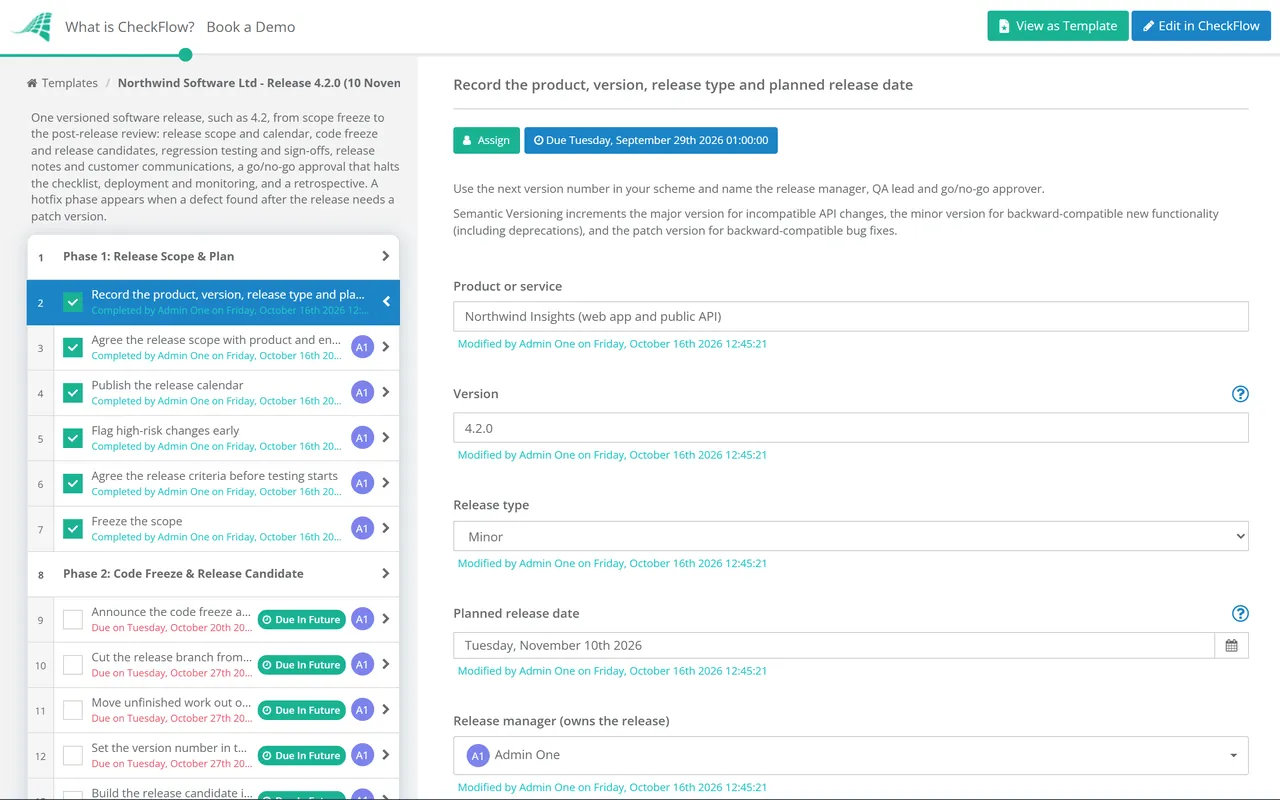

Software Release Management Checklist Template

Releases rarely fail on deploy day. They fail weeks earlier, when scope keeps growing after the freeze, regression runs on a different build from the one that ships, and nobody owns the go/no-go call.

Last reviewed: October 2026

A versioned release bundles weeks of work from several teams into one number, and every change in it has to be frozen, built, tested, described and approved together. This free software release management checklist gives release managers, engineering leads and QA teams one run per version, such as 4.2, from scope freeze to the post-release review. It plans the scope and calendar, freezes the code and cuts a release branch, builds numbered release candidates, runs regression testing and collects sign-offs, and prepares release notes and customer communications. A go/no-go approval halts the checklist until the approver decides. The deploy runs through the Production Deployment & Rollback Checklist, and this one records what happens around it: tagging, publishing, monitoring and triage. A hotfix phase appears only when a defect found after the release needs a patch version, and the run ends with a retrospective and the release metrics. Every due date counts from the planned release date.

A Software Release Is Not One Feature or One Deploy

Release management sits above two smaller jobs. A feature release takes one change from specification to customers. A deployment puts one build into production and decides whether to roll it back. A software release groups many features and fixes into a version that is frozen, tested and approved as one unit, then shipped through a deployment and supported afterwards.

Teams that run all three from one production release checklist either bury the deployer in release notes or lose track of which build was tested. Keep them separate and link them: this checklist owns the version, the Feature Release Process Checklist owns each feature, and the Production Deployment & Rollback Checklist owns deploy day.

Feature release

One feature, spec to customers

Covers: the specification, code review, QA of the feature and its release notes.

Owner: the product manager and the feature team.

Unit: one feature or improvement.

Software release

This checklist: one version

Covers: scope and code freeze, release candidates, regression, sign-offs, release notes, the go/no-go, monitoring and the retrospective.

Owner: the release manager.

Unit: one version, such as 4.2.0, and any hotfix that follows it.

Production deployment

Deploy day and rollback

Covers: the artefact, migrations, deploy strategy, verification and the rollback decision.

Owner: the deployer and the on-call engineer.

Unit: one deploy of one build.

What the Software Release Management Checklist Covers

Eight phases take one version from scope freeze to review. The go/no-go at the end of Phase 5 halts the checklist until the approver decides, Phase 7 appears only when a defect found after the release needs a hotfix, and every due date counts from the planned release date.

  1. Phase 1

    Phase 1: Release Scope & Plan

    6 tasks

    Fill in the first task before anything else. The planned release date sets every due date in the checklist, and the approver named there makes the go/no-go decision.

    • Record the product, version, release type and planned release date — use the next version number in your scheme and name the release manager, QA lead and go/no-go approver
    • Agree the release scope with product and engineering — the tickets, epics and fixes that make up the version, tracked under one fix version in your issue tracker
    • Publish the release calendar — scope freeze, code freeze and branch cut, first release candidate, regression window, go/no-go and release date
    • Flag high-risk changes early — database migrations, API or integration changes, infrastructure changes and anything that cannot be rolled back
    • Agree the release criteria before testing starts — the exit criteria the go/no-go will check, such as no open S1 or S2 defects, regression passed, performance within budget and security scans clear
    • Freeze the scope — from here, new work goes to the next version; a late addition needs the release manager's approval and a reason
  2. Phase 2

    Phase 2: Code Freeze & Release Candidate

    8 tasks

    After the code freeze, the release branch takes only fixes for defects in this release, and every change reaches testing through a new release candidate.

    • Announce the code freeze and its rules — the date, the time zone and what may still merge: fixes for this release's defects, each approved by the release manager
    • Cut the release branch from main — for example release/4.2, and record the commit it was cut from
    • Move unfinished work out of the release or behind a feature flag, off by default — nothing half-built ships switched on
    • Set the version number in the build and start the changelog — release candidates carry a pre-release label, such as 4.2.0-rc.1
    • Build the release candidate in CI from the release branch — the same artefact goes to staging and, if approved, to production; never rebuild it
    • Confirm automated tests, static analysis and dependency scans pass on the candidate — for this build, not an earlier one with the same version number
    • Deploy the candidate to staging and rehearse the migrations — on a production-sized copy of the data, recording how long each migration takes
    • Log every fix and new candidate after the freeze — each fix merged to main as well as the release branch, so the next version does not bring the defect back
  3. Phase 3

    Phase 3: Regression Testing & Sign-Offs

    6 tasks

    Test the numbered candidate you intend to ship. When a fix produces a new candidate, re-run the tests its change could affect.

    • Run the full regression suite against the release candidate — the automated suite plus the manual key user journeys
    • Test upgrades from the previous version — data, settings, API clients and any older app versions customers still use
    • Run performance and load tests against the agreed budget — response times and resource use compared with the last release
    • Triage every defect found in the release — S1 and S2 block the release; lower severities are scheduled and listed as known issues
    • Retest each fix on the new candidate — confirm the fix and check that nothing near it has broken
    • Collect sign-offs from QA, product and security — each recorded with the name, the candidate and the date
  4. Phase 4

    Phase 4: Release Notes & Customer Comms

    6 tasks

    The breaking changes task appears only when the first phase records breaking changes or deprecations.

    • Draft the release notes from the tickets in the release — new features, improvements, fixes, known issues and any action users must take
    • Document breaking changes and deprecations — with migration steps and dates, so customers can prepare before the release
    • Review the notes with product, support and documentation — check every change is described the way a customer will see it
    • Brief support and customer success — what changed, the known issues and answers to likely questions, before customers ask
    • Update help articles, API docs and screenshots — ready to publish when the release goes live
    • Schedule customer communications — release email, in-app message and a status page notice for any maintenance window
  5. Phase 5

    Phase 5: Go/No-Go

    5 tasks

    The approver named on the first task records the decision on the last task. The checklist halts there, and nothing after it can be completed until they decide.

    • Check each release criterion against the evidence — Met or Not met, with a link to the result
    • List the known issues and accepted risks — each with an owner and the version that will fix it
    • Confirm the deployment plan and its rollback plan — run in the Production Deployment & Rollback Checklist, started for this candidate with its own deployer and approver
    • Confirm support and on-call cover for release day and the days after — who answers customers and who can build and ship a fix
    • Record the go/no-go decision — Approved, Approved with conditions or Not approved, with the reason
  6. Phase 6

    Phase 6: Deploy & Monitor

    6 tasks

    Deploy-day steps, the deploy strategy and the rollback decision live in the Production Deployment & Rollback Checklist. This phase records the release around the deploy.

    • Deploy the approved candidate through the deployment checklist — the same artefact that passed regression, in the agreed window
    • Tag the release in source control — for example v4.2.0, on the exact commit the candidate was built from
    • Publish the release notes and changelog — with the version number and the release date
    • Send the customer communications — the release email, in-app message and any status page update you scheduled
    • Monitor errors, performance and support tickets for the agreed period — compared with the baseline before the release
    • Triage defects reported after the release — decide for each whether it needs a hotfix or can wait for the next version
  7. Phase 7 — If Needed

    Phase 7: Hotfix Release

    6 tasks

    Shown only when a defect found after the release needs a hotfix. A hotfix is a patch version, such as 4.2.1, built from the release tag rather than from main.

    • Confirm the defect justifies a release outside the plan — severity, customers affected and whether a feature flag or workaround would contain it
    • Branch the fix from the release tag — so the hotfix contains the fix and nothing else that has merged to main since
    • Test the fix and the areas around it — plus a smoke test of the critical journeys; a shortened run, not none
    • Approve the hotfix — the approver named on the first task records the decision before it is deployed
    • Deploy the hotfix through the deployment checklist — and publish a short note for the patch version
    • Merge the fix back into main and any open release branch — or the next version ships the defect again
  8. Phase 8

    Phase 8: Retrospective & Close

    4 tasks
    • Close the version in your issue tracker — mark it released, close its tickets and move anything unreleased to the next version
    • Hold the release retrospective — what slipped, which defects escaped testing and what to change next time
    • Record the release metrics — planned and actual release dates, scope changes after the freeze, defects found after release and hotfixes needed
    • Turn retrospective actions into tickets with owners — and update this template if a step was missing or in the wrong place

A Release Timeline Counted Back From the Release Date

The checklist’s due dates follow this timeline, counted in calendar days from the planned release date on the first task. Change that date and every milestone moves with it. The offsets suit a release every month or two. For a shorter cycle, close the gaps, but keep regression on a frozen candidate and the go/no-go before the deploy.

Milestone When Owner Done when
Scope agreed and calendar published6 weeks beforeRelease manager and productThe version’s tickets sit under one fix version and every milestone has a date
Scope freeze4 weeks beforeRelease managerNew work goes to the next version unless the release manager approves it
Code freeze and branch cut2 weeks beforeRelease manager and engineeringThe release branch exists and takes only fixes for this release
First release candidate13 days beforeEngineeringA numbered candidate is built once in CI and deployed to staging
Regression and sign-offs11 to 4 days beforeQA leadThe full suite has run on the candidate and QA, product and security have signed off
Release notes and comms ready3 days beforeRelease manager, product and supportNotes reviewed, support briefed and customer messages scheduled
Go/no-go2 days beforeGo/no-go approverApproved, approved with conditions or not approved, with the reason
ReleaseRelease dayDeployer, through the deployment checklistDeployed, tagged, notes published and customers told
Monitoring and triageUp to 3 days afterRelease manager and on-callPost-release defects triaged and any hotfix decided
Retrospective and metrics10 days afterRelease managerActions have owners and the release metrics are recorded

Number the version before you build it. Semantic Versioning 2.0.0 increments the major version for incompatible API changes, the minor version for backward-compatible new functionality (and whenever part of the public API is marked as deprecated), and the patch version for backward-compatible bug fixes. Release candidates take a pre-release label after a hyphen, such as 4.2.0-rc.1, which the specification ranks below 4.2.0.

The specification also says that once a version is released, its contents must not be modified: any change ships as a new version. That is why a defect found after 4.2.0 goes out as 4.2.1 through the hotfix phase, built from the release tag, rather than as a quiet rebuild of 4.2.0.

Why Run Software Releases in CheckFlow?

1

Every date moves with the release date

Each task’s due date counts from the planned release date on the first task. When the release slips a week, change that one date and the freeze, the regression window and the go/no-go move with it. Every release in progress shows on the Reports Grid, and the Tasks Grid lists each person’s release tasks by due date.

2

A go/no-go that stops the release

The approver named on the first task records Approved, Approved with conditions or Not approved, and the checklist halts until they do. Tagging, publishing and customer emails cannot be ticked off before the decision, and the decision records who made it and when.

3

The release record is already there

Scope, candidates, defects, sign-offs and the criteria check are captured in fields and tables inside the tasks, with the date each step was completed and by whom. When a post-incident review asks which build was tested and who approved it, the answer is in one checklist.

A go/no-go is an approval step with a halt. CheckFlow’s approval software shows how approvals, decisions and halts work across a template.

The deploy itself runs through the Production Deployment & Rollback Checklist, and each feature in the version through the Feature Release Process Checklist. Changes reach the release branch through the Code Review Checklist, and defects found in regression are worked through the Bug Tracking & Resolution Checklist.
