Trade Show Checklist Template

The show itself lasts three days. The deadlines that decide what it costs and whether your stand arrives fall months earlier, in a manual nobody on the team has read.

Exhibiting is a project with an outside rulebook: the organiser’s exhibitor manual sets the forms, the service order deadlines, the shipping dates and what you may build. This free trade show checklist is for marketing teams, exhibition managers and founders taking a stand at an industry show. It runs from goals, budget and booking, through the manual’s deadlines, stand graphics, promotion, staffing and lead capture, to build-up, the show days, breakdown and the follow-up that turns badge scans into meetings. Three questions at the start add a custom stand build phase, an international shipping and customs phase and the sponsorship deliverables when your show needs them.

Use This Template Free See Live Example
No Credit Card Required

Last reviewed: October 2026

Exhibiting Is a Different Job From Organising

The Event Planning Checklist is written for the organiser: the team that books the venue, runs registration, builds the programme and hosts everyone. An exhibitor is one of that organiser’s customers. You do not choose the venue, the dates, the floor plan or the official contractors. You buy space, follow the rules in the exhibitor manual, and have a few days to meet as many of the right people as you can.

That changes what goes wrong. Organisers struggle with venues and speakers. Exhibitors miss early-bird service deadlines, ship freight to the wrong address on the wrong date, arrive without the insurance certificate or fire certificates the venue asks for, and come home with a pile of scans nobody follows up. The first decision is the type of stand, because it sets most of the work.

Shell scheme or pop-up

The organiser supplies the walls

  • Walls, name board and often basic lighting come with the space
  • Your work is graphics, furniture, power and any extras you order
  • Graphics must fit the organiser’s panel sizes and fixing rules
  • Lower cost and lead time; the right start for a first show
Space-only custom build

You bring the stand

  • Bare floor; a designer and contractor design, build and dismantle
  • Stand plans go to the organiser for approval against height and safety rules
  • Materials need fire-retardant certification; rigging and labour have their own rules
  • Build-up days, storage and transport are yours to plan

What the Trade Show Checklist Covers

Seven phases run from goals and booking to the debrief after the show. Phase 3 appears only for a space-only custom stand, Phase 4 only when the show is outside your home country, and the sponsorship task in Phase 5 only when you are sponsoring or speaking.

Plan

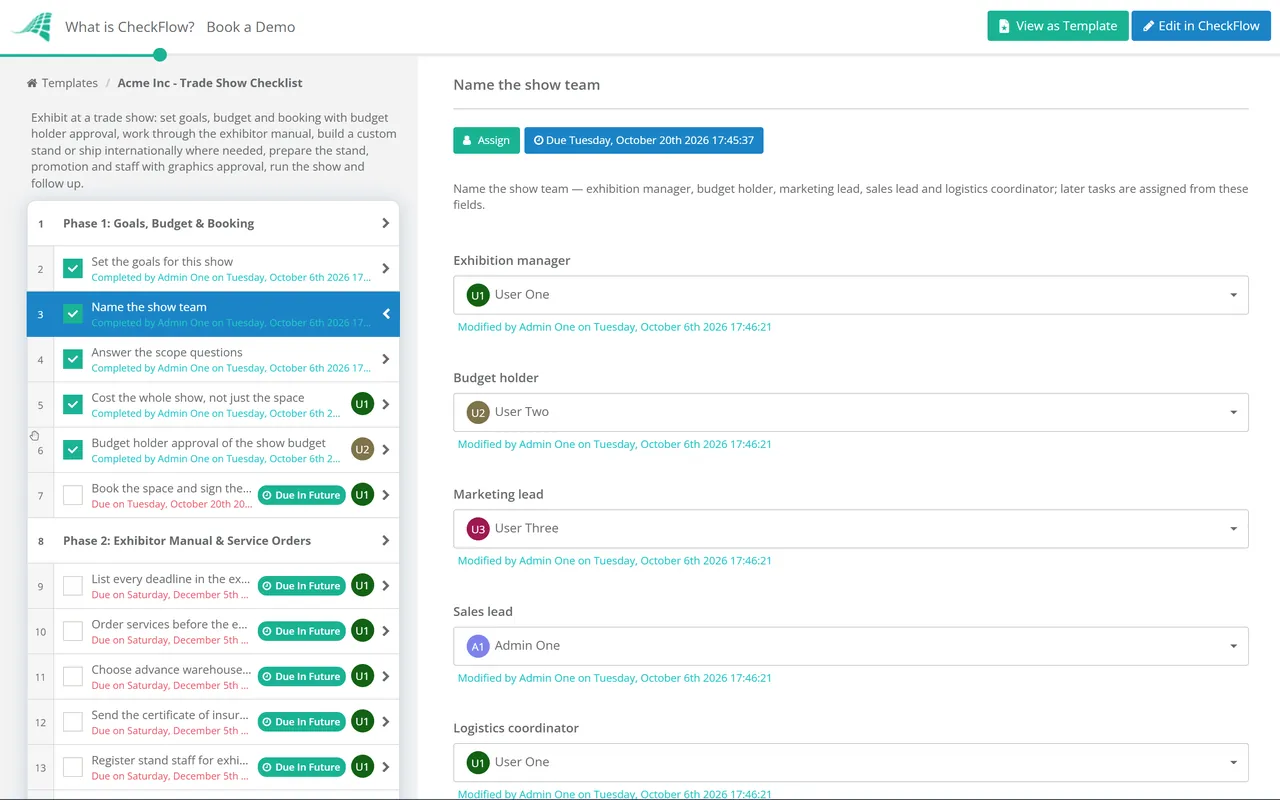

Phase 1: Goals, Budget & Booking

Answer the scope questions first. They decide whether the custom build phase, the international phase and the sponsorship task appear.

  • Set the goals for this show — meetings booked, qualified leads, pipeline or partner conversations, each with a number you will check afterwards
  • Name the show team — exhibition manager, budget holder, marketing lead, sales lead and logistics coordinator; later tasks are assigned from these fields
  • Answer the scope questions — custom build or shell scheme, outside your home country or not, and sponsoring or speaking or not
  • Cost the whole show, not just the space — stand, graphics, shipping, handling, services, travel, hotels, lead scanners and staff time
  • Budget holder approval of the show budget — the checklist stops until the budget holder approves; nothing is booked before then
  • Book the space and sign the exhibitor contract — check the stand position, payment schedule, cancellation terms and what the space includes
Manual

Phase 2: Exhibitor Manual & Service Orders

  • List every deadline in the exhibitor manual — forms, early-bird service rates, shipping dates, badge registration and stand approval
  • Order services before the early-bird deadline — electrics, internet, AV, furniture, cleaning and lead retrieval, at the lower advance rate
  • Choose advance warehouse or direct-to-show shipping — each has its own receiving window and labels; material handling is charged by weight
  • Send the certificate of insurance — with the limits and additional insured names the manual asks for, by its deadline
  • Register stand staff for exhibitor badges — names must match ID, and late changes can cost a fee
  • Order rigging for any hanging sign — only where the manual allows it, with the venue’s approved rigger
Build

Phase 3: Custom Stand Design & Build

Shown only when the scope answer is Space-only custom build.

  • Brief the stand designer and contractor — goals, budget, stand size, open sides, meeting space, storage and reuse at later shows
  • Submit stand plans to the organiser for approval — height limits, open sides, structures and any double-deck or hanging elements, by the manual’s date
  • Collect fire-retardant certificates for materials — fabrics, flooring and timber, kept on the stand in case the fire officer asks
  • Register your contractor and check labour rules — who may build, use tools or unpack crates is set by the venue and, at some US venues, union jurisdiction
  • Agree the build and dismantle schedule — access times, deliveries, power-on time and who signs off the finished stand
Customs

Phase 4: International Shipping & Customs

Shown only when the scope answer to ‘Is the show outside your home country?’ is Yes.

  • Appoint a freight forwarder who knows the venue — and work back from their shipping lead time, not the organiser’s receiving date
  • Decide whether you need an ATA Carnet — for demo equipment and display goods that will come home; apply through your national chamber of commerce
  • Plan duties on what stays behind — brochures, giveaways and anything sold are not covered by a carnet and are imported normally
  • Check plugs, voltage and power orders — and whether demo equipment needs local approval marks or adaptors
  • Check visas and travel rules for each person — business visitor rules differ by country and passport, so check them early
Prepare

Phase 5: Stand, Promotion & Staffing

The sponsorship task is shown only when the scope answer says you are sponsoring or speaking.

  • Produce the stand graphics to the organiser’s specification — panel sizes, bleed, fixing method and file deadlines, with one clear message readable from the aisle
  • Marketing lead approval of stand design and graphics — the checklist stops until the marketing lead approves; nothing goes to print or build before then
  • Book meetings before the show — invite customers, prospects and partners with a time slot, not just a stand number
  • Deliver sponsorship and speaker assets — logos, copy, slides and speaker details by each of the organiser’s deadlines
  • Agree lead qualification questions and consent wording — three or four questions, plus what you tell people about follow-up when you scan their badge
  • Draw up the stand rota and book travel — shifts, breaks, cover for meetings, dress, hotels and arrival times
  • Brief everyone on the stand — goals, messages, demo script, the qualification questions and how to use the scanner
Show

Phase 6: Build-Up, Show Days & Breakdown

  • Check the freight and services on arrival — everything delivered, power and internet live, and missing items reported to the service desk early
  • Test lead capture before doors open — every scanner or app logs in, records the qualification answers and exports
  • Hold a short huddle each morning — meetings booked, yesterday’s leads, what is working and who covers which shift
  • Add notes to each lead the same day — what they need, how hot they are and the agreed next step
  • Pack and label for return shipping — outbound labels and paperwork done before breakdown starts; never leave freight unattended
  • Confirm the stand is cleared and collected — keep the collection receipt and photograph the empty space
Follow-up

Phase 7: After the Show

  • Load the leads into your CRM — within a day or two, with the notes and qualification answers attached
  • Follow up while the show is fresh — personal follow-up for hot leads within days, a relevant message for the rest
  • Reconcile costs against the budget — late invoices, handling charges and anything ordered on site
  • Measure results against the goals — meetings, qualified leads and pipeline, then revisit them again a quarter later
  • Run the debrief and decide on next year — stand position, size, staffing and whether to rebook, with notes for the next checklist

A Typical Exhibitor Countdown

Exhibitor manuals set the real dates, and they differ from show to show, so treat this as the usual shape rather than a rule. Start the checklist when you decide to exhibit, then replace the gaps below with the deadlines in your manual. International shows and custom builds move everything earlier.

6–12 months

Decide, budget and book

Goals set, the budget approved and the space booked. Good stand positions at popular shows are often rebooked by last year’s exhibitors before the show closes.

3–6 months

Design and plan

Stand designed and, for a custom build, plans submitted for approval. Forwarder appointed and carnet applied for if the show is abroad.

6–8 weeks

Orders and promotion

Services ordered before early-bird deadlines, insurance certificate sent, graphics approved and to print, invitations and meeting requests out.

2–4 weeks

Freight, staff and leads

Freight shipped to arrive inside the receiving window, badges registered, rota and travel booked, lead questions agreed.

Show week

Build, exhibit, break down

Deliveries checked, scanners tested, daily huddles held, leads noted the same day, return freight labelled before breakdown.

Week after

Follow up and review

Leads in the CRM and contacted, costs reconciled, results measured against goals and the debrief held while people remember.

Freight is where small mistakes cost most. Material handling is charged by weight, usually per 100 lb with a minimum, and freight that reaches the advance warehouse after its deadline can attract a late surcharge. Label every crate with the show, your company and stand number and the address in the manual, keep the bill of lading, and book the outbound collection before breakdown so nothing is left on the floor when the hall closes.

Scanning a badge is not consent to everything. When a visitor lets you scan their badge you usually become the controller of that data and must tell them how you will use it. Under UK rules, marketing email to a company address does not need prior consent, but you must identify yourself and offer an opt-out, and sole traders and some partnerships are treated as individuals who do. Some EU countries, Germany among them, require consent for business email too. Ask at the scan and record the answer.

Why Run Trade Shows in CheckFlow?

1

Manual deadlines that land on time

Each task carries a due date offset from the day the checklist starts, and every task is assigned from the show team fields. Put the order confirmations, insurance certificate and carnet on their tasks, so the paperwork is in one place on build-up day.

2

Budget and design decided on the record

The show budget and the stand graphics each stop at an approval step until the right person answers, so nothing is booked or printed on a figure or design nobody agreed. The approvals sit in the history with the quotes.

3

Every show in the calendar, the same way

Run one template for every show, with dropdowns adding the custom build, customs and sponsorship work. Recurring schedules start the checklist for annual shows, and reports show which shows have overdue tasks.

The Event Budget Approval Checklist takes a large show budget through a fuller review, and the Post-Event Follow-Up Checklist extends the follow-up phase into content, surveys and ROI. Speaking at the show? The Conference Speaker Coordination Checklist shows what the organiser will ask you for.

A show is a campaign with a stand attached. The Campaign Launch Checklist and our guide to a marketing campaign launch cover the promotion around it, and recurring checklists keep a calendar of shows running to the same standard every year.

Frequently Asked Questions

How far in advance should you plan for a trade show?

+

Start six to twelve months ahead for a major show, and earlier if you want a good stand position or are building a custom stand. The exhibitor manual sets the hard dates: service orders are cheaper before the early-bird deadline, freight has a fixed receiving window, and custom stand plans need organiser approval weeks before build-up. Shows abroad need extra time for a freight forwarder and an ATA Carnet.

What is an exhibitor manual?

+

It is the organiser’s rulebook and order guide for exhibitors. It lists every deadline, the forms to return, the official contractors for freight, electrics, internet and furniture, shipping addresses and receiving dates, build-up and breakdown times, stand height and construction rules, insurance requirements and fire safety rules. Read it as soon as you book and turn every date in it into a task with an owner.

What is the difference between a shell scheme and a space-only stand?

+

A shell scheme comes with walls, a name board and usually basic lighting supplied by the organiser, so you add graphics and furniture. Space-only is bare floor: you design and build the whole stand, submit plans for approval, provide fire certificates and arrange build-up and dismantle. Shell schemes cost less and need less lead time; space-only gives you control over size, layout and brand.

Do I need an ATA Carnet for an overseas trade show?

+

You need one if you want to take display goods or demo equipment into a participating country temporarily without paying import duties and taxes. A carnet covers goods for exhibitions, commercial samples and professional equipment, which must come back out, usually within a year. It does not cover anything sold, given away or consumed. Carnets are issued through national chambers of commerce, with a security deposit or bond.

Can you email leads from a trade show badge scan?

+

Usually, if you told them how you would use their details and you follow the email rules where they are. In the UK, B2B marketing email to a company address does not need prior consent under PECR, but you must identify yourself and offer an opt-out; sole traders need consent. Some EU countries, including Germany, require consent for business email, so record it at the scan.

Is CheckFlow free for this template?

+
