Warehouse Safety Inspection Checklist Template

Most warehouse walk-rounds spot the dented upright and the pallets in the fire exit, then nobody owns the fix. The same bay is still loaded next month, and the exit is blocked again every busy Friday.

Last reviewed: October 2026

Printed from checkflow.io/templates/operations-facilities-management/warehouse-safety-inspection-checklist

This free warehouse safety inspection checklist is for warehouse and site managers, health and safety leads, supervisors and the competent person who walks a distribution centre, store or third-party logistics site each month. One run is one scheduled safety walk of one warehouse, and it is built to run on a monthly recurring schedule. It starts from the records and last month’s open actions, then checks racking and storage, with damage rated green, amber or red; aisles, floors and walkways; loading docks and the separation of vehicles and pedestrians; the system around forklifts and other handling equipment; fire exits; and PPE, first aid, welfare, housekeeping and manual handling. Amber or red racking damage and a blocked exit add tasks to deal with them at once. Every finding gets a risk rating, an owner and a due date, the site manager approves the action plan, and a re-check confirms the fixes worked.

A Warehouse Safety Inspection Is Not a Forklift Check or a Building Survey

HSE and the Warehousing Health and Safety Forum name four priorities for warehouses in HSE’s guidance HSG76: manual handling, slips and trips, vehicles in and around the warehouse, and work at height. Racking, storage and fire exits sit beside them. None of them stays fixed. Racking takes knocks every shift, walkways fill with stock in a busy week, and a new bay changes how lorries and people move. A monthly safety walk is how a site manager sees those changes before someone is hurt.

It is one of three different checks. In the US, 29 CFR 1910.22 requires walking-working surfaces to be inspected regularly and as necessary. In Great Britain, HSG76 asks for racking to be inspected visually every week or at other intervals based on risk, and by an expert at least every 12 months. This checklist is the site-wide walk, with a place to confirm the racking regime and the truck checks are running. The building itself, from the roof to the electrical certificates, belongs in the Facility Inspection Checklist, and deciding which controls a hazard needs belongs in the Health & Safety Risk Assessment Checklist.

Safety inspection

A competent person, every month

Asks: are the racking, routes, docks, trucks, exits and welfare in the state the risk assessment expects?

When: on a monthly recurring schedule, while the warehouse is working.

Output: findings with risk ratings, actions with owners and dates, urgent hazards made safe and the site manager’s sign-off.

Forklift pre-use check

The operator, every shift

Asks: is this truck safe to use today?

When: before the truck is used, at the start of each shift. That is the Forklift Pre-Use Inspection Checklist.

Output: a recorded check, and a truck with a safety-critical defect kept out of use until it is repaired.

Expert racking inspection

A technically competent person, at least yearly

Asks: is each part of the racking still fit to carry its rated load?

When: at intervals of not more than 12 months in HSE guidance, by a trained in-house specialist, a specialist from the rack supplier or an independent qualified rack inspector.

Output: a written report to the person responsible for racking safety, with observations and proposals for any action needed.

What the Warehouse Safety Inspection Checklist Covers

Eight phases follow one safety walk of a warehouse, from the records to the re-check. The tasks to offload and isolate damaged racking appear only when damage is rated amber or red, a blocked or locked exit adds a task to clear it at once, and a UK or US answer adds the matching legal notes and checks. The site manager approves the inspection and action plan before the re-check and sign-off.

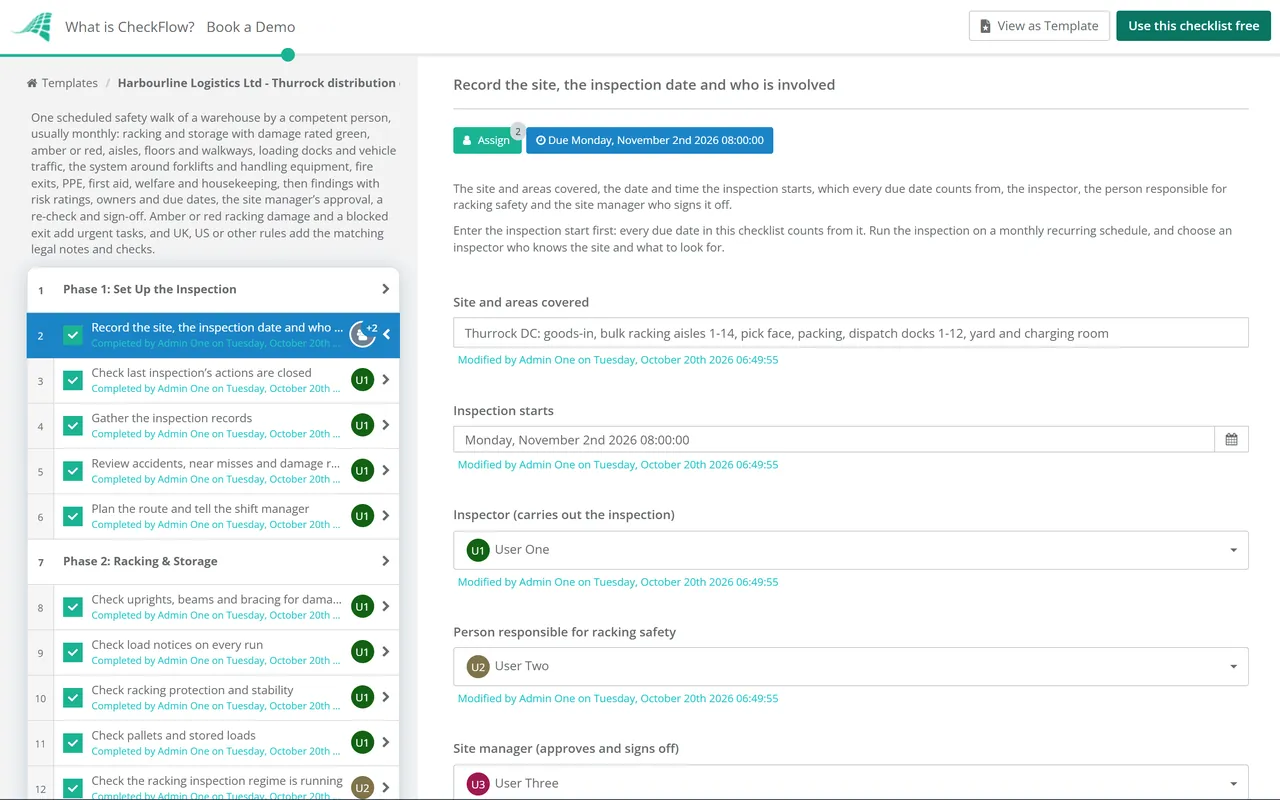

  1. Phase 1

    Phase 1: Set Up the Inspection

    5 tasks

    Answer which rules apply first; it adds the matching legal notes and tasks. Every due date counts from the date and time the inspection starts.

    • Record the site, the inspection date and who is involved — the site and areas covered, the date and time the inspection starts, which every due date counts from, the inspector, the person responsible for racking safety and the site manager who signs it off
    • Check last inspection’s actions are closed — every action from the last inspection, its owner and whether it was done; an action still open goes onto this inspection’s plan
    • Gather the inspection records — the racking inspection log and the last expert racking report, damage reports since, truck maintenance and examination records, operator training records, the fire risk assessment and the accident book
    • Review accidents, near misses and damage reports since the last inspection — each one points to a place or a job to look at closely on the walk, such as a racking strike, a near miss at a crossing or a slip in the same aisle
    • Plan the route and tell the shift manager — walk every area in the same order each month, while the warehouse is working so you see how people and trucks really move, and agree where the inspector can walk safely
  2. Phase 2

    Phase 2: Racking & Storage

    8 tasks

    Inspect racking from the ground unless there are signs of damage at high level. Rate the worst damage green, amber or red; amber or red adds the tasks to deal with it.

    • Check uprights, beams and bracing for damage — dents, bends, splits and twisted bracing, beam connector locks in place, and base plates and floor fixings secure; uprights at aisle ends and corners take the most knocks
    • Check load notices on every run — a clear notice fixed to the racking showing the maximum load and any load configuration, and loads within it; a beam moved since the notice was written means the notice needs checking
    • Check racking protection and stability — column guards and end-of-run barriers in place and undamaged, racking fixed to the floor where trucks work, and nothing altered or removed without the supplier’s approval
    • Check pallets and stored loads — pallets sound and the right type for the racking, loads stable, wrapped and not overhanging, stacks stable and limited in height, and nothing left on the floor in the aisles
    • Check the racking inspection regime is running — visual inspections recorded weekly or at the interval the person responsible for racking safety has set, an expert inspection by a technically competent person within the last 12 months, and staff know how to report damage straight away
    • Rate the racking damage found — green needs no repair but is recorded and rechecked at the next inspection, amber needs repair as soon as possible, and red needs the area offloaded and isolated at once; the answer decides which of the next two tasks appear
    • Label amber-rated locations and book the repair — amber damage needs repair as soon as possible; once the load is taken off a damaged location it is not reloaded until it is repaired, a dated label shows it is out of use, and amber damage not repaired within four weeks is treated as red
    • Offload and isolate red-rated bays now — unload the bay, rope or barrier it off so nobody reloads it, tell the person responsible for racking safety the same day, and book the repair, usually a replacement component
  3. Phase 3

    Phase 3: Aisles, Floors & Walkways

    6 tasks

    Walk every aisle and walkway. A floor defect that cannot be repaired at once is barriered or marked until it is.

    • Check aisles and gangways are marked and clear — storage areas, aisles and gangways marked on the floor, nothing stored across or in an aisle, and room for the trucks that use them to turn and pass
    • Check floor surfaces — holes, cracks, ruts, uneven or broken areas and standing water, especially where trucks run, and damaged areas barriered off until they are repaired
    • Check for spills, leaks and slip hazards — oil and hydraulic fluid from trucks, water from roofs and doors, shrink-wrap and packaging on the floor, and spill kits where they are needed
    • Check pedestrian walkways and crossing points — marked walkways, barriers where people walk beside trucks, crossing points where drivers can see them, separate pedestrian doors beside vehicle doors, and people using them
    • Check lighting, mirrors and warning signs — lighting working along aisles and at doors with no sudden change from bright to dark, mirrors at blind corners, and signs where truck drivers must sound the horn
    • Check stairs, mezzanines and open edges — handrails on stairs, guard rails on mezzanine edges and at loading points, and open pits and holes covered or guarded
  4. Phase 4

    Phase 4: Loading Docks & Vehicle Traffic

    6 tasks

    Watch at least one vehicle being loaded or unloaded. Drivers, pedestrians and trucks should never share space without a control.

    • Check the yard traffic routes and signs — one-way systems and speed limits, road markings and signs, pedestrian routes kept apart from lorries, and reversing areas kept clear of people
    • Check how drive-aways are prevented at each bay — a trailer restraint, an interlock, keys or paperwork held until it is safe to go, or traffic lights, used every time so no vehicle pulls away before loading is finished
    • US: check trailers are chocked and braked before trucks board them — the trailer’s brakes set and wheel chocks under the rear wheels, and fixed jacks under a trailer that is not coupled to a tractor where they are needed
    • Check dock edges, levellers and dock plates — dock edges marked, levellers returned flush after use with toe guards in place, defects reported and repaired, and dock plates secure and strong enough for the truck and its load
    • Check where visiting drivers wait — drivers told the site rules when they arrive, clear about who is in charge while the vehicle is loaded, and waiting in a safe area away from the loading bay
    • Check loads are secured before vehicles leave — the vehicle floor checked before loading, loads stable and spread evenly, and the far curtain or side kept closed while a trailer is loaded from one side
  5. Phase 5

    Phase 5: Forklifts & Handling Equipment

    7 tasks

    This phase checks the system around the trucks, not the trucks themselves. Each operator’s check of their truck at the start of a shift has its own checklist.

    • Check pre-use checks are done and defects acted on — a recorded check for every truck on every shift, defects reported to the supervisor, and a truck with a safety-critical defect kept out of use until it is repaired
    • Check operator training and authorisation records — only trained and authorised operators drive, each on the truck types they were trained on, with refresher training where it is due
    • Check truck keys are controlled — keys kept in a secure place, issued by a responsible person and returned at the end of the shift, and no truck left unattended with the key in or the keypad live
    • UK: check each truck’s thorough examination is in date — a report of thorough examination of the lifting parts within the last 12 months, or 6 months for a truck that lifts people, kept for at least two years
    • Check the battery charging and refuelling areas — a separate, ventilated charging area with no smoking or naked flames, chargers protected from trucks, facilities to flush and neutralise spilled electrolyte, and LPG cylinders changed outside
    • Check pallet trucks, roll cages and other handling aids — in good repair with wheels running freely, hand pallet trucks inspected at least every 12 months, and damaged roll cages taken out of use
    • Watch how trucks are driven — speed suited to the area, forks lowered when travelling, no passengers, horns used at blind corners, and trucks never parked in front of exits or fire equipment
  6. Phase 6

    Phase 6: Fire Safety & Emergency Exits

    6 tasks

    A blocked or locked exit adds a task to clear it before the inspection goes on.

    • Check every fire exit and escape route is clear — routes and exits free of pallets, stock and trucks, and exit doors opening easily in the direction of escape and not locked
    • Clear the blocked or locked exit now — move the obstruction or unlock the door before the inspection goes on, and find out why it happened so it does not happen again
    • Check exit signs and emergency lighting — exit signs in place and visible, signs showing the way where the exit is not obvious, and emergency lighting tests up to date
    • Check alarm call points and extinguishers can be reached — nothing stacked in front of them, and the monthly extinguisher checks recorded
    • Check combustible waste and storage — packaging and waste in suitable containers and removed regularly, no combustible rubbish stored against the building, and flammable materials kept away from ignition sources
    • Check fire doors and fire protection equipment — fire doors closing properly and not wedged open, and sprinklers, alarms and fire doors undamaged and clear of stock
  7. Phase 7

    Phase 7: PPE, First Aid, Welfare & Housekeeping

    6 tasks

    Look at how people are working as well as at the building. Ask, do not only look.

    • Check PPE is worn and in good condition — safety footwear, high-visibility clothing and gloves as the risk assessment requires, worn by staff and visitors, with replacements available
    • Check first aid provision — a stocked first-aid box, a notice saying who the first aiders or appointed persons are and where the box is, and enough first aiders on every shift
    • Check toilets and washing facilities — clean, lit and ventilated, with hot and cold water, soap and a way to dry hands, and easy to reach from the warehouse floor
    • Check general housekeeping — shrink-wrap, strapping, broken pallets and packaging cleared from the floor, and waste bins and skips emptied before they overflow
    • Watch manual handling at picking and packing — heavy or awkward items, high and low picks, twisting and long carries, and whether pallet trucks, roll cages and other handling aids are available and used
    • Ask workers what concerns them — two or three people on the floor about near misses, damage they have seen and anything that makes the safe way of working hard to follow
  8. Phase 8

    Phase 8: Findings, Actions & Sign-Off

    6 tasks

    Every finding gets a risk rating, an owner and a due date. The site manager approves the inspection and action plan, and nothing after that step can be completed until a decision is recorded.

    • Record every finding with a risk rating — each finding, where it is and a rating of high, medium or low; high means someone could be seriously hurt soon if nothing changes
    • Agree an action, owner and due date for each finding — high-risk findings fixed or controlled within days and the rest planned, each action with the person who can fix it
    • Confirm urgent hazards are controlled — red-rated racking offloaded and isolated, blocked exits cleared and anything else that could cause serious injury made safe on the day it was found
    • Site manager approves the inspection and action plan — the findings, ratings, owners and dates checked, and any urgent hazard confirmed as controlled, before the plan is issued
    • Re-check high-risk actions are done — walk back to each high-risk finding after its due date and record whether the fix worked; anything still open is escalated to the site manager
    • Site manager signs off and confirms the next inspection — the inspection recorded as complete, the action plan filed with the inspection record, and the date of next month’s inspection confirmed on the recurring schedule

Warehouse Safety Rules in the UK and US

Great Britain sets most warehouse duties in general regulations and explains them in HSE guidance; the US writes them into OSHA’s general industry standards. The rows follow the order of the inspection. Use the table to set your own site rules; it is not legal advice.

Topic Great Britain (regulations and HSE guidance HSG76) United States (29 CFR 1910)
Racking inspectionWork equipment exposed to deterioration that could lead to danger is inspected at suitable intervals, and the result recorded (PUWER regulation 6). HSG76: a person responsible for racking safety, visual inspections weekly or at other intervals based on risk with a written record, and an expert inspection at least every 12 monthsNo racking inspection interval in 1910.176. Storage must not create a hazard, and material stored in tiers is stacked, blocked, interlocked and limited in height so it is stable (1910.176(b))
Damaged rackingHSG76 Table 11: green needs surveillance only; amber needs repair as soon as possible and is treated as red if not repaired within four weeks; red is offloaded and isolated at once until repairedNot set out in 1910.176 or 1910.22: follow the racking manufacturer’s instructions and your racking inspector
Load markingA notice fixed to the racking stating the maximum load and any load configuration (HSG76). HSE: safe working load markings where safe use depends on the racking not being overloadedEach walking-working surface supports its maximum intended load (1910.22(b)); signs warn of clearance limits (1910.176(e))
Floors and aislesNo hole, slope or uneven or slippery surface that exposes anyone to risk, and kept free of obstructions so far as reasonably practicable (Workplace Regulations regulation 12). Aisles and gangways marked on the floor (HSG76)Surfaces inspected regularly and as necessary, and hazards fixed or guarded before anyone uses them (1910.22(d)). Aisles kept clear and in good repair, and permanent aisles marked (1910.176(a))
People and vehiclesThe workplace organised so pedestrians and vehicles can circulate safely, with sufficient separation where they share a route (Workplace Regulations regulation 17)Sufficient safe clearances for aisles, loading docks, doorways and turns where mechanical handling equipment is used (1910.176(a))
Loading docksA safe system of work so drivers never move off until the load is secure and it is safe to leave, monitored regularly (HSG76)Brakes set and wheel chocks under the rear wheels of highway trucks before powered industrial trucks board them (1910.178(k)(1))
Lift truck operatorsA system so that trucks are used only by authorised operators (HSG76)Trained and evaluated before operating, evaluated at least once every three years, and the training and evaluation certified (1910.178(l))
Lift truck checksA documented check at the start of each shift; lifting parts thoroughly examined at least every 12 months, or every 6 months if the truck lifts people, with the report kept for at least two years (HSG76)Examined before being placed in service, at least daily, and after each shift where trucks run round the clock; defects reported and corrected immediately (1910.178(q)(7))
Battery chargingA separate, well-ventilated area marked no smoking and no naked lights (HSG76)Designated areas with facilities for spilled electrolyte, fire protection, protection from trucks and ventilation, and no smoking (1910.178(g))
ExitsRoutes and exits kept clear, emergency doors opening in the direction of escape and not locked, and signs and emergency lighting where needed (Fire Safety Order article 14, England and Wales)Exit routes free and unobstructed, with nothing placed in them even temporarily; sprinklers, alarms, fire doors and exit lighting working; exits marked “Exit” (1910.37)

Scotland and Northern Ireland. The Workplace Regulations and PUWER extend to England, Wales and Scotland but not to Northern Ireland, and the Fire Safety Order applies in England and Wales only. Check the rules where your warehouse is.

Industry guidance. HSG76 points to SEMA (the Storage Equipment Manufacturers’ Association) for detailed guidance on classifying racking damage, and names SEMA’s approved rack inspector (SARI) scheme for qualifying expert inspectors. Work from your own copy or your racking inspector’s procedures for the detail this table leaves out.

Why Run Warehouse Safety Inspections in CheckFlow?

1

An inspection waiting every month

A monthly recurring schedule starts each site’s inspection on time, with every due date counted from its start and each task assigned to the inspector, the person responsible for racking safety or the site manager named on the first task. An inspection that has not been finished shows as an open checklist on the Reports Grid.

2

Damage that cannot be left loaded

Rating racking damage amber or red adds the tasks to label or offload and isolate it, assigned to the person responsible for racking safety and due the same day for red. A blocked or locked exit adds a task to clear it at once. The damage table, photos and times sit on the task that recorded them.

3

One plan, approved and re-checked

Findings and actions go into two tables with a risk rating, an owner and a due date. The site manager approves the inspection and action plan, and nothing after that approval step can be completed until they record a decision. A re-check task follows, and every answer is kept with who gave it and when.

CheckFlow does not inspect racking or certify a warehouse as safe. That stays with your inspector, the person responsible for racking safety and your racking inspector. It makes sure the walk happens every month, that damage and blocked exits reach someone who acts on them the same day, and that every action has an owner and a date. Compliance checklist software shows how recurring inspections like this one run across sites.

Operators check their own truck each shift with the Forklift Pre-Use Inspection Checklist, new starters learn the traffic rules in the Warehouse Employee Onboarding Checklist, and the monthly extinguisher round sits in the Fire Extinguisher Inspection Checklist. When a finding needs a new control, work it through the Health & Safety Risk Assessment Checklist.

Workflow Map

See the Warehouse Safety Inspection Checklist as a flowchart

CheckFlow draws every template as a Workflow Map. This is the template behind the live checklist above, drawn from the template itself, so the flowchart and the checklist your team runs never drift apart.

The interactive map zooms and pans, lists every rule beside the diagram, and downloads as a PNG, a one-page PDF or an SVG. More about the Workflow Map.

  • Every task in order, under its phase
  • The rules that show or hide tasks
  • Due dates counted from other tasks, dates or the start
  • Halts that hold later tasks until a step is done
Open the interactive map
Workflow Map of the Warehouse Safety Inspection Checklist template: every task in order under its phase, with the rules that show or hide tasks, the due dates counted from other tasks and the halts
AI generator

Didn’t find what you need? Describe it.

Describe the process in a sentence and the AI checklist generator drafts the phases and tasks for you.

Frequently Asked Questions

How often should a warehouse safety inspection be carried out?

There is no single legal interval for a whole-site walk, and a monthly inspection is a practical rhythm for most warehouses. In the US, 29 CFR 1910.22 requires walking-working surfaces to be inspected regularly and as necessary. In Great Britain, HSE’s warehouse guidance HSG76 asks for racking to be inspected visually every week or at other intervals based on risk, with an expert inspection at least every 12 months, and PUWER requires work equipment that deteriorates to be inspected at suitable intervals. Inspect again after anything that could have caused damage, such as a racking strike.

What should a warehouse safety inspection checklist include?

Racking and storage, including damage, load notices, protection and the racking inspection regime; aisles, floors, walkways, lighting and open edges; loading docks, drive-away prevention and the separation of vehicles and pedestrians; the system around forklifts, such as pre-use checks, training records, keys and battery charging; fire exits, signs and fire equipment; and PPE, first aid, welfare, housekeeping and manual handling. It should end with findings rated by risk, actions with owners and due dates, and a sign-off.

What do red, amber and green mean in a racking inspection?

They are the damage categories in Table 11 of HSE’s HSG76. Green damage needs no repair or reduction in load, but is recorded and looked at again at later inspections. Amber is hazardous damage that needs repair as soon as possible: once the load is off, the location is not reloaded until it is repaired, and amber damage not repaired within four weeks is treated as red. Red is very serious damage: the area is offloaded at once and isolated until it is repaired, usually by replacing the damaged component.

Who can inspect warehouse racking?

HSG76 asks for a nominated person responsible for racking safety, who decides how often the racking is inspected and receives every damage report. Visual inspections are made weekly or at other intervals based on risk, with a written record. An expert inspection at least every 12 months is done by a technically competent person: a trained specialist in your organisation, a specialist from the rack supplier or an independent qualified rack inspector. HSG76 names SEMA’s approved rack inspector (SARI) scheme for qualifying expert inspectors.

Which OSHA standards apply to a warehouse safety inspection?

The general industry standards in 29 CFR 1910. This checklist follows four of them: 1910.22 for walking-working surfaces (kept clean, inspected and repaired), 1910.37 for exit routes (free, unobstructed, lit and marked), 1910.176 for handling and storing materials (clear, marked aisles, stable storage and housekeeping) and 1910.178 for powered industrial trucks (operator training, daily examination, battery charging and chocking trailers). Other standards may also apply to your site, for example for hazardous chemicals or fire extinguishers.

How do you keep pedestrians and forklifts apart in a warehouse?

Separate them wherever you can. In Great Britain, regulation 17 of the Workplace Regulations requires a workplace to be organised so that pedestrians and vehicles can circulate safely, with sufficient separation where they share a route. HSG76 says complete separation should be the first consideration, and lists controls such as pedestrian-only areas, marked walkways, barriers and kerbs, crossing points, separate pedestrian doors, traffic lights, better lighting, high-visibility clothing and no-pedestrian areas during loading.

What should happen when an inspection finds a serious hazard?

Make it safe the same day. Offload and isolate red-rated racking, clear a blocked exit at once and barrier off a damaged floor. In the US, 1910.22(d) requires a hazard on a walking-working surface to be corrected before anyone uses the surface again, or guarded until it is, and 1910.37 requires exit routes to be kept free of materials, even temporarily. Then record the finding, give it an owner and a date, and re-check that the fix worked.

Is CheckFlow free for this template?

14-day free trial, no card required. The Business plan is $10 per user per month after the trial. Full details at checkflow.io/pricing.

Inspect Every Aisle, Dock and Exit, Every Month

Free trial — no credit card required.

14-day free trial, no credit cardFull refund in your first 30 daysUS hosting, EU on request
