Customer Escalation Checklist Template

The customer’s operations director emailed your chief executive at seven in the morning. By lunchtime support, engineering and the account manager had each replied, with three different answers and no date for a fix.

Last reviewed: October 2026

Printed from checkflow.io/templates/customer-management/customer-escalation-checklist

This free customer escalation checklist is for support managers, customer success managers, account managers and escalation managers in B2B and SaaS companies. One run handles one escalation for one customer: a critical defect, an outage on their account, a missed commitment, a billing dispute or an unhappy executive. You log it and triage it by severity, business impact and the customer’s own deadline, name one escalation owner and decide whether an executive sponsor is needed. The customer gets a quick acknowledgement with a named contact and the time of the next update. The type of escalation adds its own diagnosis task, and each team you need, such as engineering, operations, delivery, billing or product, gets its own task to accept the work. An action plan with owners and dates goes to the customer, updates follow at the times you promised, and the fix is confirmed with the customer. The escalation closes only when the customer agrees, and a closure review records the root cause, what will change and whether the account is now at risk.

An Escalation Is One Customer’s Problem That Cannot Wait

A customer escalation is a customer telling you that the normal route has failed them. A critical bug has sat in the queue for a week, the service has been down for their team all morning, a promised delivery date has passed, or their operations director has written to your chief executive. In B2B and SaaS the issue is usually urgent for the customer, it needs more than one team to fix, and several people on your side start replying at once with different answers.

This checklist runs one escalation, from the moment it is raised to a closure review: one owner, a quick acknowledgement, the teams who can fix it, an action plan, updates at the times you promised, and closure only when the customer agrees. It is more than one ticket, which the Support Ticket Response Checklist handles. It is not an incident that affects your service for many customers, which runs through your IT incident management process; an escalation can sit alongside one. And it is not the regulated complaints process a bank or lender must follow, which is the Customer Complaints Handling Checklist. Open an At-Risk Customer (Churn Prevention) Checklist as well when the issue puts the whole account at risk of leaving.

One ticket

Answer and resolve a support request

When: every time a customer raises a ticket.

Covers: acknowledgement, triage and priority, investigation, the reply, resolution and closure.

Output: a resolved ticket. The Support Ticket Response Checklist.

One escalation

Fix an urgent problem for one customer

When: a customer escalates a critical issue, an outage on their account, a missed commitment, a dispute or a complaint about the service.

Covers: triage, one owner, an executive sponsor when needed, the teams who can fix it, an action plan, regular updates, the fix confirmed with the customer and a closure review.

Output: an issue fixed and closed with the customer’s agreement, and the root cause recorded. This checklist.

The whole account

Keep a customer who may leave

When: the account is flagged at risk of leaving or cutting back, at any point in the term.

Covers: the warning signs, the root cause confirmed with the customer, executive outreach, an approved save plan and the outcome.

Output: a saved, downgraded or churned account. The At-Risk Customer (Churn Prevention) Checklist.

What the Customer Escalation Checklist Covers

Eight phases take one customer escalation from the moment it is raised to the closure review. The type of escalation adds its own diagnosis task, a critical severity adds a daily internal stand-up, and each team you bring in gets its own task to accept the work. An executive sponsor adds a phase of their own when the escalation needs one, and a service credit or goodwill gesture adds a task for finance. The customer’s agreement to close is the gate: nothing after it can be completed until it is recorded. A fix the customer does not accept reopens the plan, and an account now at risk of leaving adds a task to open an at-risk case.

  1. Phase 1

    Phase 1: Log & Triage the Escalation

    6 tasks

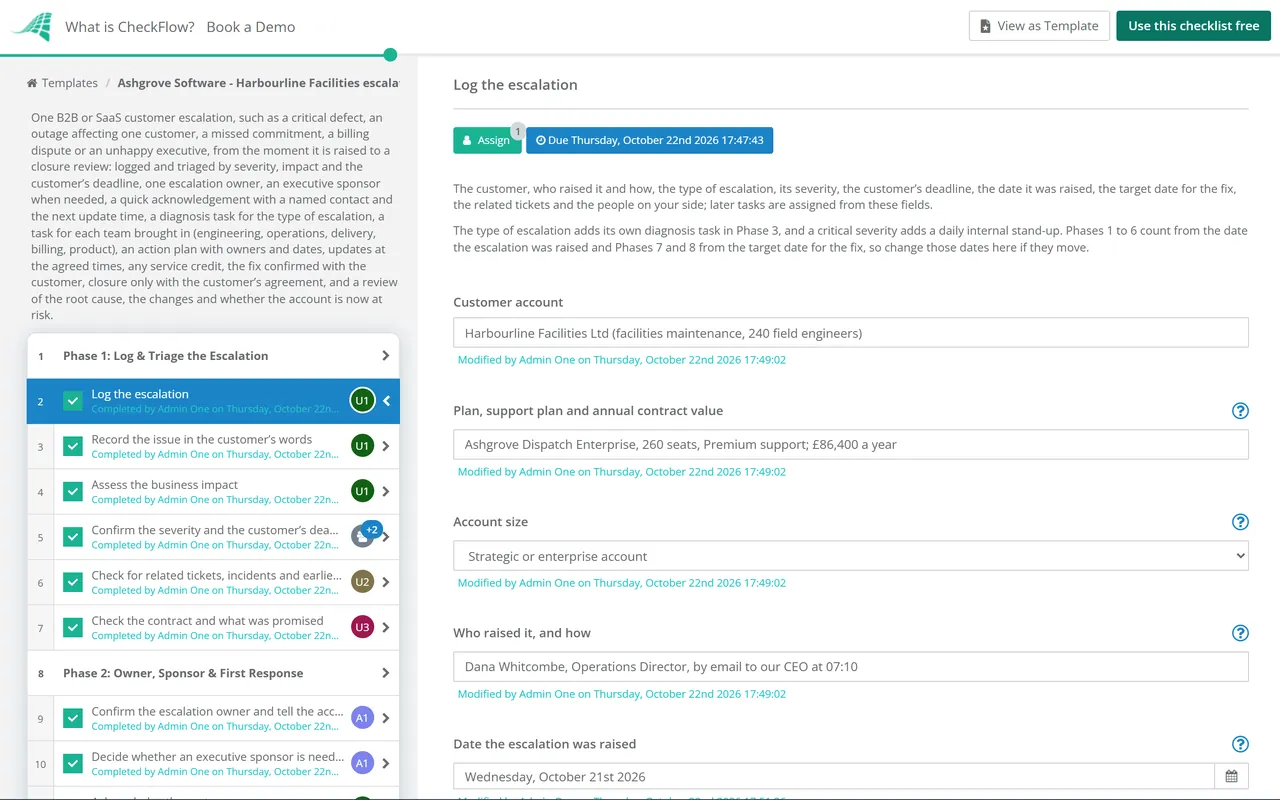

    Log the escalation the moment it is raised, in one place. Enter the date it was raised and your target date for the fix: every due date counts in business days from one of them. Triage by severity, business impact and the customer’s own deadline.

    • Log the escalation — the customer, who raised it and how, the type of escalation, its severity, the customer’s deadline, the date it was raised, the target date for the fix, the related tickets and the people on your side; later tasks are assigned from these fields
    • Record the issue in the customer’s words — what the customer reported, when it started, what it stops them doing and what they have asked for, quoted from their email or call rather than translated into internal terms
    • Assess the business impact — the users, teams or sites affected, the processes that have stopped, the money or deadlines at risk on their side, and whether a workaround exists
    • Confirm the severity and the customer’s deadline — the severity checked against the impact using your own definitions, the customer’s deadline and the reason for it, and both corrected on the first task if they were wrong
    • Check for related tickets, incidents and earlier escalations — open and recent tickets from this customer, any incident your service is running now, and earlier escalations on the account; if other customers are affected, run your incident process as well and keep this customer informed from it
    • Check the contract and what was promised — the support plan and any response or resolution times in the contract, service credits, and anything promised in sales, in the statement of work or in earlier tickets
  2. Phase 2

    Phase 2: Owner, Sponsor & First Response

    6 tasks

    One person owns the escalation from start to finish, and the customer hears from them quickly with a named contact and the time of the next update. Decide here whether an executive sponsor is needed.

    • Confirm the escalation owner and tell the account team — one escalation owner confirmed, and support, the account owner and anyone else who speaks to the customer told who it is, so nobody replies with a different message
    • Decide whether an executive sponsor is needed — by severity, account size and who raised it; a yes adds the executive sponsor steps in Phase 5
    • Acknowledge the customer — a reply from the escalation owner by name that says you have it, what you know so far, what happens next and when they will next hear from you
    • Open one internal channel for the escalation — one chat channel or thread and this checklist as the record, with the customer, the severity, the owner and the next update time at the top
    • Agree the update rhythm with the customer — how often they will hear from you, by which channel and who on their side gets the updates, using the update targets your team has set for this severity
    • Critical: run a daily internal stand-up until the fix is confirmed — a short daily call with the escalation owner and every team working on it: progress, blockers and what goes in the next customer update
  3. Phase 3

    Phase 3: Diagnose the Issue

    7 tasks

    Find out what is wrong before you promise a fix. The type of escalation chosen on the first task adds one diagnosis task here, assigned to the person who can see the facts.

    • Reproduce or confirm the problem — the steps, the account, the environment, logs and screenshots, and whether it is a defect, a configuration, a data problem or a misunderstanding
    • Product defect: get the bug confirmed and prioritised by engineering — a bug raised with steps to reproduce, the customer and the severity on it, a priority agreed with engineering and any workaround support can offer now
    • Outage or performance: confirm the scope and the timeline of the impact — what is down or slow for this customer, since when, whether other customers are affected, and the incident reference if your incident process is running
    • Missed commitment: find out what was promised, by whom and what went wrong — the promise in writing, who made it, what was delivered and when, and why it slipped
    • Billing or contract dispute: check the invoices and the contract — the invoices in dispute, the contract terms and the order form, what the customer expected and why, and payment reminders paused while it is reviewed
    • Service complaint: review the history of the relationship — recent tickets, response times, meetings and promises, who on the customer’s side is unhappy and why, and whether this is one event or a pattern
    • Write up the likely cause and the options — what is known and not known about the cause, the options to fix it or work around it, the effort and risks of each, and what you can tell the customer now
  4. Phase 4

    Phase 4: Bring In the Teams Who Can Fix It

    7 tasks

    Choose the teams the fix needs. Each team ticked adds its own task, assigned to its lead with the escalation owner, so every team accepts the work and gives a date rather than hearing about it in a chat thread.

    • Decide which teams are needed — the teams who can fix the cause or help the customer in the meantime; support is already involved through the support lead
    • Engineering: accept the work and give a fix estimate — the bug or change accepted, an engineer named, an estimate for the fix or a workaround, and how it will be released to the customer
    • Operations or hosting: stabilise the service for this customer — what can be done now for this account, such as more capacity, a restart, a data repair or a restore, and how the service will be watched until the fix is in
    • Delivery or professional services: plan the work on the customer’s setup — configuration changes, a migration step to redo, or training for the customer’s team, with a named consultant and dates
    • Billing and finance: review the account and hold any reminders — the invoices and payments on the account, reminders or a credit hold paused while the escalation is open, and what finance can correct or credit
    • Product management: decide on the gap or the roadmap question — whether the missing feature or behaviour will be built, when, or not at all, and an honest answer the escalation owner can give the customer
    • Agree the priority with each team’s lead — the escalation’s priority against each team’s other work made explicit, so the fix does not wait in a queue, and any conflict taken to the manager who can decide it
  5. Phase 5 — When needed

    Phase 5: Executive Sponsor (When Needed)

    3 tasks

    Applies when Phase 2 decides the escalation needs an executive sponsor, for example a critical severity, a strategic account or an executive on the customer’s side. The sponsor speaks to their counterpart and backs the plan with the resources it needs.

    • Brief the executive sponsor — the customer, the issue in their words, the impact, the likely cause, what has been promised, what the sponsor should say and what they should not offer
    • Executive sponsor calls the customer’s executive — the sponsor acknowledges the problem and its impact, listens, and commits to the steps you can deliver and to the update rhythm
    • Record what the executives agreed — every commitment made on both sides, with owners and dates, ready to go into the action plan
  6. Phase 6

    Phase 6: Action Plan & Customer Updates

    7 tasks

    Write the plan down, with an owner and a date for every action, and share it with the customer. Then update them at the times you promised, including when there is no news. A service credit or goodwill gesture adds a task for finance.

    • Write the action plan — every action to fix the issue and to help the customer in the meantime, each with an owner, a due date and a status, and the target date for the fix updated on the first task
    • Review the action plan with the escalation manager — the actions, owners and dates checked, nothing promised that a team has not agreed, and the plan approved to go to the customer
    • Share the action plan with the customer — the plan, the dates, anything you need from them, such as access, test data or a contact, and the time of the next update
    • Send updates at the agreed times — every update sent when promised, with progress, what is next and the next update time; complete this task when the fix is delivered
    • Chase actions that slip — actions that are late or blocked, what is blocking them and what is needed, such as a decision, a resource or the executive sponsor, with the customer told about any new date
    • Decide on any service credit or goodwill gesture — whether a service credit is due under the contract, whether a goodwill gesture is right, and its value; anything other than none adds a task for finance
    • Credit or gesture: agree it with finance and record it — the amount and how it is given, approved under your own limits, put through billing and confirmed to the customer in writing
  7. Phase 7

    Phase 7: Deliver & Confirm the Fix

    6 tasks

    A fix is only done when the customer says it works. Deliver it, check it in their account, confirm it with them and watch for a recurrence. The customer’s agreement to close is the gate: nothing after it can be completed until it is recorded.

    • Deliver the fix or the workaround — the fix released, the configuration changed or the invoice corrected, with the date and what changed
    • Check the fix works in the customer’s account — the original problem tested again in their account, with the steps from Phase 3, before the customer is asked
    • Confirm the fix with the customer — the person who raised it, or the person they named, confirms that it works for them; partly fixed or not fixed adds a task to reopen the plan
    • Not fixed: agree what is still wrong and reopen the plan — what still fails, new actions added to the plan with owners and dates, the target date for the fix moved on the first task, and the customer told; change the answer above when it is fixed
    • Watch for a recurrence for the agreed period — the account watched for the period agreed with the customer, with any new ticket on the same issue routed to the escalation owner
    • Customer agrees to close the escalation — the customer agrees in writing that the escalation can be closed, with their name, the date and anything they still expect from you
  8. Phase 8

    Phase 8: Close & Review

    7 tasks

    Close the record, then review the escalation while it is fresh: the root cause, what changes so it does not happen again, and whether the account is now at risk of leaving. An account at risk adds a task to open an at-risk case.

    • Close the escalation and the tickets — the tickets and the internal channel closed, the CRM updated, and the customer told who to contact from now on
    • Record the root cause — the main cause with the evidence, and why it reached an escalation rather than being solved as a ticket
    • Hold the closure review — the timeline from the first report to closure, the updates against what was promised, what went well, what did not and what to do sooner next time
    • Agree the changes that stop it happening again — changes to the product, the process, the documentation or the way promises are made, each with an owner and a date
    • Decide whether the account is now at risk — whether the escalation has put the whole account at risk of leaving or cutting back, from what the customer has said and the state of the relationship; yes adds a task to open an at-risk case
    • At risk: open an at-risk case for the account — start the at-risk customer checklist with this escalation as one of the signals, so the account gets a save plan as well as a fix
    • Share the lessons and close the review — the root cause, the changes and the lessons shared with the teams involved, and every task complete or marked not applicable

Types of Customer Escalation and Who to Bring In

The five kinds of escalation most B2B and SaaS teams see, matching the choices on the checklist’s first task. Each one adds its own diagnosis task. The table says who usually needs to be involved, what the first update to the customer should say and the trap to avoid.

Type of escalation What it often looks like Who to bring in What the first update should say Watch out for
Product defect or bugA feature broken after a release, wrong results or errors in a key workflowEngineering, through support, with the steps to reproduceThat the problem is confirmed, who is working on it, any workaround and the next update timePromising a fix date before engineering has given one
Outage or performance problem for this customerThe service down or very slow for this account, or an integration that has stoppedOperations or hosting, and engineeringWhat is affected, since when, what you are doing now and when you will update nextOther customers affected: run your incident process too, and keep this customer informed from it
Missed commitmentA delivery date, a promised feature, a migration or a service level missedThe account owner, delivery and whoever made the promiseThat you know what was promised and are finding out what went wrongMaking a new promise before you know you can keep it
Billing or contract disputeAn invoice the customer says is wrong, a renewal price or a credit they expectedBilling and finance, and the account ownerThat the invoice is under review and reminders are paused, and when you will come backPayment reminders still going out while the dispute is open
Complaint about the service or the relationshipA senior person unhappy with response times, attitude or a run of problemsThe account owner, the escalation manager and often an executive sponsorThat a named senior person has heard them and when they will callTreating a pattern of problems as one ticket

Set your own severity levels and update times. There is no single rule for how quickly an escalation must be answered or how often the customer must hear from you. Write down your own targets for each severity, such as how soon the acknowledgement goes out and how often a critical escalation is updated, and check the contract, which may set response times of its own. Record what you promised on the checklist and keep to it: an update at the promised time that says there is no news yet is still worth sending.

Close it with the customer, not for them. A fix your team has released is not the end of an escalation. Check it in the customer’s account, ask the person who raised it to confirm it works, and watch for a recurrence for a period you agree with them. In this template the customer’s agreement to close is the gate, and the closure review that follows asks whether the account is now at risk.

Why Run Customer Escalations in CheckFlow?

1

One owner from the first hour

The first task names the escalation owner, the manager and every team lead who might be needed, and every later task is assigned from those fields. The type of escalation adds its own diagnosis task and each team ticked gets a task of its own, so engineering, finance or delivery accept the work on the record. Due dates count in business days from the day the escalation was raised and, for the last phases, from the target date for the fix.

2

Closed only when the customer agrees

The customer’s agreement to close halts the checklist: the record cannot be closed and the review cannot be completed until it is recorded. A fix the customer does not accept adds a task to reopen the plan. See how tasks that halt a checklist work.

3

Every open escalation in one view

The Reports Grid shows each open escalation and how far it has got, and the Tasks Grid shows each owner and team lead what is due today. The impact, the action plan, the update log and the root cause sit on the tasks they belong to. See analytics and reporting.

CheckFlow does not replace your help desk, your status page or your CRM. Tickets stay in the help desk and outages in your incident tooling. CheckFlow runs the steps for every escalation in the same order, with an owner and a date for each and a record of who did what and when.
