Network Security Audit Checklist Template

The network diagram was accurate the day it was drawn. Since then there has been a new office, a cloud interconnect, a vendor VPN and a switch someone plugged in during a weekend outage.

Printed from checkflow.io/templates/cybersecurity/network-security-audit-checklist

A network security audit compares the network you think you have with the one that is actually running, then checks whether each layer of defence still does its job. It covers architecture and data flows, segmentation, the perimeter, remote access, wireless, the hardening of routers, switches and access points, and the monitoring that should notice when something goes wrong. Most organisations run it once a year and again after a major change such as an acquisition, an office move or a data centre exit. This free network security audit checklist gives the audit a fixed structure: seven phases, each with an owner, evidence attached to every test and findings tracked to closure. Tasks that do not apply, such as wireless configuration checks where no Wi-Fi is deployed or segmentation testing where segmentation is not used to reduce scope, stay hidden.

Network Security Audit vs Firewall Rule Review

The two are often confused because both involve firewalls. A rule review is a focused, frequent check of the policy loaded on each filtering device, and it has its own Firewall Rule Review Checklist. The network audit sits a level above. It asks whether the firewalls are in the right places at all, whether traffic can find a way around them, and whether everything else on the network is configured, patched and watched. The audit should confirm that rule reviews happened on schedule rather than repeat them.

The audit is also narrower than a full IT security audit. It stays at the network layer and leaves policies, endpoint security, identity governance and application security to the wider programme review.

Firewall rule review

Is every rule still justified?

Scope: the rule base on each network filter.

Cadence: every six months, often more.

Performed by: the engineers who run the firewalls, with rule owners.

Output: rules removed or tightened through change control.

Network security audit

Does the network hold up as a whole?

Scope: architecture, segmentation, remote access, wireless, devices and monitoring.

Cadence: annually and after major change.

Performed by: someone independent of day-to-day network operations.

Output: a rated findings report with owners and due dates.

What the Network Security Audit Checklist Covers

Seven phases run from scoping and authorisation to a signed report. Answers in Phase 1 decide whether the segmentation test and the wireless configuration task appear.

  1. Phase 1

    Phase 1: Plan, Scope & Authorise

    4 tasks

    Led by the audit lead. Written authorisation for active testing is an approval step for the system owner or CISO.

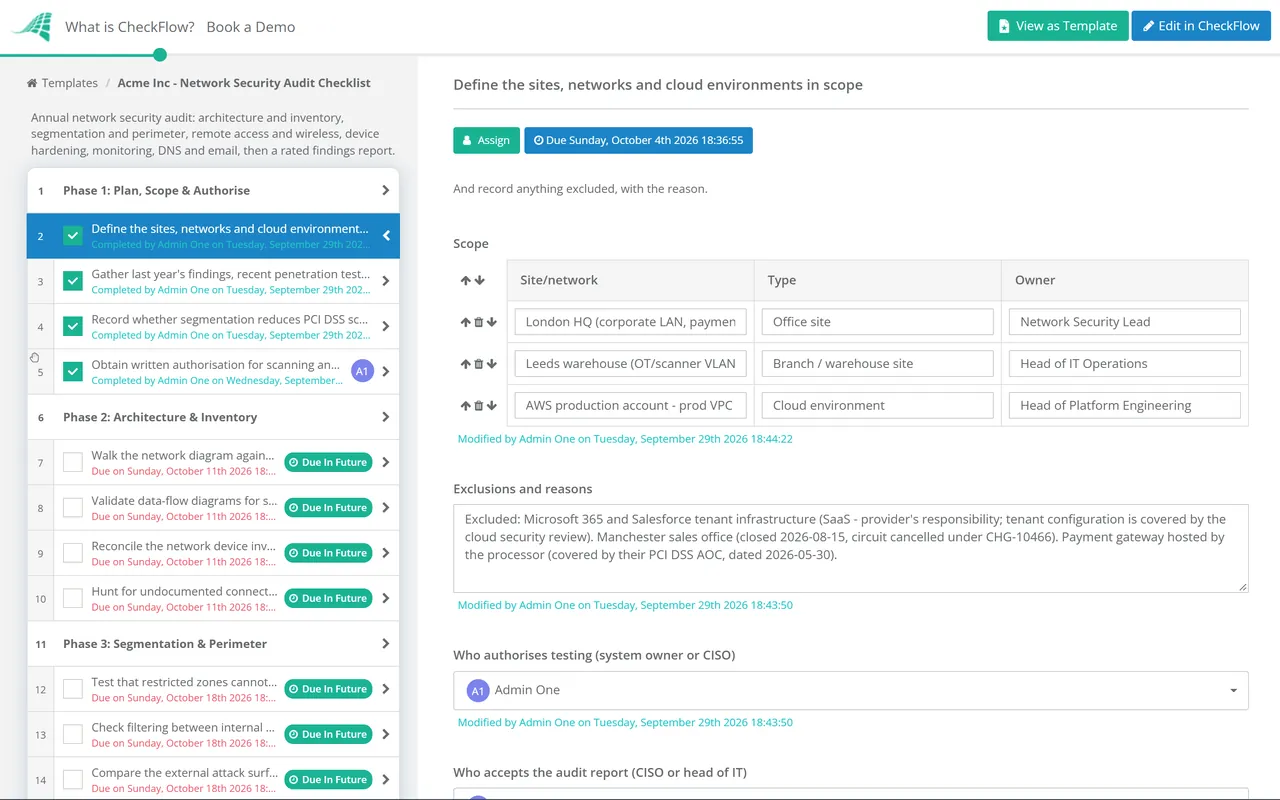

    • Define the sites, networks and cloud environments in scope — and record anything excluded, with the reason
    • Gather last year’s findings, recent penetration test reports and scan results — open items are tested first
    • Record whether segmentation reduces PCI DSS scope and whether any site runs wireless — these answers switch later tasks on or off
    • Obtain written authorisation for scanning and testing — with agreed windows and an emergency contact
  2. Phase 2

    Phase 2: Architecture & Inventory

    4 tasks
    • Walk the network diagram against reality — every connection, including cloud interconnects, partner links and wireless
    • Validate data-flow diagrams for sensitive data — where it enters, crosses and leaves the network
    • Reconcile the network device inventory — routers, switches, firewalls, wireless controllers and VPN gateways, each with an owner
    • Hunt for undocumented connections — site-to-site tunnels, local internet breakouts and forgotten third-party circuits
  3. Phase 3

    Phase 3: Segmentation & Perimeter

    5 tasks

    The PCI DSS segmentation task appears only when segmentation is used to reduce scope.

    • Test that restricted zones cannot be reached from general user networks — attempt connections rather than reading configuration alone
    • Check filtering between internal segments — a flat network lets one compromised laptop reach everything
    • Compare the external attack surface with the approved list — every internet-facing service needs an owner and a reason
    • Confirm the last two firewall rule reviews were completed and signed off — attach the records
    • Confirm segmentation penetration testing is current — within the last 12 months and after any segmentation change
  4. Phase 4

    Phase 4: Remote Access & Wireless

    4 tasks

    The wireless configuration task is hidden when no site in scope runs approved Wi-Fi. Rogue access point detection stays, because an unapproved access point can appear anywhere.

    • Confirm MFA on every remote access path — VPN, remote desktop gateways and vendor support tools
    • Check vendor remote access is enabled only when needed — and that its use is monitored
    • Review wireless configuration — enterprise authentication, current encryption and a guest network isolated from internal systems
    • Confirm rogue access point detection is running — even where no Wi-Fi is approved; PCI DSS expects testing for unauthorised access points at least every three months
  5. Phase 5

    Phase 5: Device Hardening

    4 tasks
    • Check firmware and operating system versions — supported by the vendor and patched against known vulnerabilities
    • Confirm default accounts and unused services are removed — including vendor default SNMP community strings
    • Review the management plane — SSH or HTTPS only, central authentication, and admin interfaces on a dedicated management network
    • Disable unused switch ports and check port-level access control — an open port in a meeting room is an open door
  6. Phase 6

    Phase 6: Monitoring, DNS & Email

    5 tasks
    • Confirm network devices send logs to the central platform — with synchronised time so events can be correlated
    • Check intrusion detection coverage — at the perimeter and critical internal points, with current signatures
    • Confirm flow logs are collected — they are often the only record of lateral movement
    • Review DNS configuration — trusted resolvers, restricted zone transfers and no records pointing at retired services
    • Check SPF, DKIM and DMARC for every domain — including parked domains that send no mail
  7. Phase 7

    Phase 7: Report & Remediation

    5 tasks

    Acceptance of the report is an approval step for the CISO or head of IT.

    • Rate each finding by risk — with the evidence that supports it and a recommended fix
    • Agree an owner and a due date for every finding — or a documented risk acceptance
    • Obtain management acceptance of the report — including any accepted risks
    • Retest high-risk findings once fixed — and close them only with retest evidence
    • Set the next audit date — twelve months out, or sooner if a major change is planned

How the Audit Maps to Common Frameworks

No framework calls this exact exercise a “network security audit”, but several expect the things it tests. ISO/IEC 27001:2022 groups them under three Annex A network controls. PCI DSS v4.0.1 adds specific cadences, such as annual segmentation testing under 11.4.5 (every six months for service providers under 11.4.6) and quarterly wireless access point testing under 11.2.1. CIS Controls v8.1 asks for network architecture documentation to be reviewed at least annually. The table maps each reference to the phase that evidences it.

Framework Reference What it expects Evidenced in
ISO/IEC 27001:2022 Annex A8.20, 8.21, 8.22Networks security, security of network services and segregation of networksPhases 2–5
PCI DSS v4.0.11.2.3, 1.2.4Accurate network and data-flow diagrams, updated when the environment changesPhase 2
PCI DSS v4.0.111.4.5, 11.2.1Segmentation controls tested at least every 12 months and after change; wireless access points tested for every three monthsPhases 3 and 4
PCI DSS v4.0.12.2.2, 2.2.4, 8.4.3Vendor defaults managed; only necessary services enabled; MFA for remote access that could reach the cardholder data environmentPhases 4 and 5
CIS Controls v8.1Control 12 (12.1, 12.2, 12.4)Network infrastructure kept up to date, a secure architecture, and diagrams reviewed at least annuallyPhases 2 and 5
CIS Controls v8.1Control 13 (13.4, 13.6, 13.9)Filtering between segments, network flow logs and port-level access controlPhases 3, 5 and 6
SOC 2 (2017 TSC, 2022 points of focus)CC6.6, CC7.2Protection against threats from outside the system boundary; monitoring for anomaliesPhases 3, 4 and 6

For testing technique, NIST SP 800-115 remains the standard reference on planning and running technical security assessments. For email, DMARC was republished as a standards-track specification, RFC 9989, in May 2026. Your auditor, assessor or certification body decides what satisfies each control in your scope, so treat the table as a starting point, not legal or audit advice. The framework programmes that call for these checks have their own templates: the PCI DSS 4.0 Compliance Checklist, the NIST CSF 2.0 Checklist and, for UK organisations, the Cyber Essentials Certification Checklist.

Why Run Your Network Audit in CheckFlow?

1

Only the tests that apply

Two answers in Phase 1 shape the rest of the audit. Segmentation testing appears only where segmentation reduces scope, and the wireless configuration check disappears where no Wi-Fi is deployed, so the checklist fits each environment without editing.

2

Evidence attached where it was gathered

Diagrams, scan output, configuration extracts and screenshots are uploaded to the task that tested them. Each task records who completed it and when, so the report can point straight at its proof.

3

Findings that stay visible until closed

Every finding gets an owner and a due date, and dashboards show what is open, overdue or awaiting retest. A yearly schedule opens the next audit automatically, with last year’s export ready to compare against.

CheckFlow is not a network scanner, a configuration auditing tool or a SIEM. It runs the planning, evidence, sign-off and follow-up around those tools. CheckFlow’s compliance checklist software shows how the annual audit sits alongside the shorter recurring reviews in your compliance calendar, and our guide to recurring compliance checklists for IT teams covers how to schedule them.

Most audit findings turn into patching or retesting work. The Vulnerability Management Checklist tracks remediation through to rescan, and the Penetration Test Checklist covers scoping, rules of engagement and retesting when you bring in an external tester.

Two neighbouring templates keep this audit accurate. The IT Asset Management Checklist keeps the device inventory in Phase 2 current, and firmware found out of date in Phase 5 goes into the monthly Patch Management Checklist.

AI generator

Didn’t find what you need? Describe it.

Describe the process in a sentence and the AI checklist generator drafts the phases and tasks for you.

Frequently Asked Questions

What is a network security audit?

It is a structured assessment of an organisation’s network layer: how it is designed and segmented, how traffic enters and leaves, how remote users and wireless devices connect, how network devices are configured, and whether activity is logged and monitored. The auditor compares what is found against internal standards and any frameworks in scope, then reports rated findings with owners and deadlines.

How often should a network security audit be done?

Annually is the common baseline, plus an extra audit after significant change: a merger, a new site, a cloud migration or a redesign of the core network. Some parts run more often inside the audit year. PCI DSS, for example, expects firewall configurations to be reviewed every six months and wireless access points to be tested for every three months, so the annual audit checks that those shorter cycles happened.

Who should carry out the audit?

Someone independent of the team that runs the network day to day. That can be internal audit, a security team outside network operations, or an external firm. Network engineers still take part, since they provide diagrams, configurations and access, but they should not be the ones marking their own work as passed.

Is a network audit the same as a penetration test?

No. A penetration test tries to exploit weaknesses to show what an attacker could achieve. An audit checks configuration, design and process against a defined standard, and uses light active testing, such as connection attempts between segments, to confirm what the documents claim. The two complement each other: the audit should review the latest penetration test findings, and the test is often scoped using the audit’s diagrams.

Should cloud networks be included?

Yes, at the network layer. Virtual networks, peering links, transit gateways, VPN attachments and cloud firewalls belong on the same diagram as the office and data centre, because traffic moves between them. Account-level settings such as identity and access management, storage exposure and logging configuration are better covered by a dedicated cloud security review, so this audit links to that evidence rather than repeating it.

Why are DNS and email records part of a network audit?

Because they are network-facing configuration that attackers use directly. A DNS record left pointing at a retired cloud service can be taken over, and a domain without a DMARC policy is easy to spoof in phishing emails. These records are cheap to check and are often owned by nobody in particular, which makes the annual audit a sensible place to catch them.

Is CheckFlow free for this template?

14-day free trial, no card required. The Business plan is $10 per user per month after the trial. Full details at checkflow.io/pricing.
