Scope Change Request Checklist Template

Scope rarely grows in one big decision. It grows through small yeses in meetings and emails, each reasonable on its own, until the budget and the deadline no longer match the work.

A change request is a small project decision with a big paper trail: what was asked, whether it is really new work, what it costs, who agreed and what changed as a result. This free scope change request checklist takes one request from the moment someone asks to the point where the plan, budget and invoice reflect it. It is written for project managers, agency account and delivery leads, consultancies and internal PMOs. One question at the start shows the client change order phase for work done for an external client, and a threshold question during the decision shows the sponsor or change board review only when the change is bigger than the project manager is allowed to approve alone.

Use This Template Free See Live Example
No Credit Card Required

Last reviewed: October 2026

Scope Change, Scope Creep and IT Change Management

The same request can become either a scope change or scope creep. The difference is what happens next. PMI’s PMBOK® Guide defines scope creep as “the uncontrolled expansion to product or project scope without adjustments to time, cost, and resources.” A scope change is the controlled version: the extra work is described, its impact is assessed, someone with the authority to do so agrees it, and the schedule, budget and contract move with it.

PMI calls that discipline integrated change control: reviewing every change request, approving or rejecting it, managing the changes to deliverables, plans and project documents, and communicating the decision. On larger projects a change control board, a formally chartered group, reviews and approves, defers or rejects the bigger changes. On a small agency project the “board” may be the account lead and the client’s marketing director on a call. The steps are the same either way.

Neither of these is IT change management, even though the vocabulary overlaps. IT change management controls changes to live systems, such as a server patch or a firewall rule, through requests for change and a change advisory board. If that is the process you need, use the IT Change Management Process Checklist instead, and see CheckFlow for change management.

Scope change

Asked, assessed, agreed

  • Logged with a reference number
  • Checked against the SOW or charter
  • Impact on time, cost and risk assessed
  • Approved at the right level
  • Plan, budget and contract updated
Scope creep

Asked, done, discovered later

  • Agreed in a meeting or by email
  • Started before anyone costed it
  • No change to dates or budget
  • Found at month-end as an overrun
  • Hard to bill, harder to explain
IT change management

A change to a live system

  • Request for change, not a scope change
  • Risk to service, not to project scope
  • Change advisory board and change calendar
  • Back-out plan and post-implementation review
  • Usually runs alongside projects

What the Scope Change Request Checklist Covers

Seven phases run from logging the request to invoicing the change. Phase 5 appears only when the change exceeds the project manager’s approval threshold, and Phase 6 appears only when the work is for an external client.

Capture

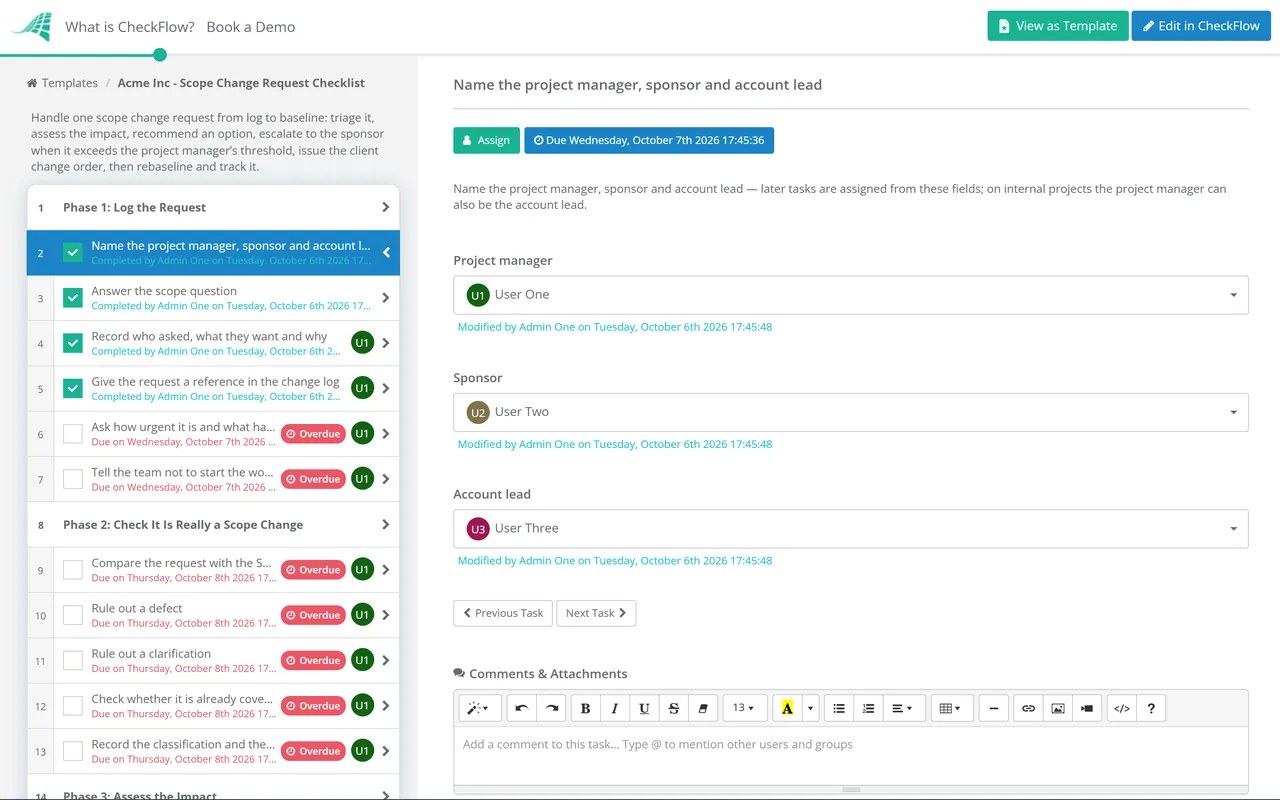

Phase 1: Log the Request

Answer the scope question first. It decides whether the client change order phase appears.

  • Name the project manager, sponsor and account lead — later tasks are assigned from these fields; on internal projects the project manager can also be the account lead
  • Answer the scope question — is this work for an external client
  • Record who asked, what they want and why — in the requester’s words, with the date, where it was asked and any deadline they gave
  • Give the request a reference in the change log — one number used in every email, estimate, task and invoice line about it
  • Ask how urgent it is and what happens if it waits — a deadline with a consequence is urgent; one without is a preference
  • Tell the team not to start the work yet — nothing gets built on a verbal yes before the decision
Triage

Phase 2: Check It Is Really a Scope Change

If the request is not a scope change, record why, tell the requester and close the checklist here.

  • Compare the request with the SOW, charter or backlog — quote the requirement, deliverable or acceptance criterion it would change
  • Rule out a defect — work that fails an agreed requirement is fixed under the original scope, not charged as a change
  • Rule out a clarification — an answer to an ambiguous requirement that adds no work needs a decision note, not a change
  • Check whether it is already covered — by contingency, an allowance, a time and materials budget or an assumption in the estimate
  • Record the classification and the reason — scope change, defect, clarification or already in scope, and tell the requester which
Impact

Phase 3: Assess the Impact

  • Define the change precisely — what is added, removed or altered, and what is explicitly not included
  • Estimate effort and schedule impact with the people doing the work — including the effect on milestones and the critical path
  • Cost the change — labour, third-party costs and licences, and how much contingency it would use
  • Assess the effect on resources, risk and quality — who is pulled off what, new risks, and any acceptance criteria or tests that change
  • Check dependencies outside the project — other teams, suppliers, contracts or later phases the change touches
Options

Phase 4: Options & Recommendation

The threshold question here decides whether Phase 5 appears.

  • Set out the options — accept, defer to a later phase or release, reject, or accept with a trade-off
  • Look for a trade-off before adding time or money — something that could come out of scope, or a date that could move, to absorb the change
  • Write a one-page recommendation — the request, the impact, the options and the one you recommend, with reasons
  • Check the change against the approval thresholds — answer whether it exceeds the project manager’s delegated authority on cost, time or scope
  • Record your decision if it is within your authority — and attach the recommendation it was based on
Escalate

Phase 5: Sponsor or Change Board Review

Shown only when the change exceeds the project manager’s approval threshold.

  • Send the recommendation to the sponsor or change board — with the impact assessment attached, before the meeting, not at it
  • Present the change and record the questions asked — with any condition the decision depends on, such as a launch date holding
  • Confirm the decision against the board’s terms of reference — very large changes may need the steering group or a revised business case
  • Sponsor approval of the change decision — the checklist stops here until the sponsor approves the recommended decision
Client

Phase 6: Client Change Order

Shown only when the scope answer is that the work is for an external client.

  • Price the change under the contract’s change terms — rate card, fixed fee or time and materials, as the contract sets out
  • Draft the change order or contract variation — scope, price, schedule effect, assumptions and which clauses or SOW sections it amends
  • Account lead approval of the change order — price, margin and terms checked before anything goes to the client
  • Send the change order and agree a response date — and explain what happens to the schedule if the answer is late
  • File the client’s signed change order — work starts when it is back, unless the contract allows otherwise
Baseline

Phase 7: Update the Baseline & Track

  • Record the final decision in the change log — accepted, deferred, rejected or traded off, who decided and on what date
  • Update the plan, budget and backlog — rebaseline dates and cost; deferred items go into the later phase’s backlog
  • Update the RAID log and the requirements — new risks, assumptions, issues, dependencies and acceptance criteria
  • Tell the requester, the team and stakeholders — what changed, what did not, and any new dates
  • Track the work under the change reference — tag tasks and time so actual effort can be compared with the estimate
  • Invoice the change or record it against the budget — as the change order says, and note any variance for the next estimate

Who Approves What: an Example Threshold Matrix

Most slow or contested change decisions come from one missing agreement: who is allowed to approve what. Set the thresholds when the project starts, in the charter, the project initiation document or the contract, so nobody negotiates authority in the middle of a disagreement about scope. The figures below are examples only. Set your own to match your budgets, your contingency and the way your organisation delegates authority.

Impact of the changeProject manager decidesSponsor decidesChange board or steering group decides
CostExample: covered by remaining contingency and under 2% of budgetExample: 2% to 10% of budget, or needs new moneyExample: over 10% of budget, or changes the business case
ScheduleNo change to any external milestoneMoves an external milestone by up to two weeksMoves the go-live or contract completion date
ScopeSwaps like-for-like items inside a deliverableAdds or removes a deliverableChanges the project’s objectives or benefits
Risk and qualityNo new high-rated risk; acceptance criteria unchangedAdds a high-rated risk or changes acceptance criteriaAffects safety, regulatory compliance or another project
Contract (client work)No change to price or termsChange order within the account lead’s pricing authorityChanges contract terms, liability or the overall fee

Use the highest level any row reaches. A change that costs little but moves the go-live date goes to the board. Count changes cumulatively as well: five small changes that each stay under the project manager’s limit can add up to one the sponsor should have seen, so review the running total in the change log at every steering or status meeting.

Keep the assessment proportionate. A two-hour copy change needs a line in the change log and an email confirming the cost. A new integration needs the full impact assessment. The checklist is the same; the depth of each answer is not.

Why Run Scope Change Requests in CheckFlow?

1

Nothing starts on a verbal yes

The decision is an approval step that holds the checklist until the sponsor or account lead answers, so the plan, the change order and the invoice only move once someone with authority has agreed. The approval is recorded beside the assessment it was based on.

2

Escalation only when it is needed

Conditional logic shows the change board review only for changes above the threshold, and the change order steps only for client work. Small changes stay quick, and big ones cannot skip the review.

3

A change log you do not have to maintain

Every request is its own checklist with comments, attachments and a full history. Reports show open requests and how long each took to decide, and you can start a request from a form or ticket through the API.

Agree the change process and the thresholds before the work starts, in the Project Kickoff Checklist, and keep the change log with the rest of the project record using the Project Management Documentation Checklist. A change big enough to alter the benefits needs the Business Case Checklist run again, and the Project Closeout Checklist reconciles every approved change before the project closes.

Running change requests across several projects or clients? CheckFlow for approvals routes each decision to the right person, and CheckFlow for change management covers the IT side when a project change also touches live systems.

Frequently Asked Questions

What is a scope change request?

+

A scope change request is a formal record that someone wants the project to deliver something different from what was agreed: more, less or something else. It names who asked, what they want and why, and it starts the process of assessing the impact and deciding. Logging it is not agreeing to it. The request only becomes part of the project once someone with the authority to do so approves it and the plan, budget and, for client work, the contract are updated.

What is the difference between scope creep and a scope change?

+

Scope creep is uncontrolled; a scope change is controlled. PMI defines scope creep as the uncontrolled expansion of product or project scope without adjustments to time, cost and resources. The extra work itself can be identical. If it is logged, costed, approved and reflected in the schedule and budget, it is a scope change. If it is agreed in a meeting and simply absorbed, it is creep, and it usually surfaces later as an overrun nobody can explain.

Who should approve a scope change?

+

Whoever the project’s agreed thresholds say, based on the size of the impact. Small changes covered by contingency are usually the project manager’s call, larger ones go to the sponsor, and changes that move the go-live date or alter the business case go to a change control board or steering group. For client work the client must also agree, normally by signing a change order. Set the thresholds at the start of the project, not during the first disagreement.

What should a change request form include?

+

Enough for someone else to make the decision without a meeting: a reference number, the requester, the date, a description of the change and the reason for it, how urgent it is, the requirement or SOW section it affects, the estimated effect on effort, schedule, cost, resources, risk and quality, the options considered, a recommendation, the decision with the decision-maker’s name and date, and, for client work, the price and the signed change order.

How do you stop small changes from adding up?

+

Log every one of them, however small, and review the running total. A change that takes an hour is easy to agree informally, but ten of them are more than a week of work nobody budgeted for. Keeping a cumulative total in the change log, and setting a threshold for the total as well as for each change, lets the project manager say yes to small requests quickly while the sponsor still sees the pattern.

Is CheckFlow free for this template?

+

14-day free trial, no card required. The Business plan is $10 per user per month after the trial. Full details at checkflow.io/pricing.
