Joint Commission Survey Readiness Checklist Template

A hospital survey arrives unannounced, in a window you can predict but on a morning you cannot. Readiness that starts when surveyors sign in at reception has started too late.

Most hospitals know roughly when their next full survey is due. What goes wrong is the gap between surveys: owners change, the manual changes and last cycle’s corrective actions quietly lapse. This free Joint Commission survey readiness checklist gives accreditation, quality and regulatory managers and chief nursing officers one workflow for the whole cycle: setting up ownership against the 2026 manual and National Performance Goals, mock tracers on a steady rhythm, a survey-week plan from the surveyor’s arrival to the exit conference, and the Evidence of Standards Compliance (ESC) that follows. Two questions at the start show an application phase for a first survey and a Medicare follow-up task for hospitals that use accreditation for deemed status.

Use This Template Free See Live Example
No Credit Card Required

Last reviewed: October 2026

What the Survey Tests, and What Changed in 2026

Hospital surveys are unannounced. The Joint Commission says to expect the next full survey 30 to 36 months after the previous one, and surveyors arrive no earlier than 7:45 a.m. on the first day. An accreditation decision lasts about three years. A Life Safety Code surveyor is part of every hospital survey. Most of the clinical survey time goes on tracers: surveyors follow individual patients through the care they received, reading the record, watching care and talking to the staff involved. Since May 2024 infection prevention and medication management have been assessed within those individual tracers rather than in a separate meeting, and the old data session is now the Organization Quality and Performance Improvement (OQPI) session. Staff on every unit have to show and explain what they do; polished binders do not help.

From 1 January 2026, under its Accreditation 360 programme, Joint Commission rewrote the hospital and critical access hospital manuals. It removed 714 hospital requirements. The National Patient Safety Goals chapter was replaced by 14 National Performance Goals, which gather requirements that go beyond the Medicare Conditions of Participation, and staffing is now one of those goals. Environment of Care and Life Safety were merged into one Physical Environment chapter. A Survey Process Guide replaced the Survey Activity Guide, and surveyors now record strengths as well as findings in a SAFEST report. Joint Commission says no new concepts were introduced. Even so, any readiness binder or policy cross-reference built before 2026 points at standards that have moved.

This checklist covers readiness and closing findings. Events between surveys belong in the Healthcare Incident Reporting Checklist, file-level credentialing in the Healthcare Staff Credentialing Checklist, and privacy and security in the HIPAA Compliance Audit Checklist. Readiness itself has two halves.

Between surveys

Keep the hospital survey-ready

  • An owner for every chapter and every National Performance Goal
  • Mock tracers on a fixed rhythm, with findings logged and re-checked
  • Last cycle’s high-risk findings still corrected and still evidenced
  • The E-App kept in step with the services you actually provide
Survey and after

Run the week, then close the findings

  • An arrival procedure that works on any weekday morning
  • Escorts, scribes and a debrief after each daily briefing
  • Every finding plotted on the SAFER Matrix and given an owner
  • An ESC with completion dates, signed off and submitted within 60 days

What the Joint Commission Survey Readiness Checklist Covers

Seven phases run from setting up the cycle to feeding lessons into the next one. Phase 2 appears only for a first survey, and the Medicare follow-up task in Phase 6 appears only when the hospital uses accreditation for deemed status.

Setup

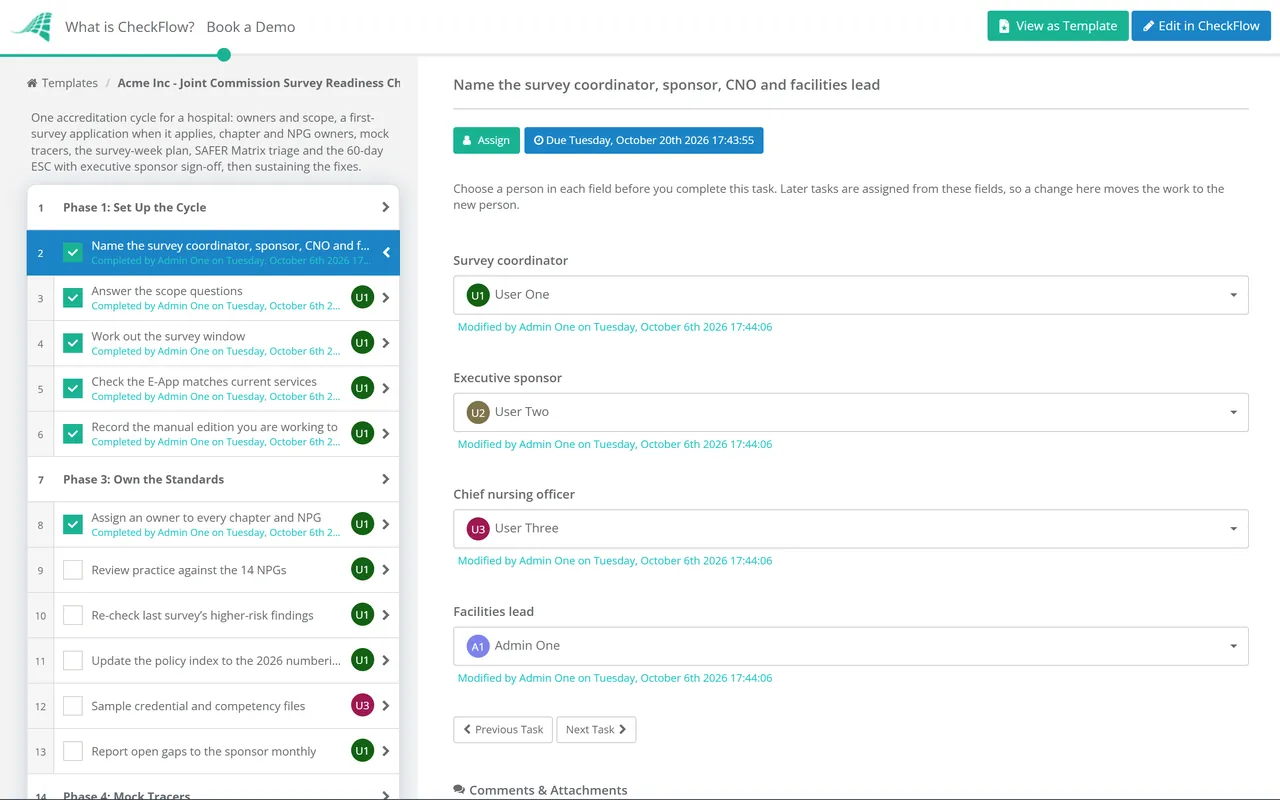

Phase 1: Set Up the Cycle

Answer the two scope questions first. They decide whether the application phase and the Medicare follow-up task appear.

  • Name the survey coordinator, sponsor, CNO and facilities lead — later tasks are assigned from these four fields
  • Answer the scope questions — is this the hospital’s first Joint Commission survey, and is accreditation used for Medicare deemed status
  • Work out the survey window — from the last full survey date, so mock tracers and fixes are finished before it opens
  • Check the E-App matches current services — sites, services and volumes drive the survey length and the team sent
  • Record the manual edition you are working to — the January 2026 rewrite and any later E-dition updates, so owners read the same text
Initial

Phase 2: First Survey Application

Shown only when this is the hospital’s first Joint Commission survey.

  • Confirm you meet the eligibility requirements — including enough inpatients and open and closed records for surveyors to assess compliance
  • Submit the application for accreditation — with a description of services and volumes that is accurate on the day you send it
  • Agree the survey type and timing — with your Joint Commission contact, noting that deemed status surveys are unannounced
  • Run a full gap analysis against every chapter — there is no previous report to start from, so nothing can be skipped
Standards

Phase 3: Own the Standards

  • Assign an owner to every chapter and NPG — one named person per chapter and per National Performance Goal, with a deputy
  • Review practice against the 14 NPGs — each owner records gaps against current practice, not against last cycle’s binder
  • Re-check last survey’s higher-risk findings — surveyors may review them again, up to and including the next full survey
  • Update the policy index to the 2026 numbering — replace references to retired chapters such as Environment of Care and Life Safety
  • Sample credential and competency files — medical staff privileges and nursing competencies, against your bylaws and policy
  • Report open gaps to the sponsor monthly — owner, standard, risk and target date for each one
Tracers

Phase 4: Mock Tracers

  • Set the mock tracer schedule for the cycle — covering every inpatient unit and high-risk outpatient area at least once
  • Trace individual patients through their care — follow the record, observe care and ask staff to explain what they do and why
  • Cover infection control and medication management in tracers — surveyors assess both inside individual tracers, not in a meeting
  • Rehearse the OQPI session with real data — how you choose measures, what the data shows and what you changed
  • Walk the building with the facilities lead — against the Physical Environment chapter and Life Safety Code requirements
  • Log each finding with an owner and date — then re-trace the same area to confirm the fix has held
Survey week

Phase 5: Survey-Week Plan

  • Write the surveyor arrival procedure — who reception calls, who verifies identity and who opens the command room
  • Assign escorts and scribes for each surveyor — with cover for night, weekend and leave
  • Prepare the documents the Survey Process Guide lists — indexed and ready for the opening conference
  • Brief unit staff on tracer conversations — answer from their own practice and show where they would look things up
  • Debrief after each daily briefing — record observations, assign follow-up and tell units what is coming
  • Record findings and strengths at the exit conference — preliminary findings, their SAFER placement and any SAFEST strengths
ESC

Phase 6: Evidence of Standards Compliance

The executive sponsor sign-off halts the checklist. Nothing is submitted until it is given. The Medicare task appears only for deemed status.

  • Decide whether to request clarifications — within 10 business days of the report posting; ESC due dates do not move
  • Triage every RFI on the SAFER Matrix — by likelihood to harm and scope, so the highest-risk findings are fixed first
  • Write corrective actions with completion dates — what changed, when it was complete and how ongoing compliance is measured
  • Add leadership involvement and preventive analysis — required for higher-risk findings; name the leader and the underlying cause
  • Prepare for a Medicare deficiency follow-up survey — if the report scores any finding at Condition level
  • Executive sponsor sign-off of the ESC submission — the sponsor approves every corrective action and date before it is sent
  • Submit the ESC within 60 days — counted from when the Accreditation Survey Findings Report is posted
Sustain

Phase 7: Sustain and Restart

  • Audit each corrective action until it holds — on the schedule written into the ESC, with results attached
  • Prepare for a follow-up survey if required — an Accreditation with Follow-up Survey decision means a visit within six months
  • Share the SAFEST strengths and lessons — with unit leaders, the governing body and the medical staff
  • Start the next cycle’s checklist — carry open risks and new owners forward rather than starting from a blank page

The Hospital Survey Cycle at a Glance

The dates below are for the hospital accreditation programme as Joint Commission describes it in October 2026. Count forward from the last full survey, and leave slack at both ends of the window, because a survey can come on any day inside it.

Month 0

Last full survey and decision

Accreditation runs for about three years from the last day of the survey. Open this cycle’s checklist as soon as the previous ESC is accepted.

Months 1 to 29

Standards ownership and mock tracers

Chapter and NPG owners close gaps, mock tracers run on their schedule, and higher-risk findings from the last survey are re-audited.

Months 30 to 36

Survey window

The unannounced full survey can arrive on any weekday morning. The arrival procedure, escorts and document index should be ready before month 30.

Survey days

Opening conference to exit conference

Tracers, the OQPI session, the Life Safety Code building review, daily briefings and an exit conference with preliminary findings.

+10 business days

Clarification deadline

Ten business days from when the final report is posted, if you have evidence that you were compliant at the time of survey.

+60 days

ESC due

Every Requirement for Improvement is addressed in the Evidence of Standards Compliance, with extra detail for higher-risk findings.

Within 6 months

Follow-up survey, if required

Only after an Accreditation with Follow-up Survey decision, to confirm the fixes have held.

Other programmes run on different clocks. Joint Commission accredits laboratories on a two-year cycle. Hospitals and critical access hospitals were the first programmes moved to Accreditation 360 in 2026. If you run another programme, take its timing from that programme’s own survey guide rather than from this page.
