5S Audit Checklist Template

Painting floor lines takes a weekend. Keeping them meaningful takes an audit that comes round every month, scores the same things the same way and makes someone fix what it finds.

Printed from checkflow.io/templates/quality-assurance/five-s-audit-checklist

This free 5S audit checklist scores one work area against Sort, Set in Order, Shine, Standardise and Sustain, the English names for seiri, seiton, seiso, seiketsu and shitsuke. The auditor walks the area as it normally is, red-tags what does not belong, photographs the worst examples, scores each S from 0 to 4 and turns every finding into an action with an owner. The area owner signs off the action plan, and the score is compared with the last three audits so you can see whether the area is improving or slipping. Add Safety as a sixth S with one answer.

Three Kinds of 5S Audit, One Scorecard

5S comes from Japanese manufacturing and is closely associated with the Toyota Production System. The Lean Enterprise Institute notes that Toyota itself traditionally speaks of four Ss, with the discipline of sustaining built into its audits. The five-step version reached most Western plants through Hiroyuki Hirano’s book, translated from Japanese and published in English by Productivity Press in 1995 as 5 Pillars of the Visual Workplace. Takashi Osada’s The 5S’s is the other framework you will meet.

Whichever framing you use, the audit is what keeps 5S alive. Most sites run three kinds, and the checklist records which one this is so that scores are compared like for like.

Self-audit

The area team scores itself

Good for: frequent checks, ownership and catching drift between formal audits.

Watch for: scores that creep up because the team stops seeing its own clutter.

Typical rhythm: weekly or after each changeover.

Cross-area

Another team’s auditor scores it

Good for: fresh eyes, consistent scoring across the site and sharing good ideas between areas.

Watch for: auditors trading soft scores. Rotate the pairs.

Typical rhythm: monthly.

Management walk

A manager scores it on the floor

Good for: showing 5S matters, and clearing blockers the area cannot fix alone.

Watch for: a special clean the day before. Walk the area as it normally runs.

Typical rhythm: quarterly.

The rhythms are common practice, not a rule. What matters is that the same area is scored against the same scale on a fixed cadence, and that each audit checks whether the last one’s actions were done.

What the 5S Audit Checklist Covers

Seven phases take one area from planning to a signed-off action plan. Each S is checked and scored in its own phase, Standardise and Sustain share one, and the Safety phase appears only when you choose to run a 6S audit. The area owner approves the action plan before the audit closes.

  1. Plan

    Phase 1: Plan the Audit

    5 tasks

    Owned by the auditor. Scope questions: include Safety as a sixth S (Yes/No), audit type (Self-audit / Cross-area / Management walk). The audit type is recorded with the score for trending.

    • Name the auditor, area owner and 5S lead — later tasks are assigned from these three fields
    • Answer the scope questions — whether Safety is scored as a sixth S, and which kind of audit this is
    • Open the area’s 5S standard and last audit — the area map, the standard photos, the last score and its open actions
    • Walk the area as it normally runs — no warning and no pre-audit tidy; the audit measures the everyday state
    • Check last audit’s actions on the floor — each one done, part done or not done, seen in the area rather than taken on trust
  2. Sort

    Phase 2: Sort (Seiri)

    5 tasks

    Assigned to the auditor. Score 0 to 4 against the scale below, with a photo of the worst example.

    • Look for items not needed in the area — tools, parts, materials, paperwork and personal items not used for this area’s work
    • Check hidden spots — under benches, on top of cabinets, in drawers and behind machines
    • Red-tag anything doubtful — tag with the date, the finder and the reason, and move it to the red-tag holding area
    • Check the red-tag holding area — items past their holding period disposed of, returned or relocated, with each decision recorded
    • Score Sort from 0 to 4 — with a photo of the worst example and a note of what would lift the score
  3. Set

    Phase 3: Set in Order (Seiton)

    5 tasks

    Assigned to the auditor. A good test: ask someone to fetch a named tool and time it.

    • Check every item has a marked home — shadow boards, labelled shelves, outlined floor locations and named bins
    • Check items are in their homes — count the empty outlines on shadow boards and anything sitting outside a marked place
    • Check placement follows frequency of use — daily items at the point of use, rarely used items further away
    • Check floor markings and aisles — lines intact, walkways clear, nothing parked in a marked aisle
    • Score Set in Order from 0 to 4 — with a photo, and the time the fetch test took
  4. Shine

    Phase 4: Shine (Seiso)

    5 tasks

    Assigned to the auditor. Shine is cleaning as inspection: an abnormality found while cleaning is a finding.

    • Check floors, machines and benches are clean — including the inside of guards and the base of machines
    • Look for sources of dirt — oil leaks, swarf, dust and overspray, recorded as causes to remove, not just mess to wipe
    • Note abnormalities found while cleaning — loose fixings, worn belts, damaged hoses and leaks, passed to maintenance
    • Check the cleaning schedule is being followed — the area’s daily and weekly cleaning record is up to date and signed
    • Score Shine from 0 to 4 — with a photo of the worst example
  5. Sustain

    Phase 5: Standardise & Sustain (Seiketsu, Shitsuke)

    6 tasks

    Assigned to the auditor. These two Ss are about whether the first three hold without an audit.

    • Check the area standard is posted — a photo of the standard condition, zone owners and the cleaning schedule, where the team can see it
    • Compare the area with its standard photo — note every difference, however small
    • Check each zone has a named owner — ask who looks after it, and whether the answer matches the board
    • Ask two people about their 5S routine — what they do at the end of a shift and where the standard is kept
    • Score Standardise from 0 to 4 — based on whether the standard exists, is visible and is current
    • Score Sustain from 0 to 4 — based on the routines, the trend and whether last audit’s actions were closed on time
  6. Safety

    Phase 6: Safety (6S)

    6 tasks

    Shown only when “Include Safety as a sixth S?” is Yes. Assigned to the auditor. It looks at the workplace order that keeps people safe, not the full safety inspection.

    • Check emergency equipment is clear and marked — extinguishers, eyewash, first aid kits and emergency stops reachable and unobstructed
    • Check exits and walkways — fire exits clear, walkways free of trip hazards, cables and hoses routed safely
    • Check chemicals are labelled and stored — in marked locations, with only what the shift needs at the point of use
    • Check PPE is available where it is needed — stocked, in its marked place and in usable condition
    • Check lockout points are clear and labelled — isolators and valves reachable and identified, ready for the Lockout/Tagout (LOTO) Procedure Checklist
    • Score Safety from 0 to 4 — with a photo, and urgent hazards raised straight away rather than waiting for the report
  7. Follow-up

    Phase 7: Score, Actions & Follow-up

    6 tasks

    The action plan approval is assigned from the area owner field, and the checklist halts until it is Approved. The approval is due 7 days after the audit start date.

    • Total the score and compare it with the last three audits — as a percentage, so 5S and 6S audits can sit on the same chart
    • Raise an action for every finding — what, where, an owner from the area team and a target date
    • Area owner approval of the action plan — confirms each action is realistic and resourced before the audit closes
    • Share the result with the area team — post the score, the trend and the top three actions on the area board
    • Flag anything the area cannot fix alone — to the 5S lead, such as a missing storage rack or a repeat leak
    • Confirm the date of the next audit — set by the recurring schedule, with the actions checked first

A 0 to 4 Scoring Scale for Each S

A score only means something if two auditors would give the same number. The scale below describes what each level looks like so scoring does not depend on mood. There is no official 5S scale; adapt the wording to your areas, then keep it fixed so the trend stays honest.

ScoreLevelWhat the auditor seesExample for Set in Order
0Not startedNo standard and no visible effortTools kept wherever the last person left them
1StartedSome effort, many gaps; problems obvious at a glanceA shadow board exists but half the outlines are empty or wrong
2Partly in placeThe basics are there, but only some people follow themMost tools have homes; a few always end up on the bench
3In placeStandard met throughout, with minor lapsesEvery tool has a labelled home and almost all are in it
4SustainedStandard met, owned by the team and improved by themThe team redesigned the board after a changeover and nobody had to ask

Five Ss at 0 to 4 give a maximum of 20, or 24 with Safety. Report the result as a percentage and keep each S as its own line on the chart, because the total hides the pattern. A common one is Shine holding steady while Sustain falls: the area is cleaned before audits, but nobody is doing it in between. Another is a jump in score after a new auditor joins, which is a calibration problem rather than an improvement. That is why the audit type is recorded: compare self-audits with self-audits, and use cross-area scores to check that the self-audits are honest.

The checks in each phase are written for a production cell. Rewrite them for the area you audit. In a warehouse, Set in Order is about labelled locations and clear pick faces; in a laboratory, Shine includes the state of benches and fume cupboards; in an office or a shared drive, Sort is about old files and duplicate folders. Keep the five headings and the 0 to 4 scale the same everywhere, so a site-wide chart compares like with like.

Why Run 5S Audits in CheckFlow?

1

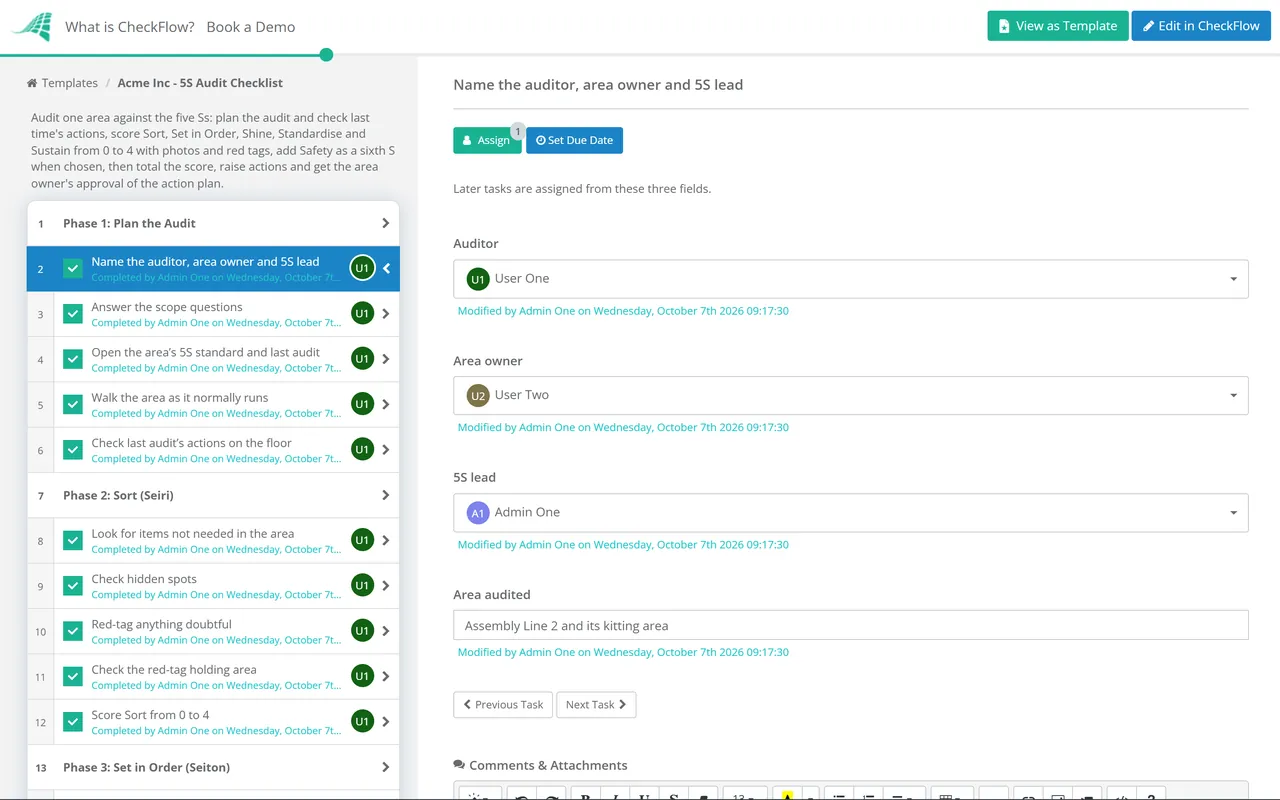

Audits that start themselves

A recurring schedule creates each area’s audit on time and assigns it to the right auditor, so 5S does not fade the month somebody is on holiday. Each audit carries a due date, so nobody has to remember it.

2

Photos on the finding

Each score carries its photo and comments on the task that produced it, so the area owner sees exactly which bench or shelf the auditor meant. Every audit starts by checking the last one’s actions on the floor.

3

Actions someone owns

The area owner’s approval halts the checklist until the action plan is agreed, and the audit trail shows who scored what and when, audit after audit.

CheckFlow is not an MES or a CMMS. It runs the human routines around them: audits, changeovers, maintenance checks and the actions they raise. CheckFlow’s manufacturing checklist software shows how plants schedule those routines, and the guide to lean manufacturing principles explains where 5S sits among the other lean tools and why the audit, not the painted lines, is what lasts.

5S keeps a workplace in order; it does not write the procedures or run the improvement cycle. Use the Process Standardization Checklist to write the standard work an area follows, and the Continuous Improvement Cycle Process for a PDCA project. When the same leak or mess comes back audit after audit, find the cause with the Root Cause Analysis (8D) Checklist.

AI generator

Didn’t find what you need? Describe it.

Describe the process in a sentence and the AI checklist generator drafts the phases and tasks for you.

Frequently Asked Questions

What should a 5S audit checklist include?

A check of last audit’s actions, then specific, observable checks for each S: unneeded items and red tags for Sort, marked homes and clear aisles for Set in Order, cleanliness and sources of dirt for Shine, a posted standard and named owners for Standardise, and daily routines for Sustain. Each S needs a score against a defined scale, photos of the worst examples, and actions with owners and dates.

What do the five Japanese 5S words mean?

Seiri means separating what is needed from what is not and removing the rest. Seiton is arranging what is left so everything has a place. Seiso is cleaning. Seiketsu is the standardised condition that comes from doing the first three regularly, and shitsuke is the discipline to keep doing them. Sort, Set in Order, Shine, Standardise and Sustain are the usual English names, though some sites say Straighten for seiton.

How often should a 5S audit be done?

There is no standard frequency. Many sites have the area team self-audit weekly, run a cross-area audit monthly and add a management walk each quarter. Pick a cadence you can keep, because a monthly audit that happens every month beats a weekly one that is skipped half the time.

What is the difference between 5S and 6S?

6S adds Safety to the five Ss: emergency equipment reachable, exits and walkways clear, chemicals labelled and PPE in place. It is a local extension, not a separate method. It checks the order that keeps people safe, but it does not replace a full safety inspection or your risk assessments.

What is a red tag in 5S?

A label put on any item whose need is in doubt during Sort. It records the date, who tagged it and why, and the item moves to a holding area for a set period. If nobody claims it with a reason, it is disposed of, returned to stores or moved to where it is used. The holding area needs checking too, or it becomes the new clutter.

Why do 5S programmes fade?

Usually because the effort stops at Shine and 5S becomes housekeeping. Audits slip, findings have no owner, and the team learns that nothing happens if the area slides. A fixed schedule, actions with names and dates, and a visible score trend are what keep it going.

Is CheckFlow free for this template?

14-day free trial, no card required. The Business plan is $10 per user per month after the trial. Full details at checkflow.io/pricing.
