Continuous Improvement Cycle Process Checklist Template

The organisation that improves incrementally and consistently over three years outperforms the one that pursues transformation once and never sustains it. Continuous improvement is not a project — it is a discipline.

Printed from checkflow.io/templates/quality-assurance/continuous-improvement-cycle-checklist

The concept of continuous improvement — expressed as Kaizen in Japanese manufacturing philosophy, as the PDCA cycle in quality management, and as the foundation of ISO 9001 — rests on a simple but powerful insight: improvement should not wait for a crisis or a transformation programme. It should happen constantly, at every level of the organisation, driven by the people closest to the work. Nike doubled in size between 2015 and 2021, from $100 billion to over $200 billion, with PDCA-based quality management among the operational disciplines that supported this growth. The Mayo Clinic and Nestlé have both documented significant efficiency improvements through systematic continuous improvement programmes. The discipline behind these outcomes is not complexity — it is consistency. A structured improvement cycle that starts with a well-defined problem, tests solutions before committing to them, measures results honestly, and standardises what works before beginning the next cycle. This free checklist gives quality managers, operations leaders, and improvement teams a structured framework for the full continuous improvement cycle.

PDCA and DMAIC — Two Frameworks for the Same Goal

PDCA — Plan-Do-Check-Act

PDCA (Plan-Do-Check-Act)

  • Developed by: Dr. W. Edwards Deming; adopted globally as the continuous improvement backbone of ISO 9001
  • Best for: Incremental improvements, process simplification, everyday Kaizen, and organisations starting their improvement journey
  • Cycle speed: Fast — can run in days to weeks for small-scope improvements
  • Rigour: Structured but accessible; does not require statistical expertise
  • Used by: Teams at all levels; quality management systems; healthcare (Plan-Do-Study-Act); manufacturing; service organisations
DMAIC — Define-Measure-Analyse-Improve-Control

DMAIC (Define-Measure-Analyse-Improve-Control)

  • Developed by: Motorola; refined through GE’s Six Sigma programme
  • Best for: Complex problems with high variability, statistically significant defect reduction, and large-scale process redesign
  • Cycle speed: Weeks to months — requires data collection and statistical analysis
  • Rigour: High — typically requires trained Six Sigma practitioners (Green Belt, Black Belt)
  • Used by: Large manufacturers, healthcare systems, financial services firms with significant process complexity

For most organisations running improvement cycles at the process and team level, PDCA is the right tool. DMAIC adds statistical rigour for high-complexity, high-stakes improvement projects. Both are better than no systematic approach.

The Continuous Improvement Cycle Checklist

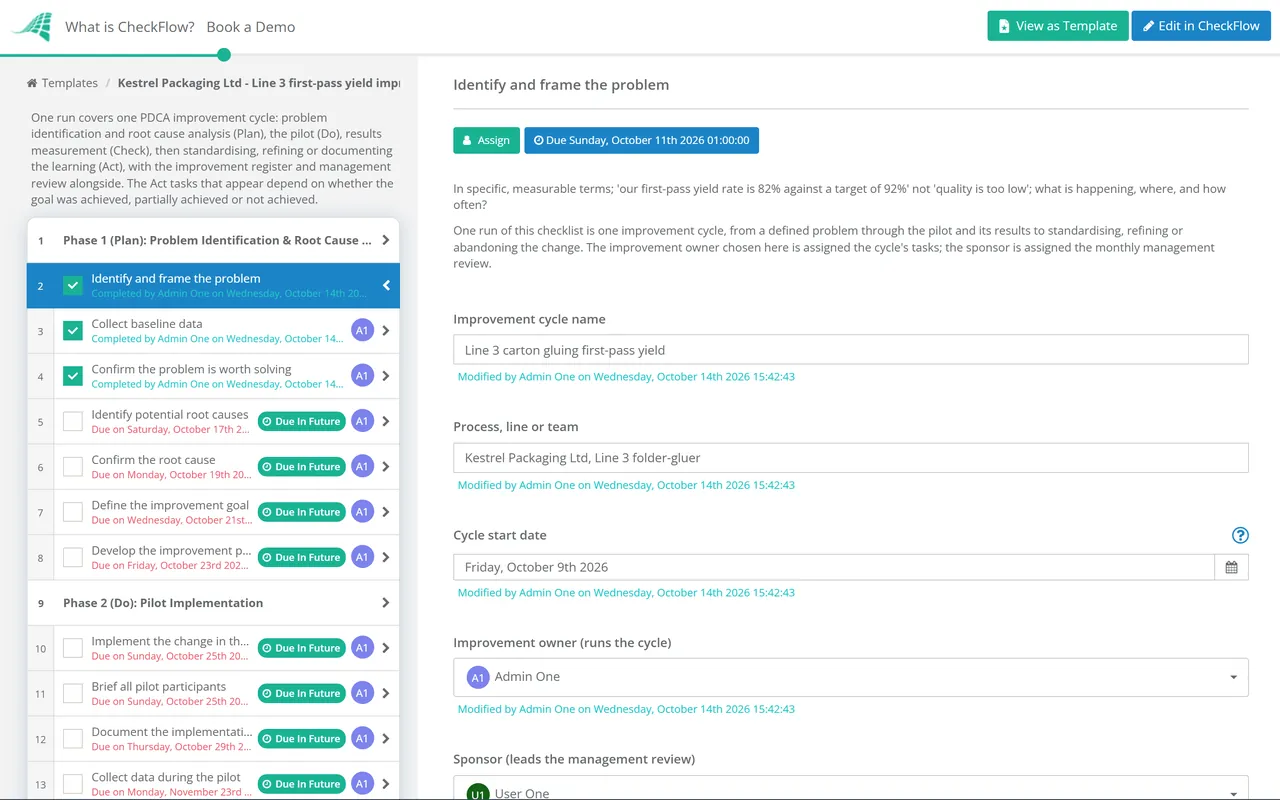

Five phases covering the full PDCA improvement cycle — from problem identification and root cause analysis through pilot implementation, results measurement, standardisation, and programme governance.

  1. Phase 1 — Plan

    Phase 1 (Plan): Problem Identification & Root Cause Analysis

    7 tasks

    The most common continuous improvement failure is starting with a solution rather than a problem. A solution is a guess about the root cause of a problem. A solution implemented without confirmed root cause will address a symptom and leave the underlying cause untouched.

    • Identify and frame the problem — in specific, measurable terms; “our first-pass yield rate is 82% against a target of 92%” not “quality is too low”; what is happening, where, and how often?
    • Collect baseline data — quantifying the current state; the measurement that will be used to assess improvement after the change is made; established now, before any change
    • Confirm the problem is worth solving — what is the cost of not fixing it? Revenue impact, quality impact, customer impact, safety impact? Prioritise against other improvement opportunities
    • Identify potential root causes — using structured tools: 5 Whys (ask “why?” five times to trace from symptom to root cause), Fishbone/Ishikawa diagram (mapping causes across 6M categories: Man, Machine, Method, Material, Measurement, Mother Nature), or Pareto analysis (identifying the 20% of causes producing 80% of the problem)
    • Confirm the root cause — with data; a suspected root cause that cannot be evidenced is a hypothesis; test it before building a solution on it
    • Define the improvement goal — specific, measurable, and time-bound; “increase first-pass yield from 82% to 92% within 3 months”
    • Develop the improvement plan — the specific change to be tested; the pilot scope; the measurement method; the responsible owner
  2. Phase 2 — Do

    Phase 2 (Do): Pilot Implementation

    4 tasks

    The PDCA “Do” phase is a controlled experiment, not a full deployment. The smallest scale that can produce meaningful data is the right scale for the pilot. Testing on one line before rolling out to all lines; one team before all teams; one site before all sites.

    • Implement the change in the pilot scope — as defined in the plan; do not expand scope during the pilot
    • Brief all pilot participants — what is changing, why, what is expected of them, and how results will be measured
    • Document the implementation — start date, scope, conditions, and any deviations from the plan that occurred during implementation
    • Collect data during the pilot — the same measurement as the baseline; consistently; over a period long enough to be statistically meaningful
  3. Phase 3 — Check

    Phase 3 (Check): Results Measurement & Analysis

    5 tasks
    • Compare pilot results to baseline — did the metric improve? By how much? Against the goal set in Phase 1
    • Assess whether the improvement was caused by the change — or by other factors; confirmation of causal relationship is essential before standardisation
    • Identify any unintended consequences — did the change cause any new problems? Reduce performance in any area not being measured?
    • Compare to the goal — was the goal achieved? Partially? Not at all?
    • Document the findings — results, analysis, and conclusions; the learning from this cycle is the input to the next
  4. Phase 4 — Act

    Phase 4 (Act): Standardise, Iterate, or Abandon

    6 tasks

    The Act phase has three possible outcomes. Each is equally valid. The improvement that did not work as expected is not a failure — it is data. The discipline is in acting on the data rather than on the original plan.

    • If successful: Standardise the change — update SOPs and work instructions to reflect the new standard; train all affected personnel; roll out from pilot scope to full scope
    • If successful: Establish the new baseline — the post-improvement metric becomes the new standard from which the next improvement cycle starts
    • If partially successful: Refine the approach — what needs to change? Re-enter the PDCA cycle at Plan with the refined hypothesis
    • If unsuccessful: Document the learning — what was learned? What does the data suggest? Restart at Plan with a different hypothesis
    • Communicate the outcome — to the team and any stakeholders; both successful and unsuccessful outcomes shared transparently; the culture of continuous improvement depends on psychological safety to report honest results
    • Launch the next improvement cycle — continuous improvement never stops; the completed cycle reveals the next opportunity
  5. Phase 5 — Governance

    Phase 5: Programme Governance & Management Review

    4 tasks
    • Maintain an improvement register — all active improvement cycles tracked; each with problem statement, goal, phase, owner, and target date
    • Prioritise the improvement backlog — against impact and effort; the highest-impact, lowest-effort improvements are addressed first
    • Monthly management review of improvement programme — cycles completed this month; impact achieved; active cycles and their status; any resource or systemic barriers
    • Celebrate and share successes — completed improvement cycles with meaningful results communicated to the wider organisation; the cultural signal that improvement is valued

The 5 Whys — the Simplest Root Cause Tool in Any Quality Toolkit

The 5 Whys technique, developed at Toyota as part of the Toyota Production System, is the most accessible root cause analysis tool in quality management. The method is simply to ask “why?” repeatedly — typically five times — until the root cause (not the symptom) is identified. A defective product returned by a customer is a symptom; the fact that the inspection step was skipped because the production schedule was overloaded is a root cause; and the fact that production schedule management has no buffer for quality holds is the systemic cause that, if addressed, prevents the whole chain of events.

Example: Customer returned a batch of products because of defects.

1
Why were defective products shipped? — The final inspection did not catch the defects.
2
Why did the final inspection miss the defects? — The inspector was using the wrong acceptance criteria for this product variant.
3
Why was the wrong acceptance criteria being used? — The inspection checklist was not updated when the product specification changed.
4
Why was the inspection checklist not updated? — There is no process to link product specification changes to inspection checklist updates.
5
Why is there no such process? — Change control does not include quality documents as affected documents.
Root cause: The change control process does not include quality inspection documents. Fixing this prevents every future occurrence of this class of problem.
