Calibration Management Checklist Template

A gauge found out of tolerance is not a calibration problem. It is a question about every part it measured since the last time it was right.

Printed from checkflow.io/templates/quality-assurance/calibration-management-checklist

This free calibration management checklist runs one instrument through one calibration cycle: checking it is due, pulling it from use, calibrating it in-house or at an accredited lab, reviewing the certificate, labelling it and putting it back. When the as-found result is out of tolerance, an impact assessment phase appears, and the quality manager must approve what happens to the product it measured. It suits manufacturers, test labs and food businesses that rely on gauges, balances, thermometers, pressure gauges and torque tools.

What the Standards Ask of Your Measuring Equipment

No standard tells you to calibrate every instrument once a year. They ask for something harder: that you know which measurements matter, that the equipment behind them is fit for the job, and that you can show it. Auditors test this by picking a product record, finding the gauge that accepted it and asking for that gauge’s calibration history. The standards most quality teams meet are summarised below; check the current text of the ones you are certified to.

Standard or ruleApplies toWhat it asks for
ISO 9001:2026, clause 7.1.5 (monitoring and measuring resources)Any certified quality management systemWhere traceability is required, calibrate or verify at specified intervals or before use against standards traceable to international or national standards, identify the calibration status, safeguard against adjustment and damage, and decide whether earlier results were affected when equipment is found unfit
ISO 10012:2026Organisations that want a formal measurement management systemRequirements for managing measurement processes and confirming measuring equipment is fit for use; the second edition replaced the 2003 version in February 2026
ISO/IEC 17025:2017Testing and calibration laboratoriesLaboratory competence, including what a calibration certificate must report; it is also the standard your external calibration lab is accredited to
ISO 13485:2016, clause 7.6Medical device makers, and US manufacturers under the FDA’s 21 CFR Part 820, which incorporates ISO 13485 by referenceControl of monitoring and measuring equipment, along the same lines as ISO 9001
21 CFR 117.165(a)(1)US food facilities with a food safety planCalibration of process monitoring and verification instruments, or checking them for accuracy, as a verification activity

ISO 9001:2026 was published on 16 September 2026, and published comparisons show the measuring resources clause keeping its number with only editorial changes. The 2015 edition’s numbering (7.1.5.1 general, 7.1.5.2 measurement traceability) is still what most procedures quote, so check your wording against the new text at your transition.

What the Calibration Management Checklist Covers

Seven phases take one instrument from its due date back into service. One answer chooses the in-house or external lab phase, and an out-of-tolerance result adds the impact assessment, which halts until the quality manager approves it.

  1. Plan

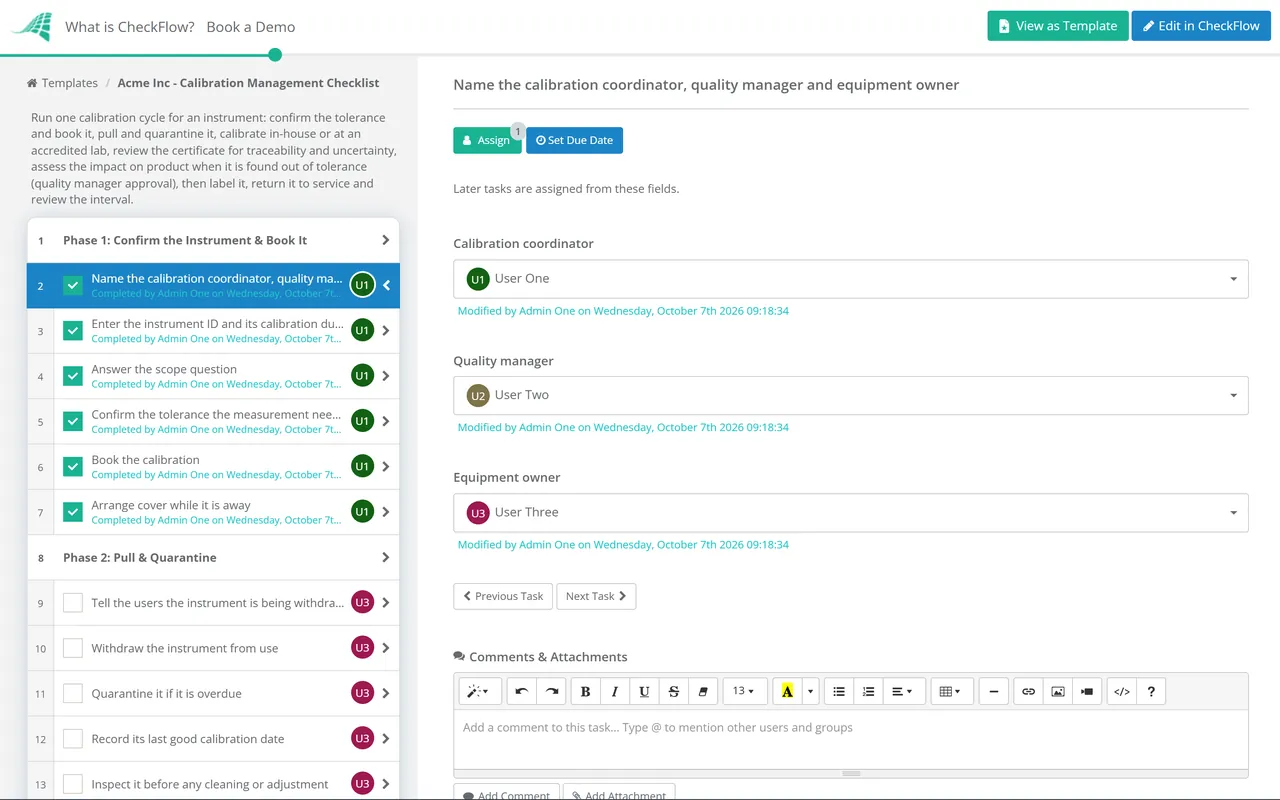

    Phase 1: Confirm the Instrument & Book It

    6 tasks

    Owned by the calibration coordinator. Scope question: calibration done by (In-house / External accredited lab). Start the checklist from the instrument’s recurring schedule about a month before its calibration due date; the booking task is due 7 days after the start.

    • Name the calibration coordinator, quality manager and equipment owner — later tasks are assigned from these fields
    • Enter the instrument ID and its calibration due date — from the equipment register, with description, serial number, location and range
    • Answer the scope question — whether this instrument is calibrated in-house or by an external accredited lab
    • Confirm the tolerance the measurement needs — from the product or process requirement it supports, not just the manufacturer’s specification
    • Book the calibration — lab slot or in-house technician, with the expected turnaround
    • Arrange cover while it is away — a calibrated spare, a loan instrument or production planned around the gap
  2. Recall

    Phase 2: Pull & Quarantine

    5 tasks

    Assigned to the equipment owner. An instrument found past its due date is quarantined, not just withdrawn.

    • Tell the users the instrument is being withdrawn — when it goes, what replaces it and when it should be back
    • Withdraw the instrument from use — collect it from its location and confirm it is the ID on the register
    • Quarantine it if it is overdue — label it “do not use” and keep it apart until it is calibrated
    • Record its last good calibration date — the date of the last in-tolerance result, which bounds any impact assessment later
    • Inspect it before any cleaning or adjustment — damage, wear, missing parts and battery state, so the as-found reading is genuine
  3. In-house

    Phase 3: Calibrate In-House

    6 tasks

    Shown only when calibration is done In-house. Assigned to the calibration coordinator.

    • Follow the written calibration procedure — method, calibration points, acceptance criteria and required environment
    • Check the reference standards are in date — each with a current certificate traceable to national or international standards
    • Confirm the technician is authorised for this procedure — training record on file for this instrument type
    • Record the as-found readings before adjusting anything — every calibration point, with the environmental conditions
    • Adjust if needed and record the as-left readings — the same points again after adjustment or repair
    • Record the measurement uncertainty — from the procedure’s uncertainty budget, and check it is small against the tolerance
  4. External lab

    Phase 4: Calibrate at an Accredited Lab

    5 tasks

    Shown only when calibration is done by an External accredited lab. Assigned to the calibration coordinator.

    • Check the lab’s accredited scope covers this calibration — parameter, range and best uncertainty on the accreditation body’s published schedule
    • Send clear calibration instructions — points to test, as-found and as-left data, accredited certificate, and whether adjustment is allowed
    • Agree a decision rule if you want a pass or fail statement — how uncertainty is treated when a result sits close to a limit
    • Pack and ship the instrument safely — protective packaging, the purchase order and a dispatch record
    • Track the return against the agreed turnaround — chase the lab before the cover arrangement runs out
  5. Review

    Phase 5: Review the Certificate

    6 tasks

    Assigned to the calibration coordinator. The as-found result question here shows Phase 6 when the answer is Out of tolerance.

    • Check the certificate matches the instrument — ID, serial number, calibration date and the points you asked for
    • Check traceability and accreditation — a traceability statement, and the accreditation symbol for work within the lab’s scope
    • Check the uncertainty is fit for the tolerance — an uncertainty close to the tolerance makes a pass hard to trust
    • Answer the as-found result question — In tolerance or Out of tolerance, judged against your tolerance, not the lab’s
    • Record the as-left results — and confirm the instrument now meets its tolerance
    • Attach the certificate to this task — so the register entry and the evidence stay together
  6. Impact

    Phase 6: Out-of-Tolerance Impact

    6 tasks

    Shown only when the as-found result is Out of tolerance. The approval is assigned from the quality manager field, and the checklist halts until it is Approved.

    • Keep the instrument out of use — until it is adjusted, repaired and recalibrated, or retired
    • List what it measured since its last good calibration — products, batches, tests and inspections, and where each one went
    • Assess the effect of the error on those results — size and direction of the error against each product tolerance; would any accept decision change
    • Propose a disposition for the affected product — no action, re-inspect, hold, rework, notify customers or recall
    • Quality manager approval of the impact assessment and disposition — the evidence, the decision and who must be told
    • Raise a CAPA if the cause needs investigating — drift on several gauges, damage in use or an interval that was too long
  7. Return

    Phase 7: Return to Service & Review the Interval

    5 tasks

    Assigned to the equipment owner. The next cycle is started by the instrument’s recurring schedule.

    • Label the instrument with its status — ID, calibration date, next due date and who calibrated it
    • Remove the quarantine label and return it to its location — and tell the users it is back
    • Update the equipment register — new due date, as-found and as-left results and the certificate reference
    • Review the interval against its history — extend, keep or shorten it using your written decision rule
    • Record the reason for any interval change — so the next auditor can see the basis

How to Set and Adjust Calibration Intervals

The interval is yours to set. ISO/IEC 17025 does not let an accredited lab recommend one on the certificate unless you agreed it, because only you know how hard the instrument is used. Start from a risk-based estimate: the uncertainty the measurement needs, the manufacturer’s recommendation, how quickly this type of instrument drifts or wears, how often and where it is used, and how it is transported. Then let the instrument’s own history adjust it. The joint guidance ILAC-G24 / OIML D 10, Guidelines for the determination of recalibration intervals of measuring equipment (2022 edition), describes five ways to do that.

MethodHow it worksSuits
Automatic adjustment (“staircase”)Extend the interval when the as-found error sits inside a set share of the tolerance; shorten it when it does notMost workshops; simple to run from the as-found result each cycle
Control chartPlot the same calibration points over time and set the interval from the drift and scatterReference standards and instruments with a long, stable history
In-use timeCount hours or cycles of use instead of calendar timeEquipment with an hour meter, or tools used in bursts
In-service checking (“black box”)Check critical parameters often with a check standard; recalibrate fully only when a check fails or a long interval endsInstruments easy to check in place, such as balances with check weights
Other statistical approachesModel reliability across a population of similar instrumentsLarge fleets of identical gauges

Whatever the method, write the decision rule down so the interval review in Phase 7 is a check, not a debate. A good equipment register holds, for each instrument: a unique ID, description and serial number, location and owner, range and required tolerance, who calibrates it, the interval and its basis, the last and next due dates, the as-found and as-left history and the certificate reference. Do not extend an interval far in one step: if an instrument then fails, every result since its last good calibration is in question.
