IT Service Request Fulfilment Checklist Template

Standard requests are routine until the approval sits in someone’s inbox for a week, the access granted is wider than the access asked for, or the ticket closes before the requester can use what they asked for.

Last reviewed: October 2026

Printed from checkflow.io/templates/information-technology/service-request-fulfillment-checklist

This free service request fulfilment checklist is for service desk leads, IT support teams and MSPs handling standard requests from a catalogue: a software install, access to a shared mailbox or application, new or replacement equipment, or a permission change. Each request is logged against its catalogue item, checked for entitlement, approved where the item is not pre-approved, fulfilled by the documented procedure, confirmed by the requester and closed with a record of what changed. The request type shows only the steps that item needs, and every closed request feeds a quarterly review of the catalogue itself.

Request, Incident or Change: Sort It Before You Start

The ITIL 4 practice guides describe service request management as handling all predefined, user-initiated service requests in an effective and user-friendly manner. Two words in that sentence do the work. Predefined means the request matches an item in the catalogue, with a known procedure, a known approval route and a fulfilment target. User-initiated means someone asked for something new, not that something stopped working.

Most queues mix three kinds of ticket, and each needs a different route. ITIL 4’s change enablement practice calls the low-risk, pre-authorised and fully documented kind of change a standard change, and notes that many start life as service requests. Anything that needs an assessment no catalogue item can give in advance is a normal change. That boundary is the one this checklist works inside.

Service request

Something new, from the catalogue

Example: access to the finance team’s shared mailbox.

Route: entitlement, approval if the item needs it, the documented procedure.

Measured by: fulfilment time against the item’s target.

Incident

Something that stopped working

Example: the shared mailbox will not open.

Route: triage, diagnosis and restoring service, through the Support Ticket Response Checklist.

Measured by: time to restore service.

Change

Something outside the catalogue

Example: a new shared mailbox that forwards to an outside supplier.

Route: assessment and authorisation in the IT Change Management Checklist.

Measured by: changes that succeed without causing an incident.

What the Service Request Fulfilment Checklist Covers

Six phases take one request from the portal to a closed fulfilment record. The request type on the first task shows only the sourcing, fulfilment and verification steps that item needs. The approval route decides whether one approval, two or none appear, and each approval halts the checklist until a decision is recorded. Run it once per request; it has no recurring schedule.

  1. Phase 1

    Phase 1: Log & Classify

    5 tasks

    The request type and the fulfiller are recorded on the first task. The request type decides which tasks appear in Phases 3, 4 and 5.

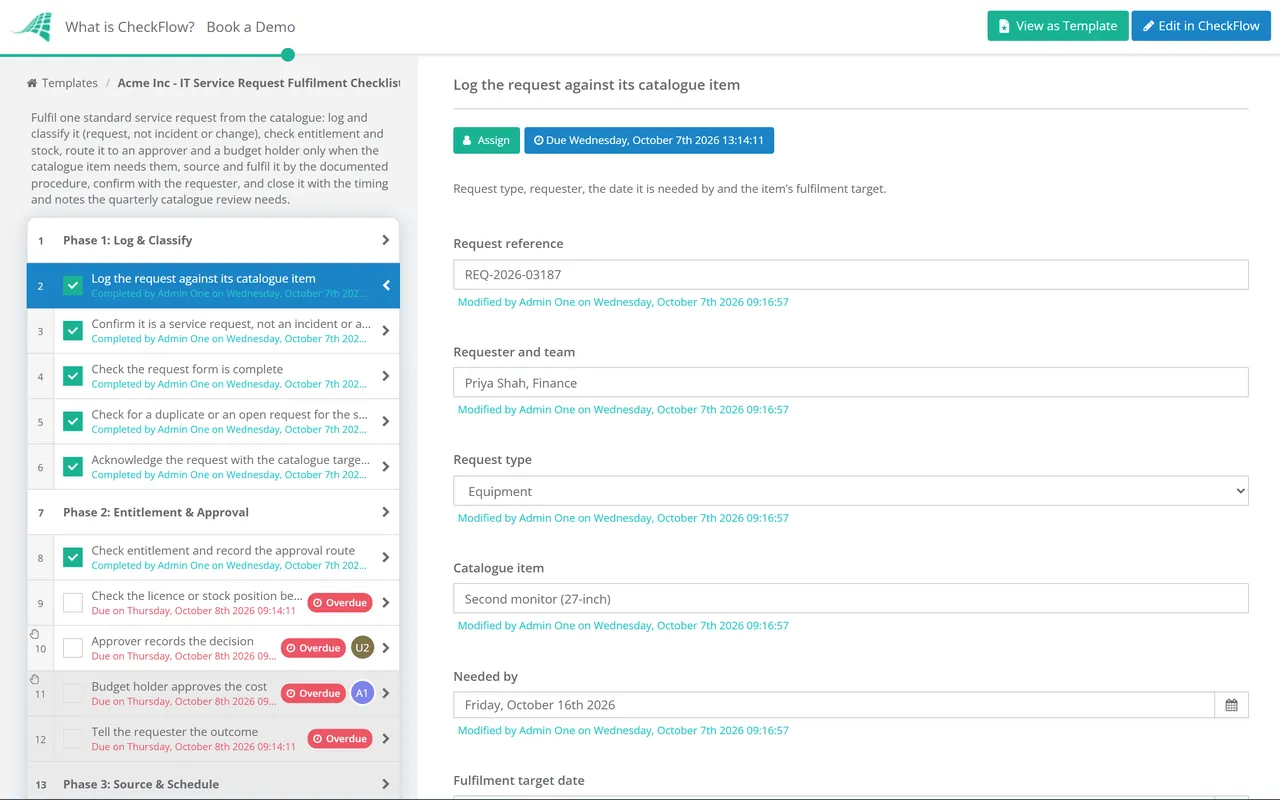

    • Log the request against its catalogue item — request type, requester, the date it is needed by and the item’s fulfilment target
    • Confirm it is a service request, not an incident or a change — something broken goes to the incident queue, something outside the catalogue to change enablement
    • Check the request form is complete — device name, licence edition, mailbox or group name, access level or delivery address, whatever the item asks for
    • Check for a duplicate or an open request for the same thing — two tickets for one laptop end in two laptops
    • Acknowledge the request with the catalogue target date — a date the requester can plan around, not “as soon as possible”
  2. Phase 2

    Phase 2: Entitlement & Approval

    5 tasks

    The approval route, approver and budget holder are recorded on the first task. Pre-approved items show neither approval. Each approval halts the checklist until it is recorded as Approved or Not approved.

    • Check entitlement and record the approval route — the catalogue item says whether it is pre-approved; role, team and contract type decide who is entitled
    • Check the licence or stock position before asking anyone to approve — an approval for an item nobody can supply is an approval for a wait
    • Approver records the decision — the line manager, or the owner of the mailbox or application for access requests, records Approved or Not approved
    • Budget holder approves the cost — cost centre and amount, for items outside the role’s standard allowance
    • Tell the requester the outcome — a refusal goes back with the reason and the nearest item they are entitled to
  3. Phase 3

    Phase 3: Source & Schedule

    5 tasks

    The licence task appears only for software installs, the stock task only for equipment, and the group task only for access and permission changes. The change task stays visible for every request, because any of them can turn out to be non-standard.

    • Find a free licence or reclaim an unused one — check the pool before buying; a seat unused for 90 days is a common reclaim rule
    • Allocate a device from stock or raise the order — stock built to the current standard first; an order gets a purchase order and a delivery date the requester is told
    • Identify the group that grants the access and its owner — access is given through a group the owner controls, not a one-off permission
    • Agree a time with the requester when fulfilment needs them — installs that force a restart, a device handover, or a first sign-in to new access
    • Raise a change record if the work falls outside the documented procedure — a server change, a new group or a new integration is not a standard request
  4. Phase 4

    Phase 4: Fulfil

    6 tasks

    One fulfilment task appears for the request type, between the procedure task and the record task that every request gets.

    • Follow the catalogue item’s documented procedure — the written steps, not the version the fulfiller remembers
    • Install the software from the approved package and assign the licence — through device management where possible, recorded against the person
    • Add the requester to the group with the access level asked for — read, send as and full access to a mailbox are three different requests
    • Prepare and hand over the device — built to the current standard, asset tag recorded against the person, delivered or collected
    • Make the permission change and record the before and after — including access the person no longer needs in their new role
    • Update the fulfilment record with what changed — licence, asset tag, group or permission, with the date
  5. Phase 5

    Phase 5: Verify with the Requester

    5 tasks

    The device receipt task appears only for equipment requests.

    • Ask the requester to confirm it works — they sign in, open it or use it; a request is fulfilled when the requester can use what they asked for
    • Check the access granted is no wider than the request — the right mailbox with the right rights, not a broader group that was quicker to find
    • Send a short note on how to use it and where to get help — including any licence terms or handling rules that come with it
    • Record who received the device and the asset acknowledgement — the signature that makes the device recoverable when they leave
    • Apply your rule when confirmation does not arrive — for example two reminders over three working days, then close as fulfilled but unconfirmed
  6. Phase 6

    Phase 6: Close & Feed the Catalogue Review

    5 tasks

    These tasks give the quarterly catalogue review its data. The flag on the last task is what the review sorts by.

    • Close the request with the fulfilment record — what was delivered, by whom, when and under which approval
    • Record the fulfilment time against the catalogue target — with time spent waiting for approval kept separate from time spent working
    • Record why a request was refused or could not be fulfilled — repeated refusals usually mean the catalogue describes entitlement wrongly
    • Note any step in the procedure that was wrong or missing — fix it once in the procedure rather than working around it every time
    • Flag the item for the catalogue review — a candidate to pre-approve, automate, change the form or retire

Reviewing the Catalogue Every Quarter

Each request checklist shows whether one request was handled well. The catalogue review asks a different question: are these the right items, with the right approvals, procedures and targets? It runs on its own quarterly schedule and reads the records Phase 6 leaves behind. The thresholds below are sensible starting points to tune, not a standard.

Signal in a quarter’s records What it usually means Decision to consider
An item approved almost every time, say 95% or moreThe approval adds waiting, not controlPre-approve it for the roles that always get it
The same console steps, many times a monthA person is doing work a script or group rule could doAutomate it, or make it self-service through group membership
Fulfilment time regularly over targetThe target is unrealistic, or the procedure has a bottleneckFix the bottleneck first; change the target only if it cannot be fixed
Approval wait longer than the work itselfApprovers are hard to reach, or the wrong peopleChange the approver, add a deputy or send a reminder before the target
Incomplete forms, or requests rerouted as incidentsThe form or the item description is unclearRewrite both in the requester’s words
Frequent refusals on entitlementPeople can see items they cannot haveShow the item only to entitled roles
No requests for two quartersNobody needs it, or nobody can find itRetire it or rename it
Repeated requests for something not in the catalogueA missing itemWrite its procedure, approval route and target, then add it

Treat a new or changed item as a change in its own right. The first time a procedure is written, someone assesses the risk and authorises it; from then on each request under it runs as standard, with no assessment of its own. That is what makes pre-approval safe rather than a shortcut.

Keep the review small. An hour a quarter with the service desk lead, the catalogue owner and one approver from the business is usually enough to act on the flags. Running it from a recurring checklist means it happens in the quarters when the queue is busy, which are the quarters it matters most.

Why Run Service Requests in CheckFlow?

1

Only the steps this item needs

The REST API or a webhook from your request form can start a run as each request arrives, and Zapier covers forms without a developer. Conditional logic reads the request type and shows only the licence, device, access or permission tasks, so a software install runs in a handful of steps.

2

Approvals that stop the work

The approver and budget holder are picked in members fields, and the approval tasks are assigned to them. The checklist halts until they record a decision, so nothing is installed, ordered or granted on an assumed yes, and the decision sits on the request.

3

A catalogue the review can trust

Keep catalogue items in a data set with their approval route, procedure and target, so each run fills from the current entry. Fulfilment times, refusal reasons and review flags sit in fields, and the activity trail shows who approved and who fulfilled each request.

This checklist starts once triage has put a ticket in the request pile. The IT Support Checklist sets up the desk, its tiers and SLAs, and the IT Help Desk Daily Checklist keeps the whole queue moving each day, including requests stuck waiting on a decision. Remote staff asking for kit at home follow the IT Equipment Request Process Checklist, which adds shipping and home setup.

A stock laptop is only as good as the build it was prepared to, and that standard lives in the Laptop Provisioning & Imaging Checklist. CheckFlow’s approval software shows how named approvers and halting approvals work for other requests, from purchases to policy exceptions.

AI generator

Didn’t find what you need? Describe it.

Describe the process in a sentence and the AI checklist generator drafts the phases and tasks for you.

Frequently Asked Questions

What is service request fulfilment?

It is the work of delivering a standard, catalogued request: installing software, granting access, issuing equipment or changing a permission by a documented procedure, after any approval the item needs, then confirming with the requester and closing with a record. ITIL 4 places it inside the service request management practice, which also covers the catalogue, approval routes and how requests are logged and tracked.

What is the difference between a service request and an incident?

An incident is an unplanned interruption to a service, or a drop in its quality: something that worked has stopped working. A service request is a normal, agreed part of service delivery that a user asks for, such as access or a new device. Keep them in separate categories, because they are measured against different targets and handled by different procedures.

Are service requests the same as standard changes?

They overlap. In ITIL 4 a standard change is low-risk, pre-authorised, well understood and fully documented, and many are started as service requests. Plenty of requests change nothing in the infrastructure, such as a loan laptop or a how-to question. A request that needs work outside its documented procedure is no longer standard: raise a change record and have it assessed.

Which service requests should be pre-approved?

Items that are low cost, low risk and granted nearly every time someone in an eligible role asks: software from an approved list, peripherals within an allowance, access to resources every member of a team has. Keep approval for anything above a set cost, anything that opens sensitive data, and anything that needs a business judgement. Revisit the split each quarter using your approval rates.

How do you measure service request fulfilment?

Measure fulfilment time against each item’s target, with time spent waiting for approval reported separately, so slow approvers do not look like slow fulfillers. Add the share fulfilled right first time, requests reopened, forms returned as incomplete and requester satisfaction. Report per catalogue item, because an average across every item hides the few that are struggling.

What should a service catalogue item include?

A plain description in the requester’s language, who is entitled to it, whether it is pre-approved or who approves it, the form fields needed to fulfil it, the documented procedure, a fulfilment target and a named owner. Without the procedure and the owner, the item is a promise nobody is responsible for keeping.

Is CheckFlow free for this template?

14-day free trial, no card required. The Business plan is $10 per user per month after the trial. Full details at checkflow.io/pricing.
