Enterprise Customer Implementation Checklist Template

Enterprise implementations rarely fail on the configuration. They stall on a security questionnaire nobody owns, an integration whose system owner was never asked, or a go-live date the customer’s sponsor never actually agreed.

This free template is for implementation managers, solutions engineers and professional services teams at software vendors taking a large customer from signed contract to business as usual. It covers the governance both companies agree at the start, the security, legal and procurement work that gates everything else, configuration and integrations, testing, training and change, go-live and cutover, hypercare and the handover to customer success. Three scope questions tailor each run: data migration shows a whole migration phase, single sign-on or SCIM provisioning shows the identity task, and a pilot before full rollout shows the pilot task.

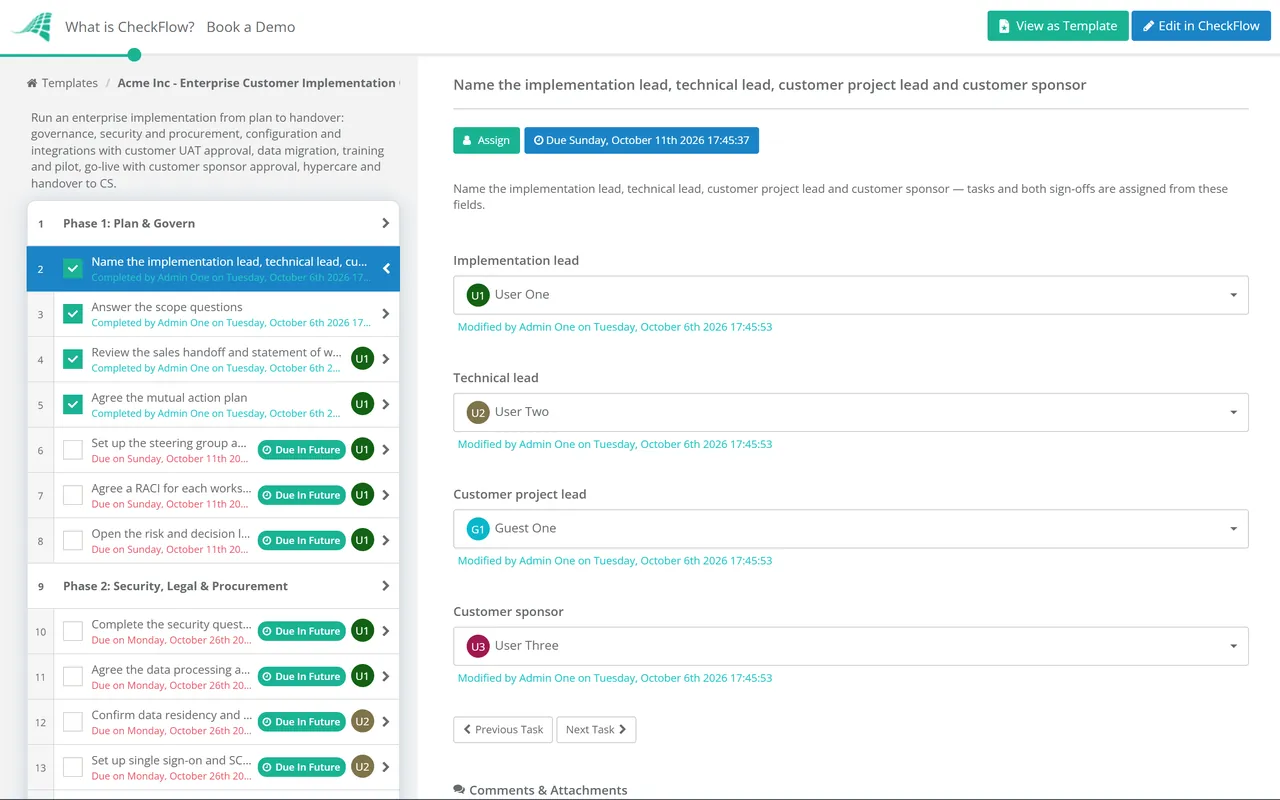

Use This Template Free See Live Example
No Credit Card Required

Last reviewed: October 2026

Implementation Is Not Just Bigger Onboarding

A self-serve or mid-market customer is onboarded: one admin, a kickoff, some configuration and training, and the customer is live within weeks. An enterprise customer is implemented. Before anyone configures anything, the security team wants a questionnaire answered and a data processing agreement signed, procurement wants a supplier record and a purchase order, and IT wants single sign-on and automated user provisioning. After that come several workstreams running in parallel, each with an owner on both sides, and a go-live date the sponsor will be asked about by their own leadership.

The difference is governance. Onboarding needs a plan. Implementation needs a plan both companies have agreed, a steering group that can make decisions, and a record of every decision and risk. This template runs the vendor’s side of that project. The customer’s IT team, running its own internal rollout, can use the New Software Implementation Checklist for their side.

Run one checklist per customer, started when the sales handoff is accepted. Every workstream sits in the same place, so the steering group reviews one list of overdue tasks instead of five status reports, and the history shows who signed off what when someone asks six months later.

SaaS onboarding

One team, first value

Kickoff, configuration, training and a first real workflow, usually led by one CSM. Use the SaaS Customer Onboarding Checklist.

Enterprise implementation

Several workstreams, one go-live

Security and procurement, identity, integrations, data migration, training and cutover, with a steering group and formal sign-offs. This checklist.

Customer’s rollout

The buyer’s own project

Owners, pilot, communications and retiring the old tool inside the customer’s organisation. Use the New Software Implementation Checklist.

What the Enterprise Implementation Checklist Covers

Seven phases run from the implementation plan to the handover to customer success. Phase 4 appears only when data is being migrated from another system. In Phase 2 the single sign-on and provisioning task appears only when SSO or SCIM is in scope, and in Phase 5 the pilot task appears only when a pilot comes before full rollout.

Plan

Phase 1: Plan & Govern

Answer the scope questions at the planning meeting. They decide whether the migration phase, the identity task and the pilot task appear.

  • Name the implementation lead, technical lead, customer project lead and customer sponsor — tasks and both sign-offs are assigned from these fields
  • Answer the scope questions — is data being migrated, is single sign-on or SCIM provisioning in scope, and will a pilot come before full rollout
  • Review the sales handoff and statement of work — scope, services hours, dates and every commitment made during the sale
  • Agree the mutual action plan — milestones, owners on both sides and dates both companies have signed up to
  • Set up the steering group and meeting rhythm — sponsor-level steering every two to four weeks, working sessions weekly
  • Agree a RACI for each workstream — one accountable person per workstream, with a named person on each side
  • Open the risk and decision log — every risk with an owner, every decision with a date and who made it
Security

Phase 2: Security, Legal & Procurement

  • Complete the security questionnaire — the customer’s own or a standard such as the SIG or CAIQ, with your SOC 2 report or ISO 27001 certificate where you have one
  • Agree the data processing agreement and sub-processor list — including how the customer is told about future sub-processor changes
  • Confirm data residency and hosting region — and note any data that must not leave a region
  • Set up single sign-on and SCIM provisioning — shown only when in scope; test sign-in and user creation, update and deactivation with the customer’s identity team
  • Complete supplier set-up and the purchase order — so the first invoice is not rejected for a missing PO number
Build

Phase 3: Configure, Integrate & Test

  • Configure the environment to the agreed design — workspaces, roles, permissions, templates and notification settings
  • Build each integration in a test environment first — with error handling and a named owner on each side
  • Test permissions with real roles — sign in as each role and confirm what it can and cannot see
  • Run user acceptance testing — the customer’s testers work through scripts written from the success criteria
  • Customer project lead approval of UAT results — defects are fixed or accepted in writing before go-live planning starts
Migrate

Phase 4: Data Migration

Shown only when data is being migrated from another system.

  • Agree what moves and what stays behind — by record type and date range, with an archive plan for the rest
  • Map fields and clean the source data — duplicates, closed records and free-text values that need to become a list
  • Run a trial migration and reconcile counts — record counts plus a sample checked by the customer’s data owner
  • Agree the cutover freeze window — when the old system goes read-only and who can approve an exception
  • Plan the final migration run — sequence, timings and the reconciliation report for go-live day
Adopt

Phase 5: Train & Prepare the Change

  • Train the customer’s administrators — user management, configuration changes and how to reach support
  • Run train-the-trainer sessions for team champions — so each department has someone who can answer the first questions
  • Run the pilot with one team and review the results — shown only when a pilot comes first; agree the criteria for widening the rollout before it starts
  • Publish end-user guides and short training — built around the customer’s own workflows, not a product tour
  • Send the change communications — what changes, when, why and who to ask, from the customer’s sponsor rather than the vendor
Go-live

Phase 6: Go-Live & Cutover

  • Run the go-live readiness review — UAT signed off, users provisioned, training done, support staffed and data reconciled
  • Confirm the rollback plan and decision point — what would trigger a rollback, by when, and who decides
  • Customer sponsor approval of go-live — the checklist halts here until the sponsor approves the date
  • Execute the cutover plan — final migration, integrations switched on and the old system set to read-only
  • Staff go-live support — named people on both sides, one channel for issues and a daily review
Handover

Phase 7: Hypercare & Handover to CS

  • Run hypercare for the agreed period — daily issue triage and faster responses, for the period set in the statement of work
  • Track adoption against the success metrics — active users, workflows in use and the measures agreed at the start
  • Close or transfer the open issues — fixed, accepted, or moved to standard support with an owner
  • Hold the transition meeting with the CSM — the CSM takes the account with the success metrics, risks and decisions on file
  • Run the implementation retrospective — with the customer: what to keep and what to change for the next project

Who Does What: An Implementation RACI

A RACI names who is Responsible for doing the work, who is Accountable for the result, who is Consulted and who is Informed. The table is a starting point for the vendor and customer columns; adjust the names to your own teams and copy it into the mutual action plan in the first week.

Workstream Responsible (vendor) Responsible (customer) Accountable
Plan and governanceImplementation leadCustomer project leadCustomer sponsor
Security, legal and procurementSecurity and legal teamsIT security, legal and procurementCustomer’s risk or security owner
Identity (SSO and SCIM)Technical leadIdentity or IT admin teamCustomer IT owner
IntegrationsTechnical leadOwners of each connected systemCustomer project lead
Data migrationTechnical leadData owner for each source systemCustomer data owner
Training and changeImplementation leadChampions and internal communicationsCustomer project lead
Go-live and cutoverImplementation leadCustomer project leadCustomer sponsor
Hypercare and handoverImplementation lead, then CSMCustomer project leadCustomer sponsor

Most stalls are on the customer side. A security review with no owner, an integration whose system owner was never asked, a data owner who thinks migration is the vendor’s job. Naming a customer person against every row in week one finds those gaps while there is still time, and gives the steering group something specific to chase.

Go-live readiness, in one list. The sponsor should approve a date against evidence, not a feeling. Put these in front of them at the readiness review:

  • UAT signed off, with any accepted defects listed
  • Every user provisioned, and deactivation tested
  • Integrations running in production, each with an owner for alerts
  • Migrated data reconciled against the source and checked by the data owner
  • Administrators trained and a champion named in each team
  • Support staffed for go-live day and a rollback decision time agreed

Identity is worth getting right early. Single sign-on usually runs on SAML 2.0 or OpenID Connect. Automated provisioning usually runs on SCIM 2.0, defined in IETF RFCs 7643 and 7644, which creates, updates and deactivates users from the customer’s identity provider. Test deactivation hardest: it is the part the customer’s security team will ask about, and the part most often left until after go-live.

Why Run Enterprise Implementations in CheckFlow?

1

One plan, dated from day one

Every workstream task carries an owner from the role fields and a due date offset from the project start, so the plan is dated the moment the checklist starts. Start it from your CRM or professional services tool through the API.

2

Sign-offs that stop the clock

UAT results and the go-live date each stop at an approval step, so nothing moves to cutover until the customer has said yes. Approvals, comments and attached test evidence stay in the checklist history.

3

Only the workstreams this customer needs

Conditional logic shows the migration phase, the identity task and the pilot only where they apply, so one template covers every enterprise deal. Reports show which implementations have overdue tasks.

Before the project starts, the Sales to Customer Success Handoff Checklist gets the deal facts and promises on file. The kickoff meeting can run from the Project Kickoff Checklist, and the customer’s security team often works from something like the Vendor Risk Assessment Checklist, so it helps to know what they will ask. After hypercare, the Customer Success Strategy Checklist sets how the account is managed.

Implementing for several enterprise customers at once? CheckFlow for client onboarding runs every implementation, handoff and onboarding from the same templates, so each customer gets the same governance whoever leads the project.

Frequently Asked Questions

What is an enterprise customer implementation?

+

It is the project that takes a large customer from signed contract to using the product as part of normal work. Unlike standard onboarding, it usually includes a security review and data processing agreement, single sign-on and user provisioning, integrations with the customer’s systems, often a data migration, formal acceptance testing, a go-live sign-off and a period of hypercare, with a steering group and owners on both sides.

How long does an enterprise SaaS implementation take?

+

It depends on which workstreams are in scope, and the customer’s security review and data migration usually set the pace rather than configuration. A deal with no migration and standard single sign-on moves much faster than one with several integrations and years of records to move. Agree the dates in the mutual action plan, start the security work on day one, and treat any date that depends on an unnamed customer owner as a risk.

What is a mutual action plan?

+

A mutual action plan is a dated list of the steps both companies will take to reach a shared goal, with an owner on each side for every step. Sales teams often use one to reach signature; in implementation it carries on to go-live. Its value is that the customer agreed it, so a missed customer task is a fact in the plan rather than the vendor’s complaint.

What is hypercare after go-live?

+

Hypercare is a fixed period straight after go-live when the implementation team stays on with faster response times and a daily review of issues, before the customer moves to standard support. Its length is agreed in the statement of work. It ends with open issues closed or handed to support with an owner, and the account handed to the customer success manager with the agreed success metrics.

What security documents do enterprise customers ask for?

+

Usually a completed security questionnaire, a data processing agreement, a sub-processor list and evidence of your controls. Questionnaires are often the customer’s own or a standard one such as the Shared Assessments SIG or the Cloud Security Alliance CAIQ. Evidence typically means a SOC 2 report or ISO 27001 certificate where you have one, plus answers on data residency, encryption, access control and incident response.

Who should sign off go-live?

+

The customer’s sponsor, after the customer’s project lead has signed off acceptance testing. The vendor recommends a date and shows the readiness evidence; the sponsor decides, because it is their organisation that changes the way it works on that day. Recording the approval with the date and the evidence it was based on avoids a later argument about who agreed to go live with known issues.

Is CheckFlow free for this template?

+

14-day free trial, no card required. The Business plan is $10 per user per month after the trial. Full details at checkflow.io/pricing.
