Contractor Onboarding Checklist Template

Contractors are usually brought on in a hurry, through a process designed for employees. Six months later the organisation finds accounts with no end date, work it does not clearly own and a classification decision nobody wrote down.

Onboarding a freelancer, consultant or contract specialist is a different job from onboarding an employee. There is no probation period, no benefits enrolment and no 90-day integration plan. Instead there is a contract and a statement of work, a check that the person really is self-employed, an NDA and an IP assignment, a supplier record for invoicing, and system access that has to end on a known date. This free contractor onboarding checklist covers exactly those steps, from the engagement request to the planned exit. It sets the offboarding date on day one, so access, equipment and the final invoice are dealt with on time. If you are hiring an employee, use the Employee Onboarding Checklist instead.

Use This Template Free See Live Example
No Credit Card Required

Onboarding an Employee vs Onboarding a Contractor

Most onboarding processes are built around employees: an offer letter, payroll, a handbook, a buddy and a series of 30, 60 and 90-day check-ins. Run a contractor through that process and two things go wrong. Steps that matter for contractors, such as the statement of work, the IP assignment and the end date on their accounts, are missing. And steps that treat the contractor like an employee, such as setting their hours or putting them through the standard induction, can undermine the self-employed status the engagement depends on.

The single most useful change is to set the end date at the start. When the planned end date is recorded on the first task, it can drive everything else: the contract term, the expiry date on every account, the reminder to start the handover and the date the final invoice is expected. A contractor whose access expires automatically is a much smaller risk than one whose accounts depend on someone remembering them.

Employee onboarding

Integrating someone into the organisation

Paperwork: offer letter, employment contract, payroll and benefits.

Access: role-based, open-ended, reviewed periodically.

Timeline: preboarding through a 90-day review.

Ends with: a fully integrated team member.

Contractor onboarding

Setting up a time-bound business relationship

Paperwork: contract and SOW, classification record, NDA, IP assignment, supplier and tax forms.

Access: least privilege, limited to the SOW, expiring on the contract end date.

Timeline: request to kickoff, then planned checkpoints and exit.

Ends with: delivered work, recovered access and a paid final invoice.

What the Contractor Onboarding Checklist Covers

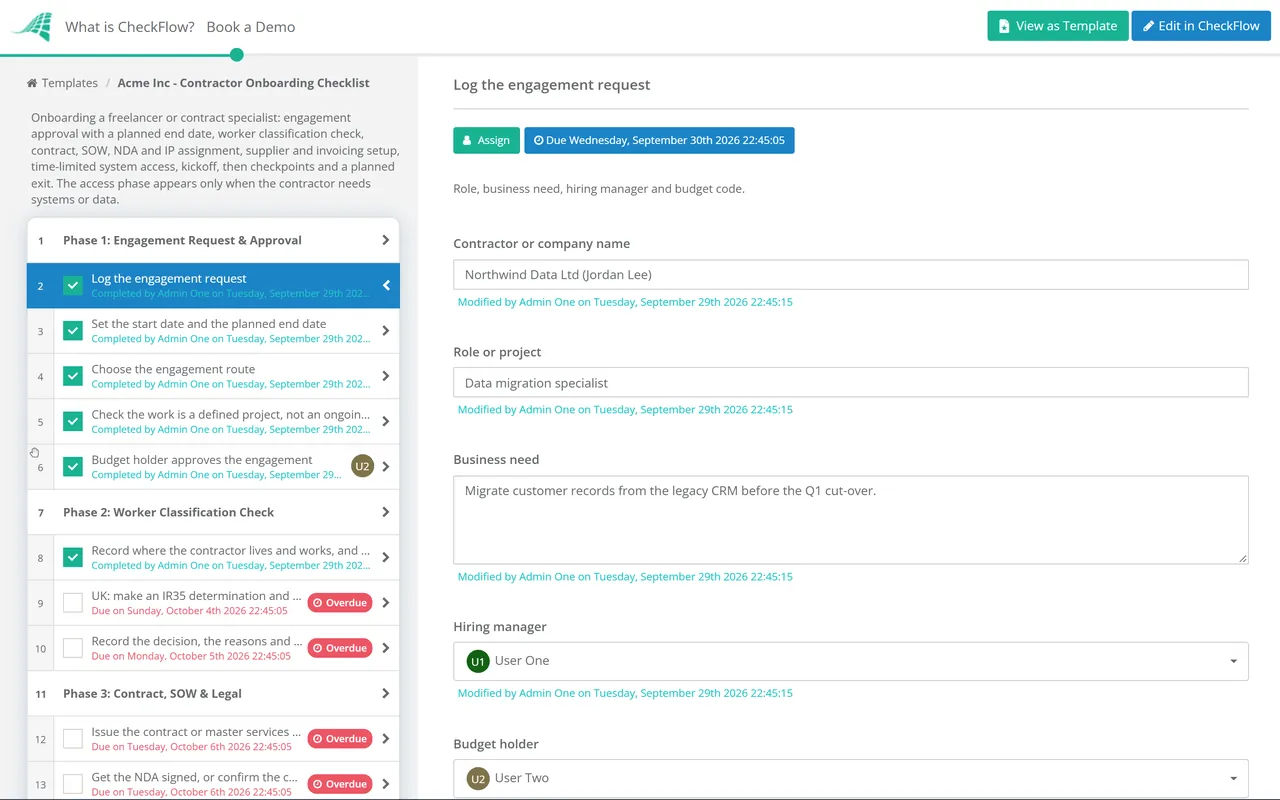

Seven phases run from the engagement request to the planned exit. The access phase appears only when the contractor needs systems or data.

Phase 1

Phase 1: Engagement Request & Approval

  • Log the engagement request — role, business need, hiring manager and budget code
  • Set the start date and the planned end date now — the end date drives access expiry, the contract term and the exit tasks
  • Choose the engagement route — direct contractor, agency or employer of record — and follow the procurement rules for it
  • Check the work is a defined project, not an ongoing role being filled by a contractor
  • Budget holder approves the engagement
Phase 2

Phase 2: Worker Classification Check

A process step, not legal advice. It makes sure the question is asked, answered by the right person and written down.

  • Record where the contractor lives and works, and which country’s rules apply
  • US: assess against the IRS and Department of Labor tests, then check for a stricter state test — the IRS common-law factors, the DOL economic reality test and any state test
  • UK: make an IR35 determination and issue a Status Determination Statement — when the contractor uses their own limited company and your organisation is medium, large or public sector
  • Elsewhere: apply the local test, or engage through an employer of record
  • Record the decision, the reasons and who made it, and refer unclear cases to employment counsel or a tax adviser
Phase 3

Phase 3: Contract, SOW & Legal

  • Issue the contract or master services agreement with a statement of work — deliverables, milestones, acceptance criteria, rate and term
  • Get the NDA signed, or confirm the contract’s confidentiality terms cover the work
  • Include a written IP assignment — without one, the contractor may own what they create
  • Add data protection terms if the contractor will handle personal data
  • Collect insurance certificates where the contract requires them — professional indemnity and liability cover
  • Run background or conflict-of-interest checks in proportion to the role
Phase 4

Phase 4: Supplier & Invoicing Setup

  • Create the supplier record — a Form W-9 in the US; company, VAT and bank details in the UK
  • Raise a purchase order against the statement of work
  • Agree the invoicing cadence, approval route and invoice approver — how timesheets or milestones are approved and who approves each invoice
  • Flag the supplier for year-end reporting — Form 1099-NEC in the US once payments reach the threshold
  • Share the expenses policy, if expenses are reimbursable
Phase 5 — If Access Is Needed

Phase 5: Time-Limited System Access

Shown only when the contractor needs access to systems or data. Conditional logic keeps IT out of engagements that don’t need them.

  • Request only the access the SOW needs — named systems and permission levels, approved by each system owner
  • Create accounts labelled as contractor accounts, with an expiry date set to the contract end date
  • Enforce MFA and confirm the device — a company laptop, or an approved personal device that meets your security standard
  • Complete security and acceptable-use training before access is switched on
  • Record every account, licence and device issued, so the exit can reverse each one
Phase 6

Phase 6: Kickoff

Keep the kickoff about the work, not how the contractor organises their day. Directing how and when someone works is a factor that points towards employment.

  • Name one point of contact for day-to-day questions
  • Walk through the SOW — deliverables, acceptance criteria and the first milestone
  • Introduce the contractor to the people and channels they will work with
  • Agree how and when progress will be reported
Phase 7

Phase 7: Checkpoints & Planned Exit

Due dates in this phase are set from the planned end date recorded in Phase 1.

  • Review progress against the SOW at each agreed checkpoint
  • If extended: issue a new SOW, repeat the classification check and move account expiry dates
  • Two weeks before the end date, confirm the final deliverables and the handover
  • On the end date, confirm access has been removed and equipment returned
  • Confirm data returned or deleted and IP handed over, then approve the final invoice

Worker Classification: Which Test Applies?

There is no single test for whether someone is self-employed. Each country has its own, and in the US the tax, wage and state tests can give different answers for the same person. The table points to the main tests and the authority that publishes each one. It is a starting point for the Phase 2 check, not legal advice, and the answer always depends on how the work is actually done, not what the contract calls it.

Where Test Who decides Record to keep
US federal taxIRS common-law rules: behavioural control, financial control and the type of relationshipThe business; either party can ask the IRS to decide using Form SS-8The factors considered and the conclusion, plus the W-9
US wage and hourThe Department of Labor’s “economic reality” test under the FLSA. The 2024 rule is still in force, but a February 2026 proposal would replace it and investigators have used the earlier test since May 2025The business, subject to DOL and court reviewControl, opportunity for profit or loss, investment, permanence and integration
US statesSome states apply a stricter test, such as California’s ABC testThe business, under state lawWhich state test applies and how each part is met
United KingdomIR35 off-payroll working rules, for contractors working through their own limited companyThe client, if it is medium or large or in the public sector; otherwise the contractor’s companyA Status Determination Statement with reasons, passed to the contractor and the next party in the chain
ElsewhereLocal employment and tax testsLocal rules, or an employer of record who carries the riskThe local determination or the employer of record agreement

Two details catch organisations out. In the UK, the company-size thresholds used for the off-payroll rules rose from April 2025, so some clients will fall outside the rules from April 2027, while others still in scope must keep issuing determinations and run a client-led process for contractors who disagree. In the US, the Form 1099-NEC reporting threshold rose to $2,000 for payments made from 2026. The authorities to check are the IRS, the Department of Labor and HMRC, whose CEST tool gives a view on UK status.

Why Run Contractor Onboarding in CheckFlow?

1

The end date drives the exit

The planned end date recorded in Phase 1 sets the due dates for the handover, the access removal and the final invoice. Nobody has to remember that a contract is ending, because the checklist has already scheduled it.

2

IT only when it is needed

One question, “Does this contractor need system access?”, decides whether the access phase appears. A copywriter who works from their own tools skips it. A developer gets least-privilege accounts with an expiry date, approved by each system owner.

3

A record for every engagement

The classification decision and its reasons, the signed contract, NDA and IP assignment, and the access log sit on one checklist, with names and timestamps. If a status question comes up two years later, the answer is already written down.

Contractors, employees, agency staff and interns all need a slightly different start. CheckFlow’s onboarding software runs each one from its own template, with conditional steps, approvals and handoffs between HR, finance and the hiring manager.

Access is where contractor onboarding most often goes wrong. CheckFlow’s IT onboarding checklist software shows how IT teams provision accounts and devices from a checklist, and the Employee Offboarding Checklist covers removing them again.

Frequently Asked Questions

What should a contractor onboarding checklist include?

+

At minimum: an approved engagement with a start and end date, a recorded worker classification decision, a signed contract and statement of work, an NDA and a written IP assignment, a supplier record with the right tax forms, least-privilege access that expires on the end date, a kickoff with one point of contact, and planned checkpoints leading to the exit. The checklist should also show who completed each step and when.

How is contractor onboarding different from employee onboarding?

+

Employee onboarding integrates someone into the organisation for the long term: payroll, benefits, culture and a 90-day plan. Contractor onboarding sets up a time-bound business relationship: a contract and SOW, a classification check, IP and confidentiality, invoicing, and access that ends on a fixed date. Treating a contractor like an employee during onboarding, for example by setting their hours or requiring the full staff induction, can also weaken the case that they are self-employed.

How do we check a contractor is correctly classified?

+

Apply the test for the country, and in the US the state, where the work is done, and write down the reasons. In the US that means the IRS common-law factors, the Department of Labor’s economic reality test and any stricter state test. In the UK it means the IR35 off-payroll rules, under which medium and large clients must issue a Status Determination Statement. The checklist makes sure the check happens and is recorded; it is not legal advice, so refer borderline cases to employment counsel or a tax adviser.

Do contractors need to sign an IP assignment?

+

In most cases, yes. In both the US and the UK, work created by an employee in the course of their job normally belongs to the employer, but work created by an independent contractor normally belongs to the contractor unless a written agreement says otherwise. A clear IP assignment in the contract, signed before work starts, avoids a dispute over who owns the code, designs or content you paid for.

How should contractor system access be managed?

+

Give contractors only the access their statement of work needs, approved by each system owner, and set every account to expire on the contract end date. Label the accounts as contractor accounts, enforce MFA and keep a log of every account, licence and device issued. If the engagement is extended, move the expiry dates as part of the extension rather than leaving accounts open-ended.

What happens when a contract is extended?

+

Treat it as a change, not a formality. Issue a new or amended SOW, repeat the classification check, since a long engagement can look more like employment than a short one, and update the end date. In CheckFlow, updating the end date moves the due dates on the exit tasks and reminds IT to move the account expiry dates.

Is CheckFlow free for this template?

+

14-day free trial, no card required. The Business plan is $10 per user per month after the trial. Full details at checkflow.io/pricing.

Every Contractor Starts Right and Leaves on Schedule

Free trial — no credit card required.
