Defect Reporting & Resolution Checklist Template

A defect that costs $1 to address at the design stage costs $10 to rework in production and $100 to manage once it has reached a customer. The structured defect management process is the mechanism that ensures defects are found and addressed as early as possible — every time.

Printed from checkflow.io/templates/quality-assurance/defect-reporting-resolution-checklist

In manufacturing and physical product quality management, defects are inevitable — but the cost of defects is almost entirely determined by where in the production and delivery lifecycle they are detected. The rule of ten — a foundational principle of quality economics — states that a defect found in design costs a unit of effort to fix; the same defect found in production costs ten units; and the same defect found in the field, in the customer’s hands, costs a hundred. This exponential cost structure makes every defect management decision a commercial decision: how quickly was the defect detected, how thoroughly was it contained, how accurately was the root cause identified, and how effectively was the CAPA implemented to prevent recurrence? A structured defect reporting and resolution process addresses all of these systematically — from first detection through to root cause elimination and verified closure. This free checklist gives quality managers, quality engineers, and manufacturing teams a structured framework for the full defect management lifecycle.

Critical, Major, and Minor Defects — Why Classification Determines Every Subsequent Decision

Critical Defects

Critical Defects

Definition: Any defect that poses a safety risk to the end user, is a regulatory non-compliance, or would result in a product recall if it reached the customer.

Examples: Electrical safety failure, structural failure in a load-bearing component, pharmaceutical dosage error, food contamination, absence of required safety marking.

Response: Immediate containment of all affected stock; notification to QA management and, where regulatory requirements apply, to the relevant authority; stop production until root cause is established.

AQL: Zero tolerance — zero critical defects acceptable in any shipment.

Major Defects

Major Defects

Definition: A defect that significantly affects the product’s functionality, performance, or expected useful life, making it unfit for its intended use or likely to cause customer dissatisfaction.

Examples: Dimensional out-of-tolerance affecting fit or function, significant cosmetic defect in a cosmetic product, missing component affecting functionality.

Response: Containment of affected batch; CAPA raised; disposition decision (rework, scrap, or accept with deviation notice); root cause investigation.

AQL: Typically 1.0–2.5% (organisation-defined).

Minor Defects

Minor Defects

Definition: A defect that does not affect function or safety but represents a deviation from specification (cosmetic, minor variation within tolerance range).

Examples: Minor surface scratch on a non-visible surface, slight colour variation within tolerance, minor packaging cosmetic defect.

Response: Log and track; address in next production run; no immediate containment unless frequency exceeds the AQL threshold.

AQL: Typically 4.0–6.5% (organisation-defined).

The Defect Reporting & Resolution Checklist

Six phases covering the full defect lifecycle — from detection and logging through classification, containment, root cause investigation, disposition, CAPA, and verified closure.

  1. Phase 1

    Phase 1: Defect Detection & Initial Logging

    4 tasks

    A defect that is observed but not logged is a defect that cannot be trended, investigated, or used to drive improvement. Every defect — regardless of classification — must be logged when detected.

    • Log the defect immediately — date and time of detection, product or component reference, production batch or lot number, production line or workstation, defect description, and the quantity affected
    • Identify the detection point — where in the production or inspection process was the defect found? Incoming material, in-process, final inspection, or customer return?
    • Record the apparent defect type — dimensional, visual, functional, missing component, contamination, labelling; describe what was observed, not what caused it
    • Photograph the defect — clear photographs of the defective item and the specific defect; essential for investigation and for supplier claims
  2. Phase 2

    Phase 2: Defect Classification & Containment Action

    5 tasks
    • Classify the defect — Critical, Major, or Minor; by the QA engineer or quality manager; against the defined classification criteria
    • For Critical defects: Immediate escalation — QA manager and operations manager notified immediately; stop production if the source is identified
    • Quarantine all potentially affected product — the entire batch, lot, or production run until scope of defect is confirmed; clearly labelled “QUARANTINE — HOLD” with the defect reference; not to be moved without QA authorisation
    • Determine the containment boundary — which batches or production periods could be affected? Check preceding and following batches; check any already-shipped material from the affected period
    • Notify any downstream customers if affected stock may have shipped — for Critical and Major defects; promptly; with a preliminary description and the containment action being taken
  3. Phase 3

    Phase 3: Root Cause Investigation

    5 tasks
    • Gather all relevant process data — for the production period when the defective product was made; machine settings, operator records, material batch data, environmental conditions
    • Select the root cause analysis method — 5 Whys for straightforward cases; Ishikawa diagram (fishbone) for multi-factor causes; 8D Problem Solving for complex or recurring defects; FMEA review if a risk was not adequately controlled
    • Conduct the root cause analysis — with the relevant operators and engineers; seeking the systemic cause, not individual blame
    • Confirm the root cause — with evidence; a hypothesised root cause should be verified through process reconstruction or data analysis before corrective action is designed
    • Document the root cause finding — clearly, specifically, and with the supporting evidence; this is the basis for the corrective action
  4. Phase 4

    Phase 4: Disposition Decision for Affected Product

    5 tasks
    • Quality engineer or manager makes the disposition decision — for all quarantined product; documented; authorised at the appropriate level
    • Use-as-is — if the defect is within tolerance or agreed with the customer; with a formal deviation notice; documented
    • Rework — if the defect can be corrected to within specification; rework instructions issued; all reworked product re-inspected before release
    • Scrap — if the defect cannot be corrected or if rework cost exceeds the product value; scrapped product controlled and disposed to prevent re-entry into stock
    • Return to Supplier (RTS) — if the defect is attributable to supplied materials or components; documented claim raised against the supplier
  5. Phase 5

    Phase 5: Corrective & Preventive Action (CAPA)

    4 tasks

    A corrective action that addresses only the symptom — reworking the defective batch — is not a CAPA; it is a disposition. A CAPA addresses the root cause to prevent recurrence. A preventive action expands the scope to prevent the same root cause from producing a defect in a similar process.

    • Define the corrective action — the specific change to the process, procedure, equipment, or training that addresses the root cause; assigned to a named owner with a completion date
    • Define the preventive action — is the same root cause present in other products, lines, or processes? The preventive action addresses these before a defect occurs
    • Implement the corrective action — update the relevant SOP or work instruction; retrain the affected operators; adjust equipment settings; add a control point to the inspection plan
    • Verify effectiveness — the corrective action is not closed until it is demonstrated to have prevented recurrence; monitor the process for a defined period after implementation
  6. Phase 6

    Phase 6: Defect Closure & Trend Analysis

    4 tasks
    • Close the defect record — once: quarantine released; disposition completed; root cause confirmed; CAPA implemented and verified; all documentation complete
    • Release quarantined product — only after QA authorisation; never before disposition is documented
    • Update defect metrics — defect rate for the period; by classification, product family, and process area
    • Review defect trends monthly — are the same defect types recurring? Is the same process area or supplier generating a disproportionate share? Input to the continuous improvement programme

The Difference Between Disposition and CAPA — Why Both Are Required

Disposition is the decision about what to do with the defective product — rework it, scrap it, accept it with a deviation, or return it to the supplier. Disposition is a reactive action; it addresses the specific affected batch. A quality management system that only does disposition will process the same defect repeatedly, because the process that produced it has not changed.

CAPA is the process that changes the system to prevent recurrence. The corrective action addresses the specific root cause of the current defect. The preventive action applies the learning to other products, lines, or processes where the same root cause could apply, before those defects occur. ISO 9001 requires an effective CAPA process and assesses its implementation as a core element of any quality management system audit. A disposition without a CAPA is quality management activity without quality improvement.

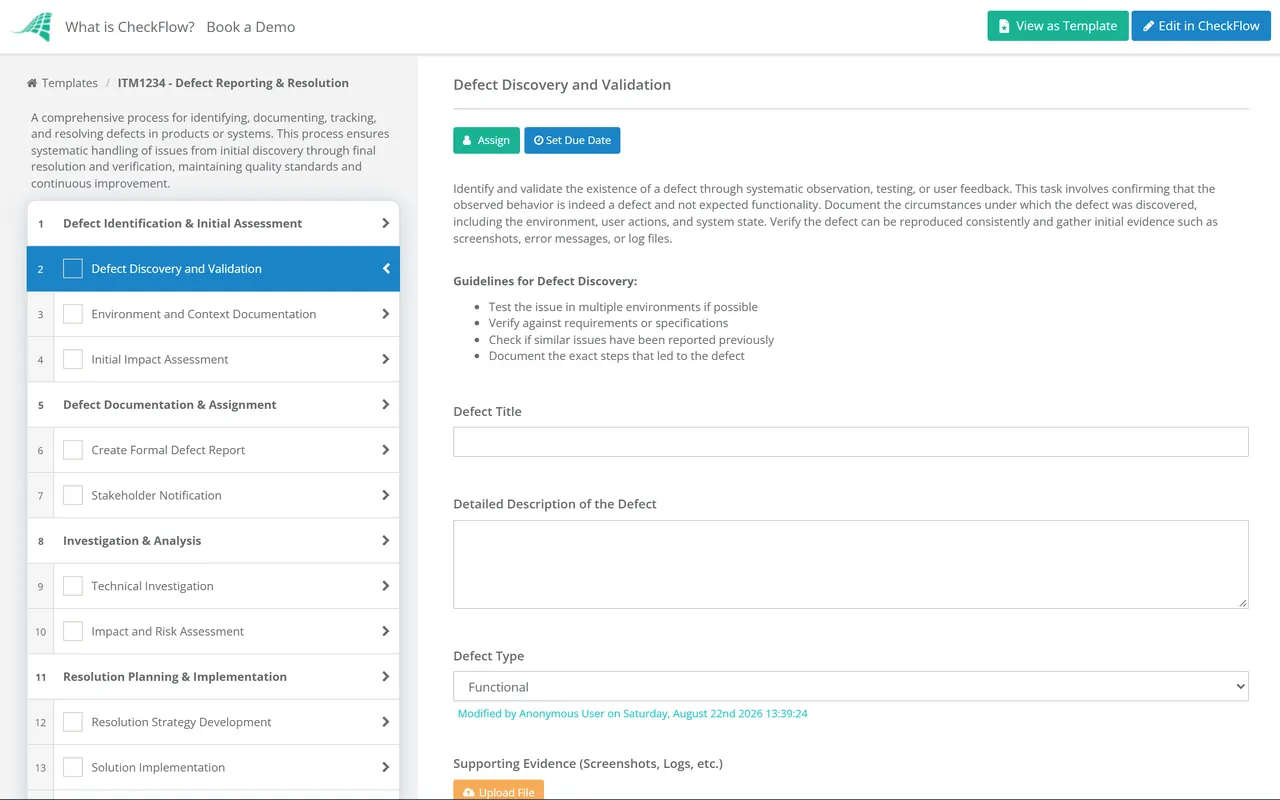

Why Run Your Defect Management Process in CheckFlow?

1

Every defect logged with all required information from detection

A defect report that arrives without the batch number, the production date, or a photograph of the defect is a defect report that cannot be investigated. CheckFlow’s defect intake phase requires every field — product reference, batch, detection point, defect description, and photograph — before the report can progress to triage.

2

CAPA tracked through to verified effectiveness

The CAPA that is closed when the corrective action is implemented — rather than when its effectiveness is verified — is the CAPA that fails ISO 9001 audit and allows the same defect to recur. CheckFlow’s CAPA phase requires an effectiveness verification task before the defect record can be closed.

3

Defect trend data built automatically as the process runs

Monthly defect trend analysis — which product families, which process areas, which suppliers are generating the most defects — is the input to the quality improvement programme. CheckFlow builds this data automatically as defect records are created and closed, producing the trend analysis without additional manual reporting effort.

Defect trends feed the continuous improvement cycle. CheckFlow’s Continuous Improvement Cycle Checklist covers the PDCA process for turning defect data into systemic process improvement. See the Continuous Improvement Cycle Checklist →

Manufacturing defect reporting connects to supplier performance management. CheckFlow’s Supplier Performance Evaluation Checklist in the Procurement & Supply Chain series covers the structured supplier quality review process. See the Supplier Performance Evaluation →

AI generator

Didn’t find what you need? Describe it.

Describe the process in a sentence and the AI checklist generator drafts the phases and tasks for you.

Frequently Asked Questions

What should a defect reporting and resolution process include?

A defect reporting and resolution process covers six phases: detection and logging (immediate logging with batch reference, detection point, defect description, and photographs), classification and containment (Critical/Major/Minor classification, quarantine of affected product, downstream notification for Critical and Major defects), root cause investigation (process data review, root cause analysis using 5 Whys or fishbone, root cause confirmed with evidence), disposition decision (use-as-is with deviation, rework, scrap, or return to supplier — QA-authorised), CAPA (corrective action addressing root cause, preventive action covering similar processes, implementation and effectiveness verification), and closure and trend analysis (defect record closed after CAPA verification, metrics updated, trends reviewed monthly).

What is CAPA and why is it required?

CAPA stands for Corrective and Preventive Action. A corrective action addresses the specific root cause of a non-conformance or defect to prevent its recurrence. A preventive action proactively addresses the same root cause in similar products, processes, or lines before a defect occurs. ISO 9001 clause 10.2 requires organisations to react to non-conformances, take action to control and correct them, deal with the consequences, and eliminate root causes. A common CAPA failure mode is closing the corrective action when it is implemented rather than when its effectiveness is verified — a distinction that ISO 9001 auditors specifically assess.

What does AQL mean in product quality management?

AQL (Acceptable Quality Level) is the maximum percentage of defective units in a batch that is still considered acceptable for release. AQL is used in statistical sampling-based inspection — rather than inspecting every unit, a statistically representative sample is drawn, and the batch is accepted or rejected based on whether the number of defects in the sample falls within the AQL threshold. Different AQL levels are applied to different defect classifications: zero AQL (zero tolerance) for Critical defects; a low AQL (typically 0.65–1.0%) for Major defects; a higher AQL (typically 2.5–6.5%) for Minor defects. The specific AQL thresholds should be defined in the product’s quality plan or agreed with the customer.

How is a manufacturing defect different from a software bug?

A manufacturing defect is a non-conformance in a physical product — a dimensional deviation, a cosmetic flaw, a missing component, a functional failure — that occurs during or after the production process. Management involves physical containment of affected stock, disposition decisions (rework, scrap, return), and often supplier claims or customer notifications. A software bug is a defect in code that causes incorrect or unexpected behaviour in software. Management involves reproduction in a test environment, code investigation, a code fix, code review, and deployment of the fix. See CheckFlow’s Bug Tracking & Resolution Checklist for the software defect management process.

Is CheckFlow free for this template?

You can start a free 14-day trial with no credit card required, giving you full access to all features including this template. The Business plan is $10 per user per month after the trial. Full details at checkflow.io/pricing.

Contain Every Defect Early, Find Every Root Cause, Close Every CAPA — With a Record That Survives Audit

Free trial — no credit card required.

14-day free trial, no credit cardFull refund in your first 30 daysUS hosting, EU on request
