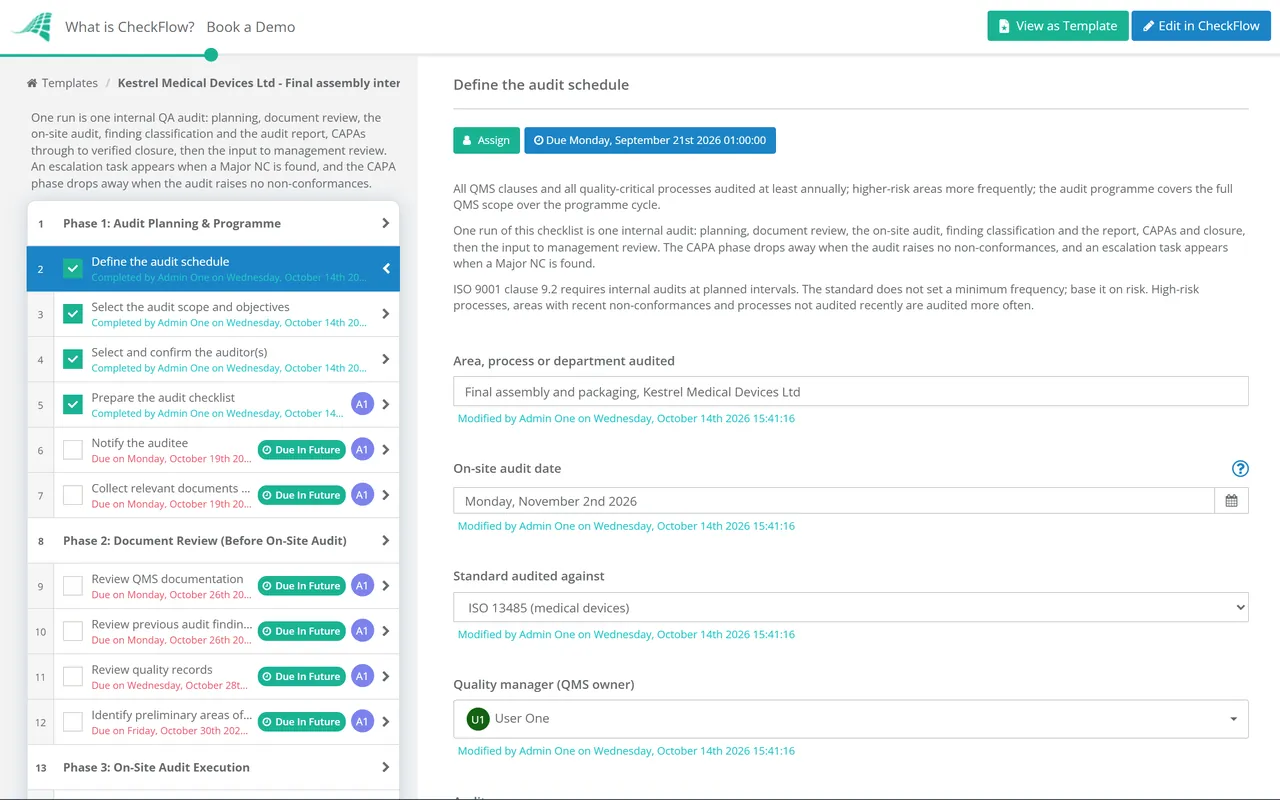

QA Compliance Audit Process Checklist Template

An internal QA audit that finds no non-conformances is not necessarily a successful audit — it may be an audit that did not look hard enough. The purpose of the internal audit is to find problems before the external auditor does.

Printed from checkflow.io/templates/quality-assurance/qa-compliance-audit-checklist

The internal quality audit is the quality management system’s self-assessment mechanism — the structured process by which the organisation verifies that its quality processes are being followed, are effective, and comply with the applicable standard. ISO 9001 clause 9.2 mandates internal audits at planned intervals. Every major quality certification — ISO 9001, ISO 13485 (medical devices), IATF 16949 (automotive), AS9100 (aerospace) — requires a systematic internal audit programme. But the audit’s value depends entirely on whether it is conducted with genuine rigour: auditors who ask the right questions, verify claims with evidence rather than accepting assertions, and classify findings accurately enough to reflect the true state of the system. An internal audit programme that consistently finds only minor observations in a system that an external auditor subsequently flags for major non-conformances has failed its primary purpose. This free checklist gives quality managers, internal auditors, and QMS teams a structured framework for the full QA compliance audit lifecycle. Short, frequent checks of the process controls on a production line run in the Layered Process Audit (LPA) Checklist.

Major Non-Conformance, Minor Non-Conformance, and Observation — Why the Classification Determines the Response

Major Non-Conformance

Major Non-Conformance (MNC)

Definition: A failure to meet a specific QMS requirement in a way that is systemic, is likely to significantly affect product quality or customer satisfaction, or that would result in a major finding in an external audit.

Examples: No documented inspection procedure for a high-risk process; CAPA process not followed for documented non-conformances; management review not conducted in the past 12 months; significant traceability gap.

Required response: CAPA raised and implemented before external audit; root cause identified and addressed.

Minor Non-Conformance

Minor Non-Conformance (MnNC)

Definition: An isolated failure to follow a documented procedure, or a single instance of a process not meeting a requirement, without systemic implications.

Examples: One inspection record with missing inspector signature; one training record not updated; a procedure reference in an SOP pointing to a superseded document version.

Required response: Corrective action to address the specific instance; root cause investigation if the same type of issue recurs.

Observation / OFI

Observation / Opportunity for Improvement (OFI)

Definition: A situation that does not represent a non-conformance but that could potentially become one, or that presents an opportunity to improve the effectiveness of the QMS.

Examples: An inspection process that is being followed but whose effectiveness is not being measured; a procedure that is technically compliant but so difficult to follow that compliance is inconsistent.

Required response: Noted in the audit report; reviewed in the next management review; a PDCA cycle may be initiated.

The QA Compliance Audit Process Checklist

Six phases covering the full internal audit lifecycle — from programme planning and document review through on-site execution, finding classification, CAPA generation, and management review input.

  1. Phase 1

    Phase 1: Audit Planning & Programme

    6 tasks
    • Define the audit schedule — all QMS clauses and all quality-critical processes audited at least annually; higher-risk areas more frequently; the audit programme covers the full QMS scope over the programme cycle
    • Select the audit scope and objectives — for this specific audit; which clauses, processes, and departments are in scope?
    • Select and confirm the auditor(s) — auditors must be independent of the area being audited; trained and competent as internal auditors (ISO 19011 provides guidance)
    • Prepare the audit checklist — question sets for each clause and process in scope; designed to verify compliance with evidence, not just confirm what the auditee says
    • Notify the auditee — scope, date, time, and documents or records the auditor will need to review
    • Collect relevant documents for review — SOPs, work instructions, previous audit reports and CAPAs, training records, inspection records; relevant to the audit scope
  2. Phase 2

    Phase 2: Document Review (Before On-Site Audit)

    4 tasks
    • Review QMS documentation — SOPs and work instructions for the audited processes; are they current, approved, and version-controlled?
    • Review previous audit findings — were the non-conformances from the last audit in this area addressed? Are CAPAs closed and verified as effective?
    • Review quality records — inspection reports, defect logs, CAPA records, training records; do they indicate systematic compliance or systematic gaps?
    • Identify preliminary areas of focus — from the document review; areas of concern that warrant specific attention in the on-site audit
  3. Phase 3

    Phase 3: On-Site Audit Execution

    5 tasks

    The audit is a verification exercise. Claims made by the auditee about their processes must be verified against objective evidence — records, observations, and data — not accepted at face value. “We always do it that way” is not objective evidence.

    • Opening meeting — with the area’s management team; confirm the audit scope, objectives, and approach; explain how findings will be classified; set a professional and constructive tone
    • Audit each process in scope — using the prepared question set; asking open questions (“show me how this is done”, “can you show me an example record”); observe the process in action where possible
    • Verify all claims with objective evidence — “we have a procedure for that”: ask to see it and confirm it is current; “all operators are trained”: check training records for recent new starters
    • Record preliminary findings — in real time; the specific evidence observed or record reviewed that supports each finding
    • Closing meeting — summarise the preliminary findings with the auditee management; allow the auditee to correct any factual errors in the auditor’s observations before the final report
  4. Phase 4

    Phase 4: Finding Classification & Audit Report

    4 tasks
    • Classify each finding — Major NC, Minor NC, or OFI; consistently and objectively against the classification criteria
    • Write the audit report — within 5 working days of the audit; each finding stated with: the requirement breached, the objective evidence found, and the classification
    • Issue the audit report — to the auditee and the QMS owner; the auditee acknowledges receipt
    • Escalate Major NCs immediately — to the quality manager and relevant senior management; an immediate interim action may be required
  5. Phase 5

    Phase 5: CAPA Generation & Finding Closure

    4 tasks
    • Auditee raises CAPA for each NC — with root cause, corrective action, responsible person, and target date; for Major NCs: within 2 weeks; Minor NCs: within 4 weeks
    • Auditor reviews and approves the CAPA — is the root cause analysis adequate? Is the corrective action proportionate and likely to be effective?
    • Verify CAPA effectiveness — at the completion date; the auditor or a designated verifier confirms the action was implemented and the non-conformance has been addressed
    • Close the finding — only after effectiveness is verified; findings with effective CAPAs closed in the audit record
  6. Phase 6

    Phase 6: Management Review Input

    2 tasks
    • Audit summary presented to management review — ISO 9001 clause 9.3 requires management review inputs to include the results of audits; summary of findings by classification; CAPA status; trend over multiple audit cycles
    • Trend analysis — are the same clauses or processes generating recurring findings? Is the overall non-conformance rate improving? This trend is the measure of the QMS’s maturity
