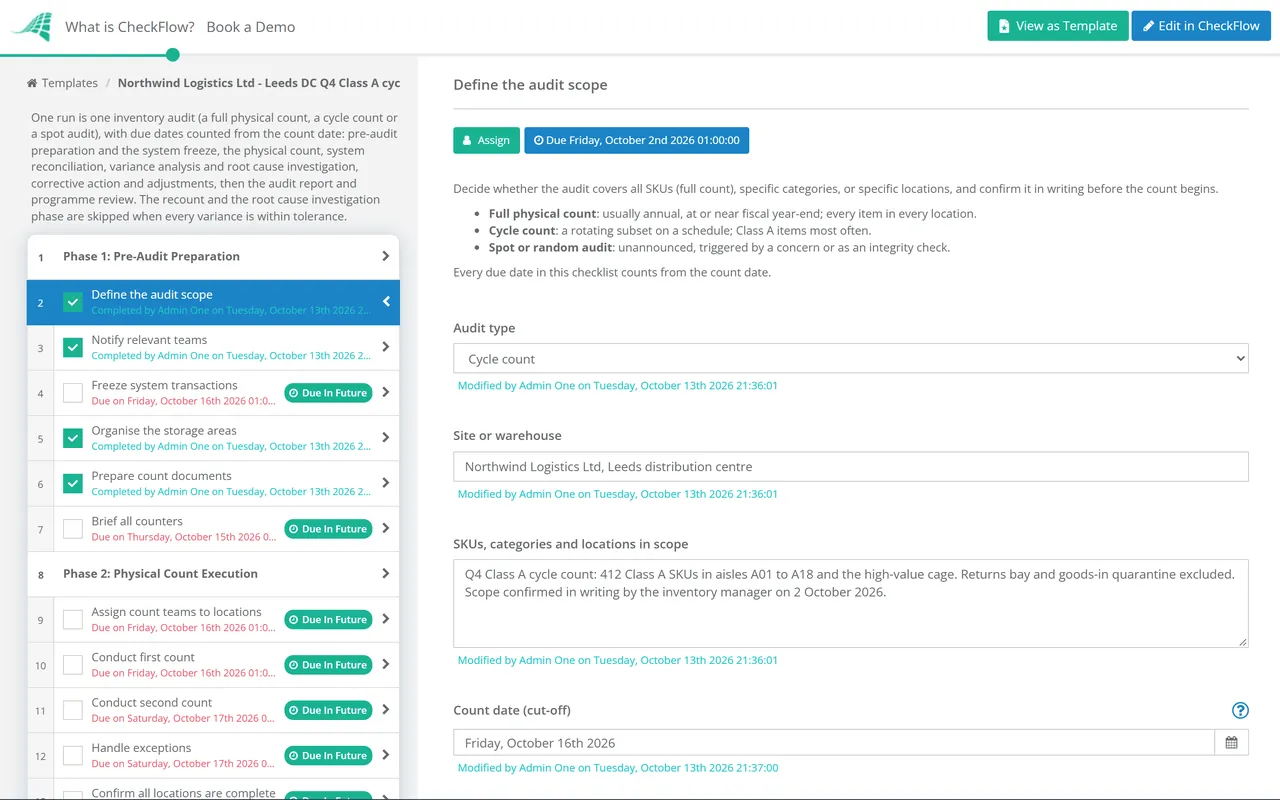

Inventory Audit Process Checklist Template

Inventory that the system says is there but physically is not is phantom inventory. Phantom inventory inflates asset values, overstates profits, and produces stockouts that no forecast predicted. A structured inventory audit finds it before the external auditors do.

Printed from checkflow.io/templates/procurement-supply-chain/inventory-audit-checklist

Inventory inaccuracy is one of the most pervasive and financially consequential operational problems in commerce. Stock discrepancies affect cost of goods sold calculations, working capital reporting, and financial statement accuracy. In operations, phantom inventory — stock showing in the system that does not physically exist — triggers production or fulfilment decisions against stock that is not available, producing failures that appear at the worst possible moment: when a customer order cannot be fulfilled or a production run cannot start. The global Inventory Management Solutions market is expected to reach nearly $5 billion by 2033, driven by organisations that have discovered how expensive inaccurate inventory is. A structured inventory audit process systematically closes the gap between what the system says and what is physically present — through disciplined pre-audit preparation, a controlled physical count, systematic reconciliation against system records, and rigorous root cause investigation for every material variance. This free checklist gives inventory managers, warehouse teams, and finance staff a structured framework for the full inventory audit lifecycle.

Full Physical Count, Cycle Count, and Spot Audit — When to Use Each

Full Physical Inventory Count

When
Annually; typically at or near fiscal year-end or at the end of a financial quarter. Also triggered by major system migrations or suspected significant loss.
What happens
All operations typically halt (or shift to a defined cut-off point) while every item in every location is physically counted against the system record.
Best for
Complete accuracy verification; financial reporting purposes; establishing a clean baseline for the next cycle.
Drawback
Most disruptive and resource-intensive audit type.

Cycle Count Audit

When
Continuously throughout the year on a defined schedule. A-class inventory counted most frequently (monthly/quarterly), B-class less often, C-class annually.
What happens
A defined subset of inventory is counted on a rotating schedule; discrepancies investigated immediately; the annual full count is largely replaced by a high-confidence continuous cycle.
Best for
Maintaining high inventory accuracy throughout the year without the disruption of annual full counts.
Best practice
All high-value or operationally critical items should be cycle-counted at least quarterly.

Spot / Random Audit

When
Unannounced; triggered by specific concerns (suspected theft, process change, new personnel, or anomalous system data), or as a random integrity check.
What happens
A specific category, location, or SKU range is counted without advance notice.
Best for
Testing process integrity; investigating specific concerns; deterring systematic shrinkage.
Note
The unannounced nature is operationally valuable — it tests whether the count reflects actual conditions rather than the result of pre-audit corrections.

What the Inventory Audit Process Checklist Covers

Six phases covering the complete inventory audit lifecycle — from pre-audit preparation through physical count execution, reconciliation, variance investigation, corrective action, and audit reporting.

  1. Phase 1

    Pre-Audit Preparation

    6 tasks

    The quality of an inventory audit is determined largely in the preparation phase. Counts that begin without a frozen system, organised locations, and trained counters produce data that cannot be trusted.

    • Define the audit scope — all SKUs (full count), specific categories, or specific locations; confirmed in writing before the count begins
    • Notify relevant teams — warehouse, operations, and finance of the audit date, scope, and any operational implications (partial or full operational halt)
    • Freeze system transactions — at the defined cut-off date and time; no receipts, issues, transfers, or adjustments processed during the count; this is the most critical preparation step
    • Organise the storage areas — stock tidied and organised by location; all items clearly labelled and in their assigned locations; items in transit clearly segregated and handled per the cut-off rules
    • Prepare count documents — count sheets or mobile count devices; listing location, SKU, and unit of measure without showing system quantity (blind count)
    • Brief all counters — counting methodology, how to handle exceptions (damaged, unlabelled, in transit), and who to contact with questions; every counter uses the same method
  2. Phase 2

    Physical Count Execution

    6 tasks
    • Assign count teams to locations — each location or zone assigned to a specific count team; two-person teams where possible (one counts, one records)
    • Conduct first count — systematically, location by location; each item counted and recorded; no reference to system quantities until the reconciliation phase
    • Conduct second count — all items or all items above the defined value threshold; independently of the first count; discrepancies between first and second count resolved before moving to reconciliation
    • Handle exceptions — damaged stock (count and tag separately); unlabelled items (investigate and tag before counting); items in transit or quarantine (per cut-off rules)
    • Confirm all locations are complete — before releasing the count; no location skipped or partially counted
    • Re-open system transactions — only after all count sheets are collected and confirmed complete
  3. Phase 3

    System Reconciliation

    4 tasks
    • Enter count data — into the inventory management system or reconciliation spreadsheet; all count quantities entered against the system quantity at the cut-off
    • Identify all variances — every SKU where the count quantity differs from the system quantity; presented as unit variance and value variance
    • Apply the variance tolerance filter — variances within the defined tolerance (e.g. ±1% by value or ±2 units for low-value items) may be adjusted without root cause investigation; variances above tolerance require investigation
    • Confirm count accuracy for high-value variances — before investigating; a recount of items with significant variances by a different count team
  4. Phase 4

    Variance Analysis & Root Cause Investigation

    4 tasks

    The recount is the integrity check; the root cause investigation is where the value lies. An inventory variance that is adjusted without investigation is a problem that will recur. An investigation that identifies the cause enables the fix.

    • Categorise each material variance — by likely cause type: counting/recording error, unreported damage/obsolescence, theft/shrinkage, data entry error in receipts or issues, transaction cut-off error, or location error (item in wrong location)
    • Investigate each significant variance — reviewing transaction history for the SKU in the relevant period; checking goods receipt records, issue records, and transfer records
    • Identify systemic issues — variances clustering in specific locations, suppliers, categories, or time periods may indicate a process failure rather than individual error
    • Document findings — for each material variance: probable cause, evidence, and recommended corrective action
  5. Phase 5

    Corrective Action & Inventory Adjustment

    4 tasks
    • Raise inventory adjustment transactions — for each variance; approved by the finance lead or inventory manager; with the root cause code attached
    • Confirm the financial impact — total value of adjustments; reviewed by finance; material variances may require disclosure in financial reporting
    • Implement corrective actions for systemic issues — process changes that address the root cause; assigned to a named owner with a deadline
    • Update the cycle count schedule — for SKUs with material variances; increase frequency until accuracy is demonstrated
  6. Phase 6

    Audit Report & Programme Review

    4 tasks
    • Prepare the inventory audit report — audit scope and date; number of SKUs counted; total inventory value audited; variance summary (number and value of variances by category); accuracy percentage; root causes identified; corrective actions raised
    • Calculate inventory accuracy percentage — (SKUs with no material variance / total SKUs counted) × 100; target 95%+ for Class A items; trend tracked over time
    • Present to finance and senior management — for material variances and systemic findings
    • Review the audit programme — was the audit scope appropriate? Were there enough counters? Should cycle count frequency be adjusted? Were corrective actions from the last audit implemented?

Why Inventory Accuracy Is a Financial Statement Issue — Not Just an Operations Issue

For any company that holds physical inventory, the inventory balance on the balance sheet is a direct function of the accuracy of the inventory records. Phantom inventory — stock that appears in the system but does not physically exist — inflates the asset value and understates the cost of goods sold, overstating profit. Unrecorded shrinkage or damage produces the same distortion. For companies with audited financial statements, external auditors typically perform or observe physical inventory counts as a standard audit procedure precisely because inventory misstatement is a common and material financial reporting risk.

Beyond financial reporting, inventory inaccuracy drives operational costs that accumulate silently: emergency procurement when stock that shows as available is not actually present, production stops when raw material shortfalls appear at the line, and customer service failures when committed stock cannot be fulfilled. A structured inventory audit programme that maintains high accuracy prevents all of these — and the operational and reputational costs are almost always more significant than the audit resource.

Why Run Your Inventory Audit in CheckFlow?

1

A structured count process that every counter follows identically

Inventory audits that produce different results depending on who does the count are audits that cannot be trusted. CheckFlow’s inventory audit checklist provides every counter with the same structured sequence — system freeze, blind count, double count, exception handling — ensuring consistent methodology regardless of who conducts the count.

2

Variance investigation tracked through to corrective action closure

An inventory variance that is adjusted in the system without a root cause investigation will recur at the next audit. CheckFlow assigns each material variance an investigation task to a named owner with a deadline, and tracks the corrective action through to confirmed implementation.

3

A complete audit record for financial and compliance purposes

External auditors and regulators who ask for evidence of a systematic inventory audit programme — when it was conducted, how many SKUs were counted, what variances were found, and what corrective actions were taken — receive a complete documented record from every audit conducted through CheckFlow.

Inventory audit findings often reveal procurement process failures — orders received without goods receipt transactions, or goods issued without matching POs. CheckFlow’s Purchase Order Approval Checklist covers the PO controls that prevent many inventory discrepancies. See the Purchase Order Approval Checklist →

Procurement compliance reviews cover inventory management controls as part of the broader procurement audit. CheckFlow’s Procurement Compliance Review covers the full procurement audit framework. See the Procurement Compliance Review →

Inventory audit is one of the strongest use cases for recurring checklists — cycle counts run on a schedule, full counts run annually. CheckFlow’s recurring checklist feature starts each count automatically at the right cadence. Learn about recurring checklists →
